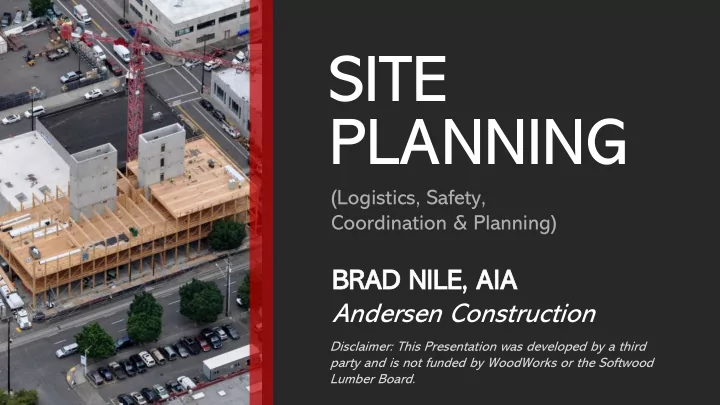

SITE PLANNING
BRAD NIL ILE, AIA IA
Andersen Construction
(Logistics, Safety, Coordination & Planning)
Disclaimer: This Presentation was developed by a third party and is not funded by WoodWorks or the Softwood Lumber Board.
SITE PLANNING (Logistics, Safety, Coordination & Planning) - - PowerPoint PPT Presentation
SITE PLANNING (Logistics, Safety, Coordination & Planning) BRAD NIL ILE, AIA IA Andersen Construction Disclaimer: This Presentation was developed by a third party and is not funded by WoodWorks or the Softwood Lumber Board. BRAD NIL
BRAD NIL ILE, AIA IA
Andersen Construction
(Logistics, Safety, Coordination & Planning)
Disclaimer: This Presentation was developed by a third party and is not funded by WoodWorks or the Softwood Lumber Board.
1970s 1980s 1990s 2000s 2010s
BRAD NIL ILE 5 decades of building with wood. 35-year construction career.
eautiful build ilding
id construction
inimal sta taging and la laydown nee eeds
ffsite fa fabric rication pote tential fo for r all ll tra trades
THE PROMISE OF MASS TIM IMBER CONSTRUCTION:
District Office • Portland OR
Corvallis, OR
planned jo jobsite
mass ti timber procurement and modeling effo ffort
KEY FACTORS IN IN DELIV IVERIN ING THIS IS PROMISE:
footprint compared to to th the available site.
location and hoisting plan
for materials in in
, debris and recycling management
SIT ITE ORGANIZ IZATION CONSID IDERATIO IONS:
District Office • Portland, OR
Total perimeter accessibility prepared for crane & facade access
Corvallis, OR
No available site - all access via sidewalk & street closures.
Portland, OR
No available site, except an easement just big enough for a tower crane. CRANE PLAN
CRANE PLAN
DOWNTOWN SITE
sidewalk closure and part time street closure.
positioning flexibility and after-hours tuck away.
PRE-CONSTRUCTION SIT ITE CONSIDERATIONS:
Street t an and sid idewalk clos losures
trian prote tecti tion
No-fly zones
ting ob
tructi tions: ✓ Overhead pow
lines ✓ Tr Trees ✓ Nei eighboring buildings ✓ Fa Facade ac access ✓ Uti tility con
tions
Jurisdictional requirements and readymade options PEDESTRIAN PROTECTIO ION
Trees, Power Lines and No-fly zones HOIS ISTING OBSTRUCTIONS
FACADE ACCESS EXAMPLES
TI TIMBER PROCUREMENT PRE- CONSTRUCTION CONSIDERATIONS:
SC SCHEDULE
DEL ELIVERY PLANNING
TRUCK LOADING, SEQUENCE & CADENCE PLANNING
(CLT LOAD MODELING EXAMPLE)
FLY FROM TR TRUCK MODELING & LOADING
Essepi Systemi X-Lam Near Trento Italy
Hardware & Center of Gravity Locating
HOISTING & RIGGING PROVISIONS
MOISTURE MIT ITIGATION PLANNING
What to remember…
Factory Sealers. Stain Control Moisture Control Dry-out planning Finishing
MOISTURE MANAGEMENT PLAN SUMMARY
All CLT Ends, edges and cuts. UV protection on all beams and columns.
Only galvanized, aluminum or powder coated connectors. NO cutting of steel around raw wood. Remove all wrapping once on site.
Adhesive tape at all joints and seams. Regular bulk water removal and management. Critical connection protection,.
AIR CIRCULATION (With no heat.) Add heat slowly only after surface drying is complete. Add humidity with heat. (With monitoring.) 14% moisture content MAX prior to any timber cover.
the structure is underway
(B (BEYOND THE STRUCTURE)
WORKER SAFETY PROVISIONS: HAVE A PLAN!
THE 1978 PLAN:
San Jose, CA Dinwiddie Construction
THE 1986 PLAN:
✓ Demolish an and re rebuild fac facade el elements ON TH THE GROUND!
THE 2019 PLAN:
✓ Maximize off
fabricati tion - Pre refabricated Fa Facade Panels
Maximize Off-site Fabrication - Plumbing and Piping Systems.
Newport, OR
Working the plan: Prefabricated Wall Elements, shop installed roof vapor barrier.
Working the plan: Ground Installed Edge Protection
North Greenwich, UK North Greenwich, UK
CONCLUSION
Plan early and continuously.
Model everything.
Maximize off-site fabrication
(Beyond the Structure).
EXCELLENT EXAMPLES OUTSIDE THE USA:
Brock Commons, UBC Urban One, Structurlam, Seagate Vancouver, British Columbia
EXCELLENT EXAMPLES OUTSIDE THE USA:
Swatch Omega Headquarters Blumer Lehmann, Gossau, Switzerland
BRAD NIL ILE, AIA IA
Andersen Construction
bnile@andersen-const.com
