Public Involvement Meeting January 30, 2018 WisDOT North Central Region Jim Volkmann, P.E. Project Manager EMCS, Inc. Stephanie Christensen, P.E. Consultant Designer Project location Project purpose and need


slide-1
SLIDE 1

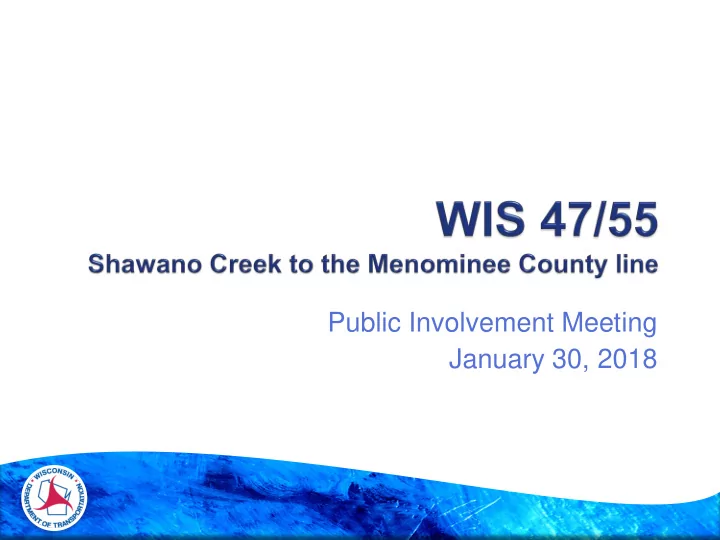

Public Involvement Meeting January 30, 2018

slide-2
SLIDE 2

 WisDOT North Central Region

  • Jim Volkmann, P.E. – Project Manager

 EMCS, Inc.

  • Stephanie Christensen, P.E. – Consultant Designer
slide-3
SLIDE 3

 Project location  Project purpose and need  Proposed improvements  Real estate needs  Construction staging  Current project schedule  Discussion

slide-4
SLIDE 4
slide-5
SLIDE 5

 WIS 47/55 importance

  • Regional route for truck and passenger vehicles
  • Primary link from the Menominee Reservation to the

city of Shawano

  • Marked bicycle route between Old Lake Road and

Curt Black Road

 WisDOT’s objective is to ensure the safe and

efficient operations of the state’s highway system while supporting local access

slide-6
SLIDE 6

 Identified needs

  • Deteriorating pavement (resurfaced in 2000)
  • Deteriorating railroad crossing surface with need for

improved signals and new gates

  • Curb ramps do not meet ADA (Americans with

Disabilities Act) requirements

  • Guardrails, signing, and pavement marking do not meet

current standards

  • Some curb and gutter, inlets, and culverts require repair
slide-7
SLIDE 7
  • The absence of turn lanes at some intersections results

in conflicts between turning and through traffic

  • The existing 3-foot paved shoulders do not adequately

accommodate bicycles or pedestrians

slide-8
SLIDE 8

 Improvements recommended to keep traffic

moving safely and efficiently

  • Resurface WIS 47/55 and pave 5-foot shoulders
  • Replace the railroad crossing surface and install new

signals and gates

  • Reconstruct all curb ramps to meet ADA requirements
  • Repair spot locations of curb and gutter
  • Replace guardrails and two drainage culverts
slide-9
SLIDE 9
  • Install new signing, pavement marking, and centerline

rumble strips

  • Modify intersections to improve traffic flow and

efficiency  County H and Maple Avenue  Frailing Lane  County A

slide-10
SLIDE 10

 County H and Maple Avenue conditions

  • Transition from high speed to lower speed urban area
  • Speed limit lowered to 40 mph in 2014 to maintain safety
  • Crash rates are not growing

 8 crashes (2007 to 2011)  8 crashes (2011 to 2015)

  • Crash rates do not warrant changing intersection control

(i.e. signals, roundabout, all-way stop)

  • Intersection modifications proposed to improve traffic flow

and efficiency

slide-11
SLIDE 11

 County H and Maple Avenue upgrades

  • Widen the roadway and install pavement markings to

accommodate turning traffic  Southbound left-turn lane at County H  Northbound left-turn lane at Maple Avenue

  • Complete tree clearing to improve sight distance

looking north from County H

slide-12
SLIDE 12

County H and Maple Avenue

Maple Ave Old Keshena Rd Elm Ave

slide-13
SLIDE 13

 Frailing Lane conditions

  • Lack of properly marked turn lanes (2 to 4 lanes)
  • Driveways near the intersection can cause confusion

between through and turning traffic

 6 crashes (2011 to 2015)

 County A bypass and turn lanes

  • Do not meet current design standards (length and tapers)
  • Do not accommodate a continuous paved shoulder

through the intersection

slide-14
SLIDE 14

 Frailing Lane

  • Widen the roadway and install pavement markings to

accommodate turning traffic

  • The painted median area will improve traffic flow at the

intersection and adjacent commercial entrances

 County A bypass and turn lanes

  • Modify the bypass and turn lanes to meet current design

standards

  • A continuous 5-foot paved shoulder will be provided

through the intersection

slide-15
SLIDE 15

Frailing Lane

slide-16
SLIDE 16

County A

slide-17
SLIDE 17

 Permanent fee and temporary limited easements

  • Intersection modifications
  • Guardrail grading
  • Curb ramp upgrades

 Acquisition process

  • WisDOT will acquire real estate
  • Individual property owner meetings will be held
  • Begin real estate acquisitions in fall 2018
slide-18
SLIDE 18

 Maintaining safety and mobility are important

during construction

 Proposed traffic impacts

  • Single lane closures with flagging conditions
  • One week detour during railroad crossing replacement
  • Shoulder closures in areas of intersections and guardrails
  • Local and emergency access will be maintained
slide-19
SLIDE 19

 Local officials meetings – February 2017 and January 2018  Public involvement meeting – January 2018  Preliminary plans – Spring 2019  Final environmental document – Spring 2018  Final right of way plat – Summer 2018  Right of way acquisition – Fall 2018 to Fall 2019  Final plans – November 2019  Construction – 2020

slide-20
SLIDE 20

 Jim Volkmann, P.E. – WisDOT Project Manager

Jim.Volkmann@dot.wi.gov; 715.365.5773

 Stephanie Christensen, P.E. – Consultant Designer

  • schristensen@emcsinc.com; 715.845.1081

wisconsindot.gov/Pages/projects/by-region/nc/wis47/public.aspx
