Presenting a live 90-minute webinar with interactive Q&A Solar - - PowerPoint PPT Presentation

presenting a live 90 minute webinar with interactive q a
SMART_READER_LITE
LIVE PREVIEW

Presenting a live 90-minute webinar with interactive Q&A Solar - - PowerPoint PPT Presentation

Presenting a live 90-minute webinar with interactive Q&A Solar Energy Projects: Structuring EPC Agreements Navigating Contract Structure Issues, Unique Issues in Solar PV EPCs, Performance Guarantees and Defect Warranties TUESDAY, NOVEMBER


slide-1
SLIDE 1

The audio portion of the conference may be accessed via the telephone or by using your computer's

  • speakers. Please refer to the instructions emailed to registrants for additional information. If you

have any questions, please contact Customer Service at 1-800-926-7926 ext. 10.

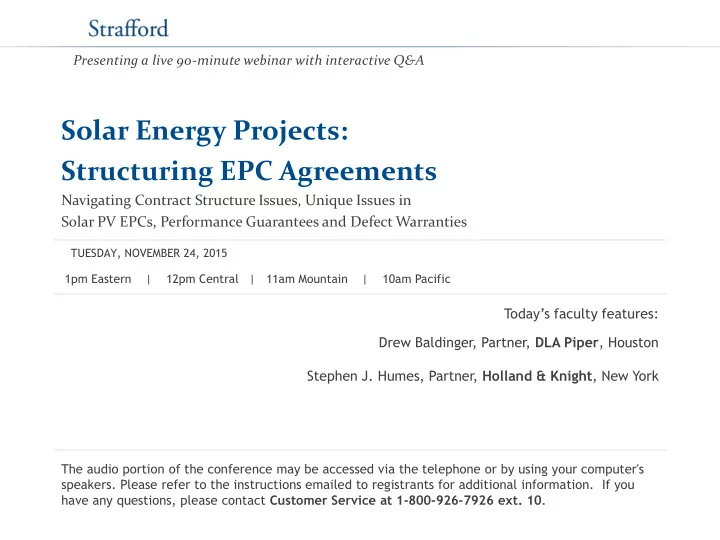

Presenting a live 90-minute webinar with interactive Q&A

Solar Energy Projects: Structuring EPC Agreements

Navigating Contract Structure Issues, Unique Issues in Solar PV EPCs, Performance Guarantees and Defect Warranties

Today’s faculty features:

1pm Eastern | 12pm Central | 11am Mountain | 10am Pacific TUESDAY, NOVEMBER 24, 2015

Drew Baldinger, Partner, DLA Piper, Houston Stephen J. Humes, Partner, Holland & Knight, New York

slide-2
SLIDE 2

Tips for Optimal Quality

Sound Quality If you are listening via your computer speakers, please note that the quality

  • f your sound will vary depending on the speed and quality of your internet

connection. If the sound quality is not satisfactory, you may listen via the phone: dial 1-866-755-4350 and enter your PIN when prompted. Otherwise, please send us a chat or e-mail sound@straffordpub.com immediately so we can address the problem. If you dialed in and have any difficulties during the call, press *0 for assistance. Viewing Quality To maximize your screen, press the F11 key on your keyboard. To exit full screen, press the F11 key again.

FOR LIVE EVENT ONLY

slide-3
SLIDE 3

Continuing Education Credits

In order for us to process your continuing education credit, you must confirm your participation in this webinar by completing and submitting the Attendance Affirmation/Evaluation after the webinar. A link to the Attendance Affirmation/Evaluation will be in the thank you email that you will receive immediately following the program. For additional information about continuing education, call us at 1-800-926-7926

  • ext. 35.

FOR LIVE EVENT ONLY

slide-4
SLIDE 4

Program Materials

If you have not printed the conference materials for this program, please complete the following steps:

  • Click on the ^ symbol next to “Conference Materials” in the middle of the left-

hand column on your screen.

  • Click on the tab labeled “Handouts” that appears, and there you will see a

PDF of the slides for today's program.

  • Double click on the PDF and a separate page will open.
  • Print the slides by clicking on the printer icon.

FOR LIVE EVENT ONLY

slide-5
SLIDE 5

Solar Energy Projects: Structuring EPC Agreements

November 24, 2015

DREW BALDINGER

DLA Piper LLP (US)

STEPHEN J. HUMES Holland & Knight LLP

5

slide-6
SLIDE 6
  • Drew Baldinger has several years of experience representing

developers, financial institutions, electric utilities, private equity, contractors and other investors in the development, construction, operation, acquisition, divestiture, ownership and debt and equity financing of domestic and international energy projects and companies.

  • In particular, Drew has represented domestic and international

developers, electric utilities and investors in connection with various aspects of solar (photovoltaic and thermal), wind and geothermal energy generation projects, conventional energy generation projects and transmission projects, in addition to gas-to-liquids projects and upstream and midstream oil and gas investments.

  • Drew is a partner in the Houston office of DLA Piper LLP (US).

Drew Baldinger

6

slide-7
SLIDE 7
  • Steve Humes practices environmental, energy, public utility and

infrastructure law at Holland & Knight and advises clients on renewable energy regulatory, project finance and development issues, including environmental issues and project contracts. He represents project developers, sponsors and banks on solar PV, biomass, geothermal, and energy storage projects, among other technologies, and represents the Connecticut Green Bank and New York Green Bank along with project owners and developers from New Jersey to California and New York to Nicaragua. He also assists clients with state and federal environmental and energy regulatory compliance and enforcement matters and counsels clients on energy and environmental issues in corporate M&A transactions, including acquisitions and divestitures of fossil and renewable power plants.

  • Steve is based in Holland & Knight’s New York City office.

Steve Humes

7

slide-8
SLIDE 8
  • Introduction to Solar PV Transactions
  • Power Purchase Agreement
  • Owner Buys Turnkey Project
  • Regulatory Considerations (Net Metering vs. Wholesale Power

Project; PPAs vs. Solar Leases; Size Limits)

  • Summary of Key Ancillary Agreements
  • PPA/REC Offtake Agreements
  • Interconnection Agreement
  • Solar PV Panel Module, Racking System and Inverter Supply

Agreement (if applicable)

  • Real Estate Entitlements
  • O&M Agreement

Overview of a Solar PV Project Transaction Structure

8

slide-9
SLIDE 9

State Regulatory Requirements Vary Significantly

  • Distributed Generation: Project is “inside the fence” and

interconnected electrically to host behind the utility meter.

  • Net Metering: Revenue meter tracks electric usage both ways –

when host uses less electricity than solar PV system generates, surplus flows to local electric utility – issue is who gets the credit for surplus power and for how much?

  • DG Size Limits: Could be 2 MW or less; 6 MW or less; or less than

host’s annual consumption needs – states allow utility’s interconnection tariff to limit size of project.

  • EPC Contract: Performance contingent on Interconnection.
  • Interconnection Delays: Utility-specific, contractor experience

Solar Project Regulatory Considerations: Net Metering and Interconnection Issues

9

slide-10
SLIDE 10
  • State and Local Regulations and Compliance Obligations
  • NIMBY Issues (e.g., Wind Farm or Solar Siting)
  • Zoning and Permitting Requirements/Restrictions
  • Access to Rights of Way
  • Existing Easements/Land Use Restrictions
  • Access to the Electrical Grid (Interconnection)
  • Pre-existing Environmental Conditions (e.g., Brownfields,

Landfills)

  • Suitability of Existing Ground Conditions
  • Closure Requirements/Termination Assurances (e.g.,

Restoration of Site)

Owner Site Acquisition Risks

10

slide-11
SLIDE 11

Engineering, Procurement and Construction Agreement (EPC) – the design-build contract between Project Owner (“Owner”) and General Contractor (“Contractor”)

  • Types of EPC Agreements – Contract Structure
  • Wrap vs. No Wrap
  • General Overview on Interplay with Other Agreements
  • Supports PPA Performance and Schedule Obligations
  • Often Relies on Supply Chain Agreements
  • Modules
  • Inverters
  • Racking Systems
  • Often Links Performance Guarantees with O&M Agreement

EPC Agreement Defined

11

slide-12
SLIDE 12

IT’S ALL ABOUT RISK ALLOCATION…

  • CONSTRUCTION
  • Price Risk
  • Permitting Risk
  • Performance Risk
  • Schedule Risk
  • EXCEPTIONS
  • OTHER FINANCING ISSUES

Solar EPC Risk Allocation

12

slide-13
SLIDE 13
  • General:
  • It is unlikely that a sophisticated offtaker will agree to pay for

construction cost overruns through an increase in PPA pricing.

  • Non-recourse construction financings are sized based on PPA pricing,

PPA term and offtaker creditworthiness, with a small contingency to cover construction cost overruns, among other things.

  • Accordingly, lenders will not generally take construction cost risk, and

therefore require that the EPC Agreement be fixed-price, with only limited, customary exclusions that permit price increases.

  • Payment Mechanics:
  • Milestones vs. Schedule of Values
  • Invoice approval process
  • Lien waivers
  • Right to dispute in good faith

Price Risk

13

slide-14
SLIDE 14
  • Exceptions:
  • Equity assumes risk that delays in issuing the Full Notice to

Proceed (“FNTP”) will result in price increases.

  • Negotiate a sufficient time period between execution of EPC

Agreement and the initial drawdown of the construction financing.

  • Negotiate specified price increases for a limited period.
  • Scope of Work
  • Wrapped vs. Unwrapped Risk
  • Owner-Supplied Equipment, Other Owner Obligations and Owner-

Issued Change Orders

  • Permits and Real Property Rights
  • Interconnection Provider
  • Contractor-Issued Change Orders
  • Other Negotiated Exclusions

Price Risk (Con’t)

14

slide-15
SLIDE 15

Permitting Risk

Permits

  • Land use, zoning
  • Building Permits
  • Federal and State Authorizations
  • Environmental
  • Brownfields
  • Closed Landfills
  • Open Landfills – Solar built into

cap/remediation design

15

slide-16
SLIDE 16
  • What is the timeline for issuing permits?
  • Do all timelines match those of leases, PPAs and loan documents?
  • Are public hearings required?
  • Are hearings necessary to gain public support?
  • Who is responsible for obtaining permits?
  • Project Permits are obtained in Owner’s name, but Contractor

typically applies for and pursues applicable permits (with Owner’s cooperation).

  • Since Project Permits typically contain conditions to construction,

Contractor should be directly responsible for satisfying permit conditions.

  • Contractor responsible for permits applicable to Contractor’s

tools, equipment, personnel and operations.

Permitting Risk (Con’t)

16

slide-17
SLIDE 17
  • Will equipment and/or technology fail?
  • Is the site suitable for construction and operation of the

facility?

  • Will EPC contractor fail to complete construction?

Performance Risk

17

slide-18
SLIDE 18

TOOLS TO MANAGE RISK:

  • Who has Permitting Responsibilities? (Deadlines, Cooperation,

Effects of Delay)

  • Liquidated damages for performance
  • E&O/Environmental Insurance
  • Construction/Stop Loss Insurance (controls cost overruns from

unexpected conditions)

  • Credit Support
  • Owner Controlled Insurance Program (OCIP)
  • Environmental Surveys
  • Geotechnical Studies and Surveys
  • Warranties

Performance Risk (Con’t)

18

slide-19
SLIDE 19

Will the Project Be Completed on Time and within Budget?

  • Project development risk is partially allocated to EPC

contractor and insurers – EPC contractor should contractually assume PPA’s COD and related delivery obligations (performance guaranty, minimum system size, etc.)

  • LDs for Failure to achieve
  • Warranties (linkage to O&M Agreement)
  • Conditions Precedent: Interconnection
  • Zoning and Land Use Approvals

Performance Risk (Con’t)

19

slide-20
SLIDE 20
  • Capacity Guaranty:
  • Minimum Guarantied Capacity
  • Achievement of the minimum guarantied capacity is a condition to

substantial completion, resulting in delay liquidated damages if such minimum guarantied capacity is not timely achieved

  • Minimum guarantied capacity supports PPA capacity requirements
  • Guarantied Capacity
  • Failure to achieve the guarantied capacity results in performance

liquidated damages, supporting lost revenue and a buydown of debt

  • Cure Period
  • Period
  • Cooperation
  • True-Up Payment

Performance Risk (Con’t)

20

slide-21
SLIDE 21
  • Adjusted Energy Performance Test:
  • Generally a long-term test (365 days) that occurs multiple times

(1-5) after substantial completion, comparing actual energy performance to expected energy performance.

  • Performance Liquidated Damages
  • Module warranties last longer, but remedy is generally repair,

replacement or supplemental panels.

  • Adjustments are required to remove weather and operational

effects, including for soiling, temperature, force majeure and irradiance.

  • Risk of monitoring equipment inaccuracies increases.
  • Redundancies
  • Calibration requirements

Performance Risk (Con’t)

21

slide-22
SLIDE 22
  • General:
  • A sophisticated offtaker will impose an outside date by which the

facility must be constructed, enforced through payment of delay liquidated damages and eventually resulting in termination of the

  • fftake agreement.
  • The lenders are primarily concerned with a delay in construction

resulting in the PPA being terminated (and potentially lost tax consequences, when applicable).

  • Owner is incurring delay damages, interest during construction

and other fixed costs in the event of a construction delay, and is also foregoing revenue from the sale of power.

  • Accordingly, Owner requires guarantied milestone date(s) from

Contractor, as well as other provisions to mitigate construction schedule risk or otherwise share construction schedule risk with Contractor.

Schedule Risk

22

slide-23
SLIDE 23
  • Guarantied Milestones: The Parties will negotiate guarantied

substantial completion dates for blocks of PV panels (in larger projects) and/or an overall substantial completion date.

  • If Contractor fails to achieve any guarantied milestone date, Contractor

will pay, as Owner’s sole remedy, a daily amount constituting liquidated damages until such milestone is achieved.

  • Sizing delay liquidated damages
  • Costs (in terms of money and schedule)
  • Limitations on Liability/Performance Excuses
  • Delay-In-Startup Insurance
  • Termination: If Contractor is too delayed, Owner may want the right

to:

  • declare a default and terminate the EPC Agreement upon Contractor

missing an outside date; or

  • prospectively declare a default and terminate the EPC Agreement if

Contractor could reasonably be expected to miss an outside date.

Schedule Risk (Con’t)

23

slide-24
SLIDE 24
  • Bonus: Owner may consider offering a bonus for early block

substantial completion or overall substantial completion.

  • Calculation and Limitations
  • Negotiation Strategy
  • Acceleration: Owner usually has the right to issue a change
  • rder accelerating performance under the EPC Agreement.
  • Subcontractor Limitations: The EPC Agreement often

specifies permitted material subcontractors and requires Owner’s consent to change material subcontractors.

  • Other Mitigation: Diligence of Contractor, management team

and labor supply, progress reporting, PPA, others.

Schedule Risk (Con’t)

24

slide-25
SLIDE 25
  • Credit Risk
  • Limitations on Liability
  • Change Order and Force Majeure Provisions
  • Tax Issues
  • Assignment
  • Dispute Resolution and Governing Law

Issues Affecting Owner’s Risk

25

slide-26
SLIDE 26
  • General:
  • From a practical standpoint, the value of a contract is based both
  • n the terms of the contract, and the ability of the parties to

perform the terms of the contract.

  • Lenders want an entity with an investment grade rating from

Moody’s and/or S&P to guarantee the timely construction and performance of the project for a fixed-price in accordance with the EPC Agreement.

  • Also secures other obligations of Contractor under the EPC

Agreement, including warranty obligations

  • Contractor provides the primary warranty, and subcontractor credit

risk may arise after the expiration of that primary warranty

  • Contractor wants to secure Owner’s timely payment of the

contract price (to primarily protect profit margin and payments to third parties).

Credit Risk

26

slide-27
SLIDE 27
  • General: If Contractor as counterparty to the EPC Agreement

is not itself creditworthy, credit support will be required.

  • Forms of Credit Support: Contractor’s credit support is

provided in one or more of the following forms:

  • Payment and Performance Guaranty
  • Payment and Performance Bond
  • Retention (regardless of Contractor’s creditworthiness)
  • Other rights of Owner to withhold payment in defined

circumstances from invoiced amounts under the EPC Agreement

  • Insurance (regardless of Contractor’s creditworthiness)

Contractor Credit Support

27

slide-28
SLIDE 28
  • General: In a non-recourse financing, Contractor will generally

mitigate its concerns regarding Owner’s ability to pay the contract price by:

  • Conditioning FNTP upon the initial drawdown of the construction

financing; and

  • Structuring the milestone payment schedule to include an

upfront down payment at FNTP, as well as “front-weighted” milestones that keep Contractor ahead of its expected costs.

  • Flow through termination provisions in subcontracts
  • Owner will be concerned with ROI for “front-weighted” payments
  • Other Protections: (1) Suspension rights for failure to pay, (2)

limitation on Owner-Issued Change Orders, and (3) mechanics’ liens.

Owner Credit Support

28

slide-29
SLIDE 29
  • General: A separate payment and performance guaranty is

executed by a parent or affiliated company of Contractor simultaneously with the signing of the EPC Agreement.

  • Basic Obligation: Guarantor unconditionally, absolutely and

irrevocably guarantees the full and timely payment of all amounts when due, and performance when due, by Contractor under the EPC Agreement.

  • Limitations:
  • In addition to “joint efforts” drafting clauses, a guaranty will contain

a number of defense waivers.

  • Guarantor reserves any right, counterclaim and defense of

Contractor with respect to the guarantied obligations, other than specified defenses.

  • Monetary and Temporal Limitations and Exceptions
  • Governing Law: New York

Guaranty

29

slide-30
SLIDE 30
  • General: A percentage of each payment is withheld by Owner

as performance security for Contractor’s obligations under the EPC Agreement or a letter of credit is issued in lieu thereof.

  • Release:
  • Most of the retainage is released at substantial completion.
  • Except for amounts needed to complete punchlist items
  • Occasionally, a minimum amount is maintained until final completion
  • Post-substantial completion retainage is generally released as

punchlist items are completed, with the remainder released as of final completion.

  • Except for amounts spent by Owner to complete punchlist items
  • Occasionally, a minimum amount is maintained through the general

warranty period

Retainage

30

slide-31
SLIDE 31
  • Easy execution and provides

liquidity

  • Issued by a financial institution

that is sufficiently qualified

  • Irrevocable for a period of time,

but may be automatically renewed

  • Form of demand typically

attached

  • Draw Conditions

Letter of Credit

31

slide-32
SLIDE 32
  • General: Contractor’s return on investment is not substantial and

thus, Contractor is generally not willing to expose its organization to unlimited risk for one project, in particular in a fixed-price contract with schedule and performance guaranties that are supported by a creditworthy parent.

  • Caps on Liability:
  • Delay Liquidated Damages
  • Performance Liquidated Damages
  • Overall Liquidated Damages
  • Overall Limitation on Liability
  • Before vs. After Substantial Completion
  • Exceptions
  • Third-party claims indemnifiable under the EPC Agreement
  • Gross Negligence/Willful Misconduct/Intentional Fraud
  • Title
  • Insurance

Limitations on Liability

32

slide-33
SLIDE 33
  • Other Waivers:
  • Warranties: Contractor waives all representations and warranties

that are not expressly provided in the EPC Agreement.

  • Exclusive Remedies:
  • Remedies expressly set forth in the EPC Agreement
  • Missing guarantied schedule milestones
  • Missing performance guaranties
  • Consequential Damages: Each Party waives any right to claim

consequential damages under the EPC Agreement.

  • Third-party claims indemnifiable under the EPC Agreement
  • Gross Negligence/Willful Misconduct/Intentional Fraud
  • Liquidated Damages/Termination Payments
  • Others

Limitations on Liability (Con’t)

33

slide-34
SLIDE 34
  • General: Each Party has certain rights to demand a change in

the terms of the EPC Agreement. This includes Contractor’s rights to receive additional time and money based on the

  • ccurrence of specified events (but generally not

modifications to other terms of the EPC agreement).

  • Events:
  • Force Majeure
  • Owner-Cause Delay
  • Change in Law
  • Subsurface Issues
  • Changes in Work Required by Owner
  • Suspension

Change Orders

34

slide-35
SLIDE 35
  • Mechanics: Owner often negotiates for procedural

requirements that, if not strictly followed for a specified event, will result in Contractor losing its rights to a change

  • rder for that event.
  • Thresholds: Owner often negotiates for materiality qualifiers
  • r dollar thresholds that must be exceeded before Contractor

is entitled to a change order for money.

  • Schedule: Owner often negotiates so that Contractor is

permitted a change order for time only if the applicable event affects the critical path and exceeds a threshold of days.

  • Other Requirements and Considerations: (1) Mitigation,

(2) Over-Head Allowances, (3) PPA, (4) Lump-Sum Pricing and (5) Other.

Change Order Limitations

35

slide-36
SLIDE 36
  • Definition: Force Majeure generally means any circumstance

not within the reasonable control of the claiming Party, but

  • nly if (a) such event is not due to such Party’s negligence or

willful misconduct and is not due to such Party’s failure to perform any of its obligations under the EPC Agreement; (b) such Party could not have reasonably avoided such event and has taken commercially reasonable efforts to mitigate and eliminate the effects of such event; and (c) such Party has provided the other Party with notice thereof within three (3) days after such event has occurred.

  • Examples: If the definition is satisfied: war, riot, sabotage, acts
  • f public enemy, terrorist acts, severe and unusual weather,

flooding, explosions, fire arising from natural causes, earth quake, hurricanes, tornados, forest fires and hailstorms.

Force Majeure

36

slide-37
SLIDE 37
  • Exclusions: The following are typically excluded:
  • Changes in interest rates, inflation rates, insurance premiums,

commodity prices, exchange rates, availability of financing or

  • ther general economic conditions;
  • Changes in financial condition of Owner or Contractor;
  • Any strike, lockout or other labor dispute of Contractor or its

subcontractors that are not regional or national;

  • Equipment or labor pricing increases or labor unavailability; and
  • Subcontractor’s failure to perform, mechanical failure of

equipment or delays in receiving equipment or materials, in each case, to the extent not resulting from a specified Force Majeure.

  • Termination: Owner often has the right to terminate for

extended Force Majeure claimed by Contractor.

Force Majeure (Con’t)

37

slide-38
SLIDE 38
  • Role of Federal Investment Tax Credit and Section 1603 Safe

Harbor Panels (Good until December 31, 2016)

  • Tax Incentives Expiring Soon unless Congress Extends – possible

year-end tax extender package could include ITC

  • “Placed in Service” Issues – Don’t throw the switch on until

Owner is Ready

  • Tax Equity Investor does not want EPC Risk so Tax Equity Investor

will typically not accept project ownership until Substantial Completion or just prior to “Placed In Service”

  • State Tax Incentives and Grants
  • Understand Documentation Required to Show Completion

and Project Costs

  • Accountants must certify to Treasury Qualifying Cost of Project

EPC Agreement and Tax Issues

38

slide-39
SLIDE 39
  • Assignability: Assignment is generally subject to consent.
  • Collateral assignment is required for a non-recourse financing.
  • Assignment to an affiliate is generally acceptable if credit support

remains or is provided and such affiliation continues.

  • Assignment by Owner to successor to project is generally

permissible in a non-recourse financing.

  • Change of control is usually not restricted.
  • Breach of assignment restrictions causes assignment to be void.

Other EPC Agreement Issues

39

slide-40
SLIDE 40
  • Dispute Resolution
  • Arbitration, Expert Determination or Court of Law
  • If Arbitration, consider:
  • Number of arbitrators
  • Location
  • Sharing of Costs
  • Final and Binding
  • Permitting injunctions/interim court relief
  • Consider including officer escalation process
  • Choice of Law
  • Owner typically specifies governing law.
  • Contractor may have objections based on familiarity/limits on

liability.

Other EPC Agreement Issues (Con’t)

40

slide-41
SLIDE 41
  • Cooperation by Contractor/Guarantor with Lenders:
  • Direct Agreement/Consent to Collateral Assignment
  • Legal Opinion
  • Officer’s Certificate
  • Financial and Other Information
  • Independent Engineer
  • Liens:
  • Conditional and Unconditional Mechanic’s Lien Waivers
  • Subordination of Mechanic’s Lien
  • Cure/Reimbursement/Indemnification
  • Third-Party Beneficiaries

Other Financing Issues

41

slide-42
SLIDE 42
  • Termination Rights: Contractor should have limited rights to

terminate the EPC Agreement after FNTP.

  • Default vs. Change Order
  • Suspension
  • Extended Force Majeure
  • Insurance:
  • Coverage
  • Additional Insurance
  • Subrogation
  • Notice of Termination
  • Payment of Proceeds

Other Financing Issues (Con’t)

42

slide-43
SLIDE 43
  • Others:
  • Setoff: Lenders generally do not like Contractor to have setoff

rights against amounts owed by Contractor to Owner.

  • Title: Title should pass at the earlier of payment and delivery to

the site.

  • Risk of Loss:
  • Before Substantial Completion
  • After Substantial Completion
  • Indemnities: Contractor should indemnify Owner for appropriate

third-party claims.

  • Intellectual Property
  • Breach of Law
  • Taxes

Other Financing Issues (Con’t)

43

slide-44
SLIDE 44

DREW BALDINGER STEPHEN J. HUMES

DLA Piper LLP (US) Holland & Knight 1000 Louisiana, Suite 2800 31 West 52nd Street Houston, Texas 77002 New York, New York 10019 (713) 425-8453 (212) 513-3473 Email: drew.baldinger@dlapiper.com Email: steve.humes@hklaw.com Website: www.dlapiper.com Website: www.hklaw.com

Thank You

44
