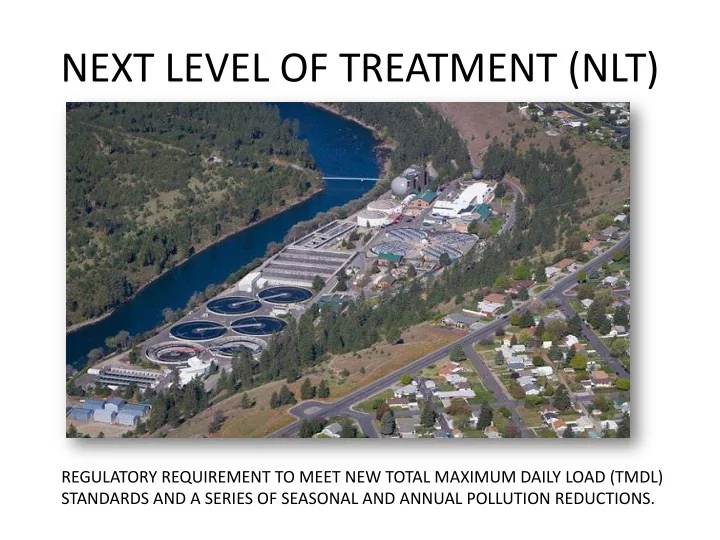

NEXT LEVEL OF TREATMENT (NLT) REGULATORY REQUIREMENT TO MEET NEW TOTAL MAXIMUM DAILY LOAD (TMDL) STANDARDS AND A SERIES OF SEASONAL AND ANNUAL POLLUTION REDUCTIONS. NEW (FIFTH) PRIMARY CLARIFIER WILL SUBSTANTIALLY IMPROVE FLEXIBILITY TO MOVE AND


  1. NEXT LEVEL OF TREATMENT (NLT) REGULATORY REQUIREMENT TO MEET NEW TOTAL MAXIMUM DAILY LOAD (TMDL) STANDARDS AND A SERIES OF SEASONAL AND ANNUAL POLLUTION REDUCTIONS.

  2. NEW (FIFTH) PRIMARY CLARIFIER WILL SUBSTANTIALLY IMPROVE FLEXIBILITY TO MOVE AND STORE STORM AND SNOW MELT EVENT FLOWS TO OPTIMIZE PLANT PERFORMANCE.

  3. PILOT STUDY REVIEW BLDG K BLDG C BLDG Z KRUGER ACTIFLO COMAG ZENON MEMBRANE BALLASTED SEDIMENTATION BALLASTED SEDIMENTATION FILTRATION BLDG F BLDG S BLDG B CORIX MIXED MEDIA CORIX BLUE WATER FILTRATION SEDIMENTATION UPFLOW – CONT BW FILTER PILOT STUDY LOOKED AT 6 TECHNOLOGIES. MEMBRANES WERE BEST.

  4. MEMBRANE FILTRATION ULTRA FILTRATION CANDIDATES: 0.1 OR 0.043 MICRON PORE SIZE A MICRON IS 1 MILLIONTH OF A METER A THIN HUMAN HAIR IS ABOUT 20 MICRONS

  5. HOW MUCH DO WE NEED? 50 MILLION GALLONS / DAY FILTER CAPACITY OLYMPIC POOL IS 500,000 GALLONS 50 MGD = 100 OLYMPIC POOLS / DAY

  6. TWO COMPETING PROTOCOLS IMMERSED VERSUS PRESSURE SYSTEMS IMMERSED SYSTEMS PRESSURE SYSTEMS LIKE PENDLETON WATER SYSTEM LIKE SANDPOINT WATER SYSTEM

  7. IMMERSED SYSTEM LARGE, SERPENTINE, CONCRETE BUILDING TO HOUSE IT AGAINST TANK ARRAY FREEZING IN WINTER PENDLETON WATER TREATMENT PLANT

  8. PRESSURE SYSTEM PLUG AND PLAY RACKS OF LARGE BUILDING WITH RACKS OF CANISTERS OF FILTERS CANNISTERS ALL MANIFOLDED UP TO 6,300 FILTER TUBES PER 5 IN. CANISTER 39 CANISTERS PER RACK SANDPOINT WATER TREATMENT PLANT

  9. WHAT’S NEXT? CHALLENGE TEST NEW SIDE BY SIDE PILOT ISSUE RFQ REPRESENTATIVE AND RUN OF THE PLANT • ESTABLISHED MEMBRANE PRODUCER IMMERSED • LARGE ENOUGH TO MEET CHALLENGE TEST PRESSURE PRODUCTION • REPRESENTATIVE FINANCIALLY SOUND • PRODUCT PROVEN IN THE FIELD AT RUN OF THE PLANT LEAST 10 YEARS • STAFFED FOR GREAT CUSTOMER SERVICE ESTIMATED COST OF NLT = $100 MILLION • PROVIDES THE BEST LIFE CYCLE COST IMPORTANT TO GET IT RIGHT - BENEFIT

  10. TIMELINE PROJECT PLANNING 10 Years 2013 2014 2015 2016 2017 2018 2019 2020 2021 SIDE BY SELECTED VENDOR PILOT SPA3 FINALIZATION SIDE PILOT SELECT VENDOR INTEGRATED PLAN GC/CM GMP / GCCM CLEANER SELECTION/ CONSULTANT INITIATION RIVER APPROVAL SELECTION FASTER CONSTRUCTION FINAL DESIGN COMMISSIONING APPROVE SYSTEM REFINING

  11. QUESTIONS / COMMENTS?

Download Presentation
Download Policy: The content available on the website is offered to you 'AS IS' for your personal information and use only. It cannot be commercialized, licensed, or distributed on other websites without prior consent from the author. To download a presentation, simply click this link. If you encounter any difficulties during the download process, it's possible that the publisher has removed the file from their server.
