Georgetown Combined Sewer Rehabilitation Project: Sewer Lining and Chemical Grouting Sewer Inspection and Cleaning Sewer Repair (O Street NW Excavation) March 30, 2017 1 Project Overview Excavation location (sewer repair)


slide-1
SLIDE 1

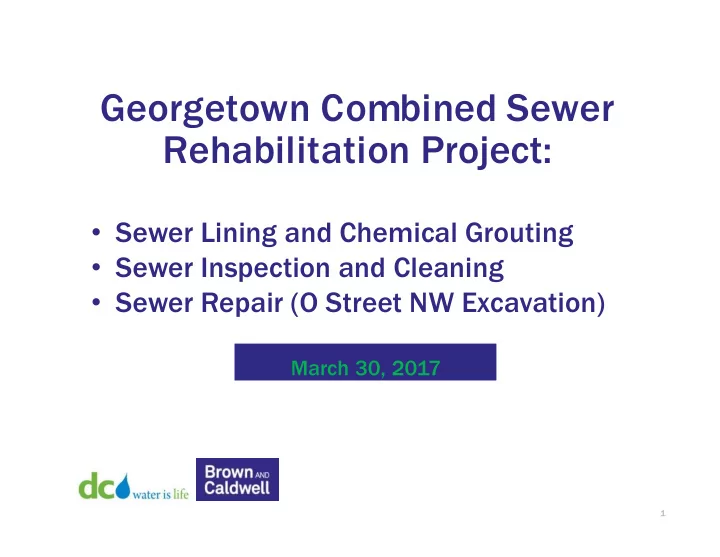

Georgetown Combined Sewer Rehabilitation Project:

  • Sewer Lining and Chemical Grouting
  • Sewer Inspection and Cleaning
  • Sewer Repair (O Street NW Excavation)

1

March 30, 2017

slide-2
SLIDE 2

Project Overview

Excavation location (sewer repair)

2

  • Important project to revitalize

some of the District’s oldest sewers

  • Relining of approximately 5,600

linear feet of affected sewer pipe

  • Sewer damaged from

corrosion

  • Trenchless rehabilitation to

limit impact (accessing sewer via area manholes)

  • Excavation will be needed

at one location for sewer repair: Between 3318 & 3320 O Street NW

  • Overall project Duration is 420

days

  • Construction schedule-see

project information sheet

slide-3
SLIDE 3

O Street Excavation: Aerial View

Location of excavation

240-ft

3

34th St. NW O St. NW 33rd St. NW 19” x 30” Arched Sewer

slide-4
SLIDE 4

4

O Street Excavation: Sewer Defect Views

View of bulging sidewall in 19”x30” Sewer Enlarged view

slide-5
SLIDE 5

O Street Excavation

5

Open Cut Excavation Location

  • Estimated Size: 10’L x 12’W x 20’D
  • Construction Schedule: 5/30/17-7/6/17

(subject to change)

  • Parking spaces: +6 per side (+12 total)
  • Trolley Tracks: No Impact (Remain in Place)
  • Paving materials: Salvaged and reused
  • Contractor: Masonry and historic

preservation experience

slide-6
SLIDE 6
  • Road closure during excavation
  • Lane closure and parking lane closure during sewer repair
  • Discharge piping at ground level
  • Potential security considerations during work at this location
  • Effort underway to avoid open cut excavation (TBD by 5/10/17)

Impacts of O Street Open Cut Excavation

slide-7
SLIDE 7
  • Protection of trees and shrubbery in the construction zone
  • Monitoring of noise and vibration levels
  • Coordination of construction/restoration activities with other area

projects and stakeholders * Hyde-Addison Elementary School Modernization Project * Georgetown University

  • Installation of temporary piping system inside existing sewer to

allow for continuous flow (also known as the Flume technique)

Mitigation Efforts

slide-8
SLIDE 8

8

  • Pavement bricks that are temporarily removed from the

sidewalk and parking lane between 3318 and 3320 O Street during the sewer repair will be carefully marked (numbered) to ensure proper replacement, and they will be safely stored at an off-site location. Once the repair is completed, the bricks will be returned and carefully restored in accordance with design specifications under the DDOT O and P Streets Rehabilitation Project

  • Extensive pre-construction and post-construction photo

documentation

Key Site Restoration Requirements

slide-9
SLIDE 9

DC Water Project Manager: Willis Thomas (202) 787-7616 or willis.thomas@dcwater.com (weekdays, from 8:00 a.m.-4:00 p.m.) DC Water Construction Outreach Coordinator: Tanya Hedgepeth (202) 787-2202 or tanya.Hedgepeth@dcwater.com DC Water Project Contractor: Proshot Concrete, Inc.-Albert Pugliese (757) 620-4840

Primary Project Contacts:

slide-10
SLIDE 10

Questions????
