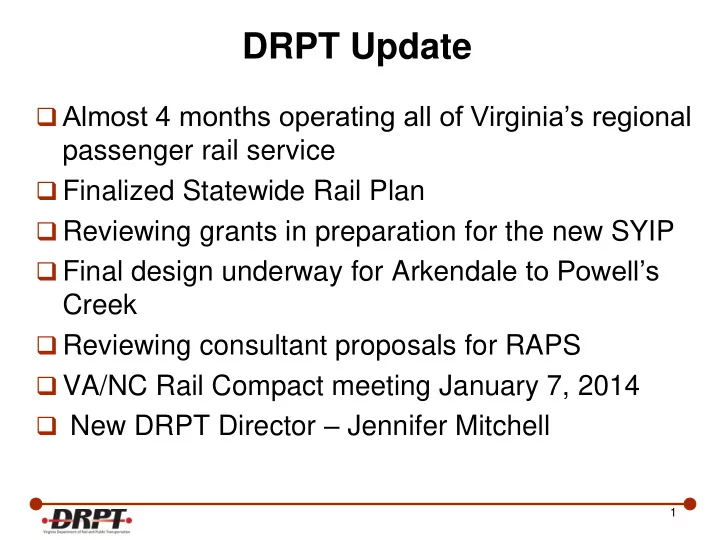

1
DRPT Update Almost 4 months operating all of Virginias regional - - PowerPoint PPT Presentation
DRPT Update Almost 4 months operating all of Virginias regional - - PowerPoint PPT Presentation
DRPT Update Almost 4 months operating all of Virginias regional passenger rail service Finalized Statewide Rail Plan Reviewing grants in preparation for the new SYIP Final design underway for Arkendale to Powells Creek
2
PRIIA changed America’s approach to intercity
passenger rail development
– High Speed Corridor Program is identified – Section 201 Defined Amtrak’s national system – Section 209 Defined the Role of the States and Amtrak to establish a consistent cost structure
- Federal government transition to invest only in long distance
routes of greater then 750 miles between endpoints and in Amtrak’s Northeast Corridor
- Operating costs for regional routes under 750 miles will
transition to the states
- Capital program funding identified with no operating funding to
states to cover costs
Chapter 2: Rail Plan Context
Passenger Rail Investment and Improvement Act of 2008 (PRIIA)
3
Setting Up a Passenger Rail Program
PRIIA 2008 Section 209 was a game changer for
Virginia
– Not only did Virginia want to continue its existing Amtrak Regional Services, it wanted to add new regional intercity passenger rail services at the same time.
Virginia reacted quickly to begin setting up a funding
program for regional intercity passenger rail and capital development of expanding conventional service and higher speed rail
DRPT secured a seat for COO Kevin Page at the
negotiating table as a member of the State Working Group to assist in the negotiations of the Amtrak PRIIA Section 209 requirements and agreement
4
Setting Up a Passenger Rail Program How we got there
Virginia followed a three step approach to program
development:
– SJ63 2010 called for DRPT to study and recommend funding strategies for state sponsored intercity and high speed passenger rail. Report published as Senate Document 14 of the VA General Assembly
- The SJ63 report laid out the foundation of an intercity
passenger rail program and gave suggestions to the state lawmakers on how a program could be funded
– 2011 DRPT authors legislation to establish the Intercity Passenger Rail Operating and Capital Fund (IPROC) and 2012 provided 2 years of funding for stop gap security to start Amtrak Section 209 funding
- Legislation established the fund, but no dedicated revenue
source
– 2013 Landmark transportation funding legislation includes dedicated funding for IPROC
- Funding capacity for existing and future intercity passenger rail
services
Setting Up the Program Transportation Funding Bill HB2313
Impact to DRPT
– Designated revenue source for Intercity Passenger Rail Operating and Capital Fund (IPROC) – Approx. $44.3M in the first year to $56.1M in fifth year
- First time intercity passenger rail has had dedicated funding
– Virginia was fully funded and the first state to execute the Section 209 Regional State Supported Service agreement with Amtrak. – Funding .3% increase statewide sales and use tax increase
- .125% Dedicated to Rail and Transit:
– .075% Transit (60%) – .05% IPROC (40%)
5 5
6
Virginia will continues to support the two state
supported services operating pre-PRIIA, as well as the Norfolk extension.
Virginia is now supporting four additional regional
trains in 2014
– Two trains, Richmond to Washington, D.C. – Two trains, Newport News to Washington, D.C.
PRIIA’s Virginia Impact
7
Intercity Passenger Rail Operating and Capital Fund
Virginia initiated intercity passenger rail service starts – 2009 – Lynchburg – 2010 – Richmond – 2012 – Richmond service extended to Norfolk – 2013 – Section 209 service begins – VA picks up 4 more trains Future Near and Mid Term Projects – Within 4 years – Roanoke – 7 Year Option to Purchase S-Line Right of Way Petersburg to Norlina – Within 10 years – Trains 2 and 3 Norfolk
- DRPT is working with CSX on evaluating and identifying improvements
8
DRPT Rail Grants
Rail Enhancement Fund Rail Industrial Access Funds Rail Preservation Fund
9
Passenger Rail Service In Virginia Present and Future
9
Amtrak VA – Lynchburg, Richmond/Norfolk
Amtrak Regional – 2 Newport News, 2 Richmond
All go into Northeast Corridor
All same seat to Boston
Amtrak Long Distance – Cardinal, Crescent, Carolinian, Palmetto, Silver Meteor, Silver Star
Auto Train
Virginia Regional Amtrak Passenger Service Projected Population Areas
10
11
Rail Plan Feedback Themes
Coordination between freight and passenger interests Grade Crossings Mode-neutral transportation planning Funding Land use Stations Rails with Trails Passenger rail support – in general and in specific
locations: Charlottesville, Hampton Roads, I-95 Corridor (Southeast High Speed Rail), I-81 Corridor, Lynchburg, Roanoke, US Route 29 Corridor
Amtrak Virginia Near Future
- 1 Lynchburg train extended to Roanoke (approx. 2016 - 2017)
- 2 Richmond trains extended to Norfolk (approx. 2022)
Amtrak Virginia Future
- 1 new train to Lynchburg
- 1 Roanoke train extended to Bristol
- 1 Lynchburg train extended to Roanoke
- 1 new train Richmond to Lynchburg
Richmond to Hampton Roads Passenger Rail
– 1 new to Newport News + 6 total Norfolk from Richmond
SEHSR – 4 new trains DC to Raleigh
Future Intercity Passenger Rail Projects – Statewide Virginia Rail Plan
12
I-95/U.S.460 Passenger Service
Norfolk
SYIP - funded
– Capacity improvements, yard rehabilitation and connection tracks for service to Norfolk – Operating costs for existing intercity service
Future Phases - funded
– Continued capacity improvements for additional trains to Norfolk – Continued operating costs for service at current levels, plus additional Norfolk service
13
I-95/I64 Passenger Service
Newport News
SYIP - funded
– Amtrak capital and
- perating costs
Future Phases -
funded
– Station area improvements and increased capacity at Bland Boulevard – Continued operating support for service
14
15
Chapter 5: Resource Allocation Plan
Port of Virginia
SYIP – Craney Island Connector NEPA and PE – NIT Marshalling Yard expansion Future Phases – Construct Craney Island Connector – APM terminal yard expansion
Southeast High Speed Rail
SYIP - funded
– Tier II EIS from Richmond to DC – Arkendale to Powells Creek 3rd Main construction – Tier II EIS from Richmond to Raleigh
Future Phases -
unfunded
– Tier II EIS from Richmond to Hampton Roads – Capacity improvements to initiate service
16
Federal High Speed Rail – Current VA Projects
Two Federal Railroad Administration stimulus grants
totaling $119 million
– Arkendale to Powell’s Creek third track - $75 million (100%) – Study of high speed rail form Washington, DC to Richmond - $44 million (80%)
17
Arkendale to Powells Creek ARRA Funded Stimulus Project
$75M 100% Federal
ARRA Stimulus Funded Project
11 Mile Third Track
Design Build Project
CSX will construct for
DRPT
Project completion
9/2017
18
19
110 mile segment
Extends from junction of CSX A-Line and CSX S-Line at Centralia (MP A-11) northward via the S-Line through Richmond's Main Street Station.
Rejoins A-Line near Staples Mill Station.
Extends northward along the CSX Richmond, Fredericksburg and Potomac Subdivision (RF&P) to Control Point RO in Arlington (MP CFP-110).
Also includes the following improvement areas:
- CSX Peninsula Subdivision in the
Richmond area between AM Junction and Beulah to the east.
- Buckingham Branch Railroad from AM
Junction to Ruffin.
Federal HSR Planning Process- Richmond Area to Potomac River Segment “RAPS” Tier II EIS
20
Established in 1994 in VA by SB 126 2004 and in NC by NC General Statutes - Chapter 136 Article 18 § 136-220.
Made up of ten members of the VA and NC legislature. Three of the five VA members are from Hampton Roads: Senator Kenneth Alexander, Delegate Ronald Villanueva, and Delegate Jeion Ward. Compact Purpose
To study, develop, and promote a plan for the design, construction, financing, and operation of interstate high-speed rail service through and between points in the Commonwealth of Virginia and the State of North Carolina and adjacent states.
To coordinate efforts to establish high-speed rail service at the federal, state, and local governmental levels.
To advocate for federal funding to support the establishment of high-speed interstate rail service within and through Virginia and North Carolina and to receive federal funds made available for rail development. January 7, 2014 Compact Meeting
Major point of discussion: Service Development Plan for rail service in the Southeast High Speed Rail corridor (includes Hampton Roads).
Compact to meet again in June or July.
Virginia-North Carolina Interstate High-Speed Rail Compact
21
Richmond to Raleigh Tier II EIS
Current Status - DRPT and NCDOT continue to advance work on the
Richmond to Raleigh Tier II EIS
– Completing Project Update Meetings in areas with revised roadwork designs – DRPT has accommodated the third track alignment for high speed rail
- perations as a part of the Collier Connection alignment for the
Norfolk train service extension Late 2014 - Complete Tier II Final EIS Before SEHSR service is to begin, significant track capacity
improvements must be made between Raleigh and Washington, D.C.
22
Southeast High Speed Rail (SEHSR) Next Steps
Complete Environmental and Design
Track improvements on existing segments
1. Richmond, VA to Washington, DC Petersburg, VA to Richmond, VA 2. Petersburg, VA to Norfolk, VA* 3. Petersburg to Raleigh, NC
Subject to funding
Coordinate with
– FRA – Amtrak – Railroads – Local Governments – Property Owners *Advancing under Hampton Roads EIS
