Cycling Network Plan Etobicoke York District Cycle Toronto's Etobicoke Advocacy Summit, January 30 th 2018 [Heading] [Subheading] Example from CNP: Ward 3 Proposed Cycling Routes [Heading] 13 Burnhamthorpe Rd (Martin Text Text Grove to


slide-1
SLIDE 1

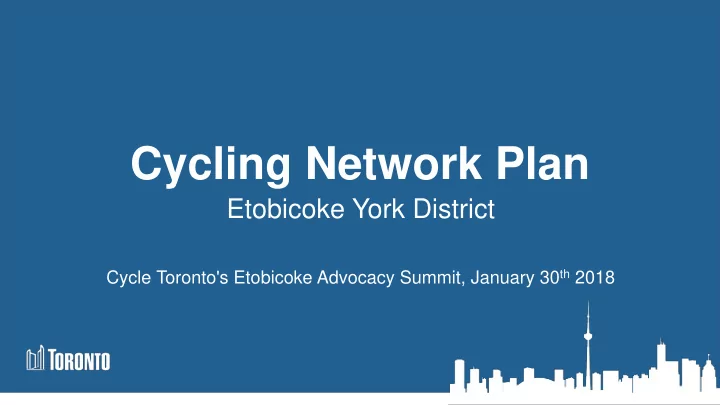

Cycling Network Plan

Etobicoke York District

Cycle Toronto's Etobicoke Advocacy Summit, January 30th 2018

slide-2
SLIDE 2

[Subheading]

[Heading]

slide-3
SLIDE 3

[Heading]

Text

  • Text

Text

  • Text

2

Example from CNP: Ward 3 Proposed Cycling Routes

13 – Burnhamthorpe Rd (Martin Grove to Dundas) 52 – Martin Grove Rd (Rathburn to south of Burnhamthorpe) 67 – Princess Margaret Neighbourhood Connections 69 – Rathburn Rd (Mill to the East Mall) 70 – Renforth Dr (Rathburn to Eglinton)

slide-4
SLIDE 4

3

Please note: Proposed projects are subject to design feasibility, public consultation, and approvals.

slide-5
SLIDE 5
  • Completion of Lake Shore Cycle Track
  • Completion of Etobicoke Creek Trail at Eglinton
  • PFR starting work on Etobicoke Creek Trail at Sherway 2018
  • Eglinton West Trail (Spectrum/Rakely to Etobicoke Creek)
  • Martin Grove Rd line marking and signage improvements (Eglinton

to Rathburn) + bike signal at Martin Grove and Eglinton

  • Humber Trail connection at Emery Creek to Weston Rd
  • Feasibility Study of Mid Humber Gap Phase 2 (Mallaby Park to

Fairglen/Cardell) – planned to start 2018

4

2018 Proposed Cycling Facilities

slide-6
SLIDE 6

2018 Proposed Cycling Facilities

  • Annette St and Jane St intersection – line marking

improvements (green thermoplastic)

  • Runnymede Rd line marking improvements (St. Clair and Bloor

intersections – continue work started in 2017)

  • Six Points (Kipling / Dundas / Bloor intersection) cycle track

(2018 – 2020)

  • Humber Bay Shores Trail Improvements
  • Phase 1 - Complete 2018; Phase 2 work planned for 2018/2019

5

slide-7
SLIDE 7

2018 York University Connections

6

Near Etobicoke (heard there was interest in this project). Purpose: to connect to the campus, to transit and to

  • trails. It is funded 50%

through the federal Public Transit Infrastructure Fund.

slide-8
SLIDE 8

2018 York University Connections

Three public consultations coming up:

  • Tuesday, February 27, 2018, 10 a.m. to 2 p.m., York University, Keele

Campus, Vari Hall Rotunda

  • Thursday, March 1, 2018, 12 p.m. to 2 p.m., Grandravine Community

Centre, 23 Grandravine Drive

  • Thursday, March 1, 2018, 6 p.m. to 8 p.m., St. Jerome Catholic School,

111 Sharpecroft Blvd

Visit toronto.ca/yorkudownsview

7

slide-9
SLIDE 9

2019 Proposed Cycling Facilities

  • Looking at options for St. Clair Ave W (Runnymede to Scarlett),

Scarlett Rd (Dundas to Eglinton), and Baby Point Neighbourhood Connections (connections between Dundas St, Annette St, and the Humber River)

  • Kipling Heights Neighbourhood and Weston Neighbourhood

Connections wayfinding sharrows on quiet streets

  • Oakwood Village Neighbourhood Connections wayfinding

sharrows and contra-flow bike lanes on quiet streets

  • Vaughan Rd bike lane (Oakwood to Eglinton)

8

slide-10
SLIDE 10

2019 Proposed Cycling Facilities

  • Eglinton West Trail (Jane to Weston) (2018 – 2019)
  • Stakeholder consultation spring/summer 2018, construction likely 2019
  • Eglinton Ave W bike signals at Lloyd Manor, Royal York, Scarlett
  • Looking at potential for Silverthorn Ave contra-flow bike lane and

sharrows (Davenport to Eglinton)

9

slide-11
SLIDE 11

2020 Proposed Cycling Facilities

Note: Bikeway type (e.g. bike lane vs cycle track) will be confirmed through feasibility analysis and public consultation.

  • Martin Grove Rd (Swan to Rathburn)
  • Looking at options to connect Martin Grove Rd to Kipling Station
  • Norseman St (Royal York to Kipling)
  • Judson St (Royal York to Horner)
  • Rathburn Rd (Elmcrest to just east of Centennial Park Rd)
  • Coordinate with 427 bridge rehabilitation and look at improving existing

section from The East Mall to Martin Grove

  • Trethewey Dr (Eglinton to Jane)

10

slide-12
SLIDE 12

2020 Proposed Cycling Facilities

  • Upgrading Kipling Ave boulevard multi-use trail (Steeles to Mount Olive Dr)

+ bike signals at Mt. Olive, Rowntree, Kidron Valley

  • Eglinton Ave W bike signals at Eden Valley, Islington, Wincott, Kipling

(bundled with other work)

  • Oakdale Rd (Sheppard to Finch)
  • The Kingsway (Dundas to Anglesey)
  • Looking at options for North Queen St and connecting it to Royal York and

the waterfront through neighbourhood

  • Finch cycle tracks to be built as part of LRT work; construction likely to

start in 2019 but will not be complete until beyond 2020

11

slide-13
SLIDE 13

Eglinton Crosstown

  • Eglinton Crosstown Cycle Tracks / Streetscaping Design Study

includes Ward 12 and 17 in Etobicoke

  • Preliminary design has started and the City will consult

stakeholders this spring/summer (2018)

  • Detailed design is planned to be complete by mid-2019
  • Timing and funding for construction has not yet been

determined, but the City will work with Metrolinx to coordinate this

12

slide-14
SLIDE 14

toronto.ca/cyclingnetwork
