AREA ADVISORY TEAM MEETING The Louisville - Southern Indiana Ohio River Bridges Project (LSIORBP) June 21, 2011 1 1. Welcome / Introductions 2. Project History 3. Why We Are Here 4. Proposed Alternatives 5. Next Steps 2 The Bridges


slide-1
SLIDE 1

1

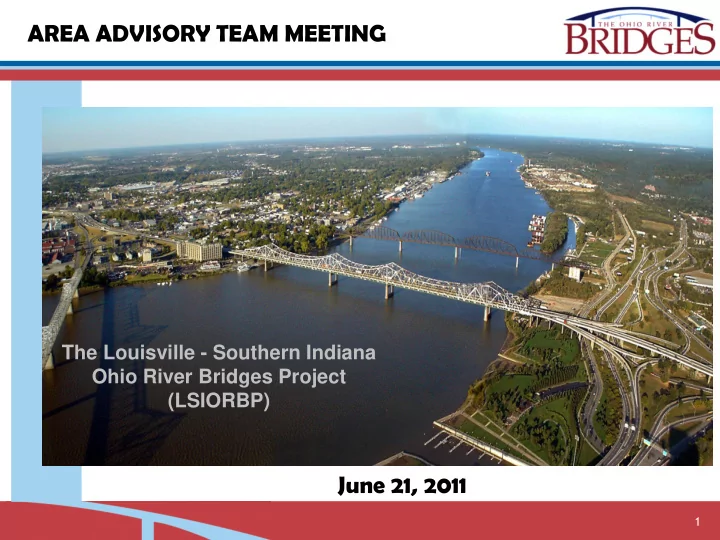

The Louisville - Southern Indiana Ohio River Bridges Project (LSIORBP)

AREA ADVISORY TEAM MEETING June 21, 2011

slide-2
SLIDE 2

2

  • 1. Welcome / Introductions
  • 2. Project History
  • 3. Why We Are Here
  • 4. Proposed Alternatives
  • 5. Next Steps
slide-3
SLIDE 3

3

The Bridges Project

slide-4
SLIDE 4

4

Federal EIS Phase

  • 1998 – Federal process begins
  • Considered 9 bridge locations

in 1 or 2 bridge combinations

  • Extensive public involvement

process

  • 5,000 comments received on

Draft EIS

slide-5
SLIDE 5

5

2003 Record of Decision

Selected Alternative: Construct New Downtown Bridge Construct New East End Bridge Reconstruct Kennedy Interchange

slide-6
SLIDE 6

6

Progress Since 2003

  • Design Engineering
  • Right-of-Way Acquisition
  • Major Project Financial Plan and Update
  • Creation of Louisville and Southern Indiana

Bridges Authority (LASIBA) – 2010

slide-7
SLIDE 7

7

Why We Are Here

slide-8
SLIDE 8

8

  • Federal highway funds come from gasoline tax
  • Purchasing power of federal gas tax dropping

Lack of Conventional Funding

slide-9
SLIDE 9

9

Additional Funding to Fill Gap

  • Metropolitan

Transportation Plan amended to add tolling

  • Bridges Authority

developing financial plan

slide-10
SLIDE 10

10

Governors, Mayor identified potential project savings

  • 1. Rebuild Kennedy

Interchange in place

  • 2. Reduce East End bridge,

roadway and tunnel from six lanes to four lanes

  • 3. Complete the Big Four

Bridge pedestrian / bike path under a separate project

Leaders Seek Cost-Saving Measures

slide-11
SLIDE 11

11

Cost Comparisons

Project Segment 2003 Selected Alternative 2011 Modified Alternative Section 1 - Kennedy Interchange $1,530.0 $728.2 Section 2 - Downtown River Bridge $569.7 $532.6 Section 3 - Downtown IN Approach $392.7 $177.8 Section 4 - KY East End Approach $885.2 $794.8 Section 5 - East End River Bridge $406.2 $326.2 Section 6 - IN East End Approach $234.8 $231.7 Other Costs(2) $124.2 $125.0 TOTAL(1) $4,142.8 $2,916.2

(Costs in $, million) (1) Totals may not sum due to rounding (2) Includes costs that are not section specific, including Project Oversight, Environmental Mitigation of Hazardous Materials, Wetland Remediation and Historic Preservation

slide-12
SLIDE 12

12

Supplemental EIS

  • Federal requirement to review potential

changes

  • What are the impacts associated with:

– Tolling – Implementation of cost saving ideas

  • Focused effort
slide-13
SLIDE 13

13

Traffic Diversion Analysis

Traffic Diversion Effects

Vehicle Types Tolling Range Traffic Patterns

Travel Model

  • Computer program to

model traffic

  • Range for diversion study

Cars, trucks, SUVs - $1 to $2 Box / panel trucks - $2 to $4 Tractor trailers - $4 to $8

  • Actual toll rates determined

through separate analysis by Bridges Authority

slide-14
SLIDE 14

14

Bottom line: Improve cross-river mobility

  • Safety problems
  • Traffic congestion
  • Inefficient mobility
  • Inadequate system

linkage

  • Planning consistency

Purpose and Need

slide-15
SLIDE 15

15

Proposed SEIS Alternatives

  • No Action
  • 2003 Selected Alternative with tolls
  • 2011 Modified Alternative with tolls
slide-16
SLIDE 16

16

Specific factors demonstrate the need for action including:

Kennedy Interchange

  • Traffic congestion
  • Traffic safety
slide-17
SLIDE 17

17

Section 2 Downtown River Bridge

slide-18
SLIDE 18

18

KY IN

  • Just East of Existing Kennedy Bridge
  • Slight Skew with Kennedy Bridge
  • 3300’ Total Length

Section 2 – Downtown Bridge

Bridge Crossing Alignment

slide-19
SLIDE 19

19

  • Required by United States Coast Guard
  • 71 Feet Vertical Clearance

750’ 500’ MIN

Section 2 – Downtown Bridge

Navigation Requirements

slide-20
SLIDE 20

20

View Looking Toward Indiana

Bridge Cross Section Including Pedestrian Walkway/Bikeway

EIS Selected Alternative

slide-21
SLIDE 21

21

View Looking Toward Indiana

Bridge Cross Section Without Pedestrian Walkway/Bikeway

Modified Alternative

slide-22
SLIDE 22

22

EIS Selected Alternative

View From Pedestrian Walkway/Bikeway

slide-23
SLIDE 23

23

  • 4 Step Public Process
  • 31 Original Bridge Concepts
  • 3 Bridge Type Concepts
  • 14 Member Executive Committee
  • Kentucky Gov.
  • Indiana Gov.

Section 2 – Downtown Bridge

Bridge Type Selection

slide-24
SLIDE 24

24

Section 2 – Downtown Bridge

Final Bridge Type Selection

3 TOWER CABLE-STAYED

slide-25
SLIDE 25

25

3 TOWER CABLE-STAYED

Section 2 – Downtown Bridge

Final Bridge Type Selection

slide-26
SLIDE 26

26

With sidewalk

EIS Selected Alternative

slide-27
SLIDE 27

27

With out sidewalk

Modified Alternative

slide-28
SLIDE 28

28

Downtown Bridge

Modified – w/out sidewalk

slide-29
SLIDE 29

29

Section 2 – Downtown Bridge

Existing JFK Bridge Rehab

  • 6 Lanes Southbound Only
  • Shoulders, Each Side
  • Deck Replacement
  • Remove Median Barrier
  • New Signing
  • No change to the Steel

Structure

Existing Traffic Pattern Proposed Traffic Pattern

slide-30
SLIDE 30

30

Section 3 Indiana Approach to Downtown Bridge

slide-31
SLIDE 31

31

EIS Selected Alternative

Downtown Bridge

slide-32
SLIDE 32

32

Modified Alternative

Downtown Bridge

slide-33
SLIDE 33

33

Alternative Comparison

EIS Selected Alternative Modified Alternative

Complex bridge network for Southbound access ramps Replace bridge network with collector-distributor roadway system 4 lane US 31 over Court Ave. from I-65 to Clark Memorial Bridge 2 lane US 31 over Court Ave. from I-65 to Clark Memorial Bridge Reconstruct I-65 Bridge over 7th St. Eliminate I-65 bridge over 7th St. provide full access on 6th St. Complex flyover bridge for I-65 NB exit to 10th Street Eliminate flyover and revise NB exit to 10th Street similar to existing alignment Relocate 10th St. under I-65 to the south adjacent to RR spur and 9th St. Reconstruct 10th St. similar to existing alignment Total bridge construction 674,500 sft. Total bridge construction 205,500 sft.

SECTION 3

slide-34
SLIDE 34

34

EIS Selected Alternative

COURT AVE. ACCESS

slide-35
SLIDE 35

35

Modified Alternative

COURT AVE. ACCESS

slide-36
SLIDE 36

36

EIS Selected Alternative

6TH & 7TH STREET ACCESS

slide-37
SLIDE 37

37

Modified Alternative

6TH & 7TH STREET ACCESS

slide-38
SLIDE 38

38

EIS Selected Alternative

10TH STREET ACCESS

Clark Memorial Hospital

slide-39
SLIDE 39

39

Modified Alternative

Clark Memorial Hospital

10TH STREET ACCESS

slide-40
SLIDE 40

40

EIS Selected Alternative

SB FRONTAGE & STANSIFER ACCESS

slide-41
SLIDE 41

41

Modified Alternative

SB FRONTAGE & STANSIFER ACCESS

slide-42
SLIDE 42

42

Next Steps

slide-43
SLIDE 43

43

Federal Review Process

  • Public Involvement Meetings
  • Analysis of Alternatives
  • Draft SEIS published
  • Public Comment period
  • Final SEIS published
  • FHWA review
  • Record of Decision
slide-44
SLIDE 44

44

The Louisville - Southern Indiana Ohio River Bridges Project (LSIORBP)

AREA ADVISORY TEAM MEETING June 21, 2011

www.kyinbridges.com
