purbrook way hulbert road junction phasing drawings
play

Purbrook Way Hulbert Road Junction Phasing Drawings Revision 2 - PowerPoint PPT Presentation

Purbrook Way Hulbert Road Junction Phasing Drawings Revision 2 Current at 31-03-2016 From: Tuesday 29 th March To: Friday 1 st April Full Depth Road Construction SE Roundabout Part 2 of 2 Surface Water Drainage SE Rbt Part 2 of 2

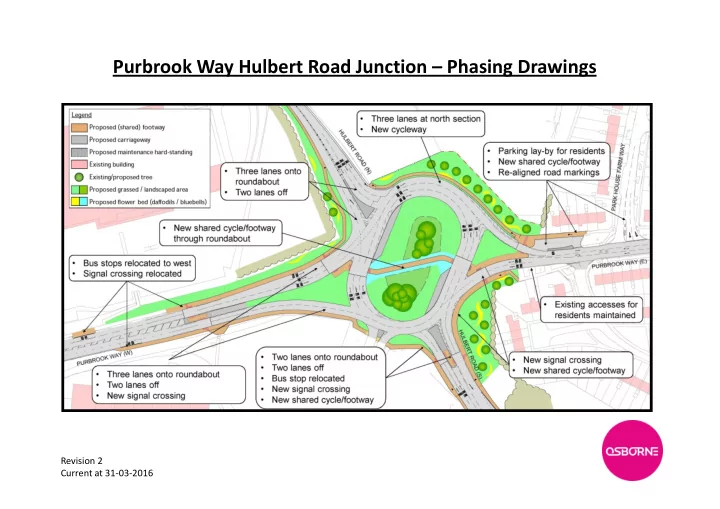

  1. Purbrook Way Hulbert Road Junction – Phasing Drawings Revision 2 Current at 31-03-2016

  2. From: Tuesday 29 th March To: Friday 1 st April Full Depth Road Construction – SE Roundabout Part 2 of 2 • Surface Water Drainage SE Rbt Part 2 of 2 • HRS • Splitter island and footway build PWW, PWE, HRN •

  3. Full Depth Road Construction – Traffic directed around B&Q roundabout SE Rbt Part 2 of 2 • • Surfacing works to west side of main Plane out and Lay Tarmac • roundabout completed in one phase – same SW Rbt Part 1 of 2 • duration as half. Surface Water Drainage SE Rbt Part 2 of 2, PWW • Splitter island and footway build PWW, PWE, HRS, HRN • From: Monday 4 th April To: Wednesday 6 th April (end of day) 3 days LEGEND Extent of TM Extent of Surfacing Asda exit lane reduced in width � Two lines of traffic cannot safely join a roundabout with only 1 lane.

  4. Kerbing Asda entrance • Splitter island works and footway build PWW, PWE, HRS, HRN, Roundabout • Signage, Guardrail, Traffic Signals, Street Lighting, CCTV works Multiple areas • From: Thursday 7 th April To: Friday 15 th April

  5. Over night closures with 4-Way Traffic Light System in place Surface Course Roundabout returned to normal operation during the day HRN and Roundabout • LEGEND Extent of TM From: Monday 18 th April Extent of Surfacing To: Thursday 21 st April 4 Nights Asda exit lane reduced in width � Single file, one direction traffic control in place

  6. Plane Out, Install Reinforcement Grid, lay Binder & Surface Course Purbrook Way (East) • LEGEND Extent of TM From: Friday 22 nd April Extent of Surfacing To: Wednesday 27 th April 4 Nights Asda exit lane reduced in width � Two lines of traffic cannot safely join a roundabout with only 1 lane.

  7. Over night closures with 4-Way Traffic Light System in place Plane Out, Install Reinforcement Grid, Roundabout returned to normal operation during the day lay Binder & Surface Course Purbrook Way (West) • LEGEND Extent of TM From: Thursday 28 th April Extent of Surfacing To: Friday 6 th May 6 Nights Note: Bank Holiday Monday 2 nd May Asda exit lane reduced in width � Single file, one direction traffic control in place � During this phase there will be the need to stop all traffic for 15-20mins to allow surfacing vehicles to lay entrance area. This will be controlled and co-ordinated with Asda and the public.

  8. Over night closures with 4-Way Traffic Light System in place Surface Course Roundabout returned to normal operation during the day Hulbert Road (South) • LEGEND Extent of TM From: Monday 9 th May Extent of Surfacing To: Friday 13 th May 5 Nights Asda exit lane reduced in width � Single file, one direction traffic control in place � During this phase there will be the need to stop all traffic for 15-20mins to allow surfacing vehicles to lay entrance area. This will be controlled and co-ordinated with Asda and the public.

  9. Break out and build Asda Splitter island (including footway crossing and original kerbing) Asda entrance/exit • Surface Course Around Asda splitter island • Signage, Guardrail, Traffic Signals, Street Lighting, CCTV, Landscaping works Multiple areas From: Monday 16 th May • To: Wednesday 18 th May 2 days Break out and kerbing • Clear for the weekend • 1 day (Wednesday 18 th May) surfacing • Asda exit lane reduced in width � Works adjacent to Asda entrance/exit required, resulting in reduced width.

  10. Notes The dates and durations detailed are the current best forecast based on • current design and programme. They are subject to change should unforeseen circumstances arise, design changes, weather etc. This phasing is different to that originally planned and has been produced • to minimise the disruption to local stakeholders and travelling public. Traffic Management layouts will be assessed when installed and may • require alteration on site to reflect Health, Safety and operational requirements.

Download Presentation
Download Policy: The content available on the website is offered to you 'AS IS' for your personal information and use only. It cannot be commercialized, licensed, or distributed on other websites without prior consent from the author. To download a presentation, simply click this link. If you encounter any difficulties during the download process, it's possible that the publisher has removed the file from their server.
