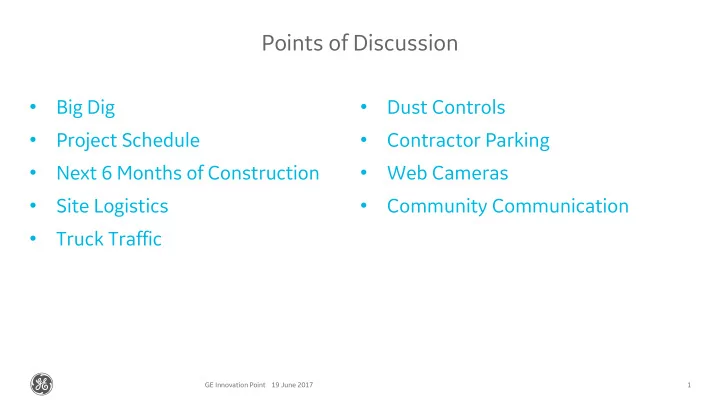

Points of Discussion

19 June 2017 1 GE Innovation Point

  • Big Dig
  • Project Schedule
  • Next 6 Months of Construction
  • Site Logistics
  • Truck Traffic
  • Dust Controls
  • Contractor Parking
  • Web Cameras
  • Community Communication
slide-2
SLIDE 2

Looking Back

19 June 2017 2 GE Innovation Point

slide-3
SLIDE 3

Big Dig! Artery/Tunnel Project

19 June 2017 3 GE Innovation Point

slide-4
SLIDE 4

Big Dig and GE Site

19 June 2017 4 GE Innovation Point

slide-5
SLIDE 5

Big Dig Fun Facts

19 June 2017 5 GE Innovation Point

  • 16 Million cy of dirt was removed to fill a

stadium to the rim 16 times

  • 541,000 truck loads if lined up equals

4,612 miles, or to Brazil as the crow flies

  • 3.8 million cy of concrete, enough to lay

sidewalk from Boston to San Francisco.

  • GE Project is exporting approximately

39,000cy

  • 1600 truck load if line up equal 8 miles.
  • 17,234 cy of concrete will be placed or 53

miles of sidewalk

slide-6
SLIDE 6

Project Schedule – 26 Months

19 June 2017 6 GE Innovation Point Weekly Report

slide-7
SLIDE 7

G3-Sheathing & Pile Driving – Summer - Fall 2017

19 June 2017 7 GE Innovation Point Weekly Report

slide-8
SLIDE 8

Site & Pile Driving Operations

Hours of operation 7:00am – 5:00pm Pre-Construction Survey Sheathing/Shoring Installation – 15 days 368 Piles – 40 Days Vibration Monitoring Dust Controls

8 19 June 2017 GE Innovation Point

slide-9
SLIDE 9

G3- Site Excavation/Utilities – Summer 2017

19 June 2017 9 GE Innovation Point Weekly Report

  • Hours of operation – 7:00am – 5:00pm
  • Excavation will include soil removals of approximately 1600 truck loads of

soil for 70 days or 22 trucks per day.

  • Necco St & Necco Ct. Utilities work will take place.
  • Dust Controls
  • Street Cleaning
slide-10
SLIDE 10

G3- Concrete Foundation – Fall 2017

19 June 2017 10 GE Innovation Point Weekly Report

slide-11
SLIDE 11

G-3 Concrete Foundations – Fall 2017

19 June 2017 11 GE Innovation Point

  • Hours of Operation – 7:00am – 6:00pm
  • Concrete placement can vary up to 250cy on a single day, this can equal

to 4-5 trucks per hours.

  • Rebar deliveries will come trailers that equal to 1-3 per day.
  • Total expected manpower 30-40 men per day.
  • Site Utilities will continue
slide-12
SLIDE 12

G3 - Steel/Concrete/ Exterior/ Interior Winter /Spring 2018

12 19 June 2017 GE Innovation Point Weekly Report

slide-13
SLIDE 13

G3 - Structural/Concrete/Exterior/Interior Winter/Early Spring 2018

19 June 2017 13 GE Innovation Point

  • Hours of Operation 7:00am – 5:00PM
  • Tower Crane Usage
  • Expected Manpower – As steel is completed will increase up to 150 men

per day

  • Steel delivery trucks will be done daily can be up to 5 per day.
  • Remaining trades will begin to arrive on site as well.
slide-14
SLIDE 14

Site Logistics – G2 Brick Building Restoration

19 June 2017 14 GE Innovation Point

slide-15
SLIDE 15

G2 Brick Renovation Schedule Summer – Fall 2017

19 June 2017 15 GE Innovation Point Weekly Report

  • Hours of operation 7:00am – 5:00pm
  • Begin with interior stabilization & restoration
  • Foundation pile caps & Concrete Core
  • Street Utilities on Necco Ct
  • Exterior restoration will also begin
  • Manpower 20-30 men
  • Truck coordination 5-8 trucks per day
slide-16
SLIDE 16

GE3 Site Logistics

19 June 2017 16 GE Innovation Point

slide-17
SLIDE 17

Truck Routes – USE THIS FOR BOTH G2 AND G3

19 June 2017 17 GE Innovation Point

slide-18
SLIDE 18

Dust Control

19 June 2017 18 GE Innovation Point

Following the City of Boston Environment Department Guidelines for Construction:

  • Wheel Wash at construction entrance
  • Vacuum sweepers to clean streets
  • Wet Saws for brick and masonry cutting
  • For re-pointing work, grinders with water spray and vacuum systems
  • General housekeeping at each level.
slide-19
SLIDE 19

Public Parking

19 June 2017 19 GE Innovation Point

https://www.google.com/maps/search/parking+lots/@42.3493513,- 71.045906,1792m/data=!3m1!1e3

slide-20
SLIDE 20

Site Cameras

19 June 2017 20 GE Innovation Point Weekly Report

slide-21
SLIDE 21

Community

19 June 2017 21 GE Innovation Point

slide-22
SLIDE 22

Community Communication Program

19 June 2017 22 GE Innovation Point Weekly Report

  • Project Website – gereports.com/Boston
  • Email – Innovation.point@ge.com
  • Toll Free Hotline 617-443-3434

All construction inquires will be forwarded to the construction team and answered in 24 hours, if not critical will be answered in 48 hours.

slide-23
SLIDE 23

XXX

19 June 2017 23 GE Innovation Point Weekly Report

slide-24
SLIDE 24

19 June 2017 24 GE Innovation Point Weekly Report

slide-25
SLIDE 25

Community Communication Program

19 June 2017 25 GE Innovation Point

Community Goals

  • Public being to reach out during work activities
  • Phone inquires will be answered during initial communication.
  • Email inquires will be answered in 24 hours
  • If a complaint is critical will inform the complainant within 24 hours
  • If a complaint is not critical will inform the complainant within 48 hours or

72 hours over a holiday or weekend.

  • Once the investigation into the complaint GE will communicate the

conclusions and action taken.

slide-26
SLIDE 26

Community Communication Program

19 June 2017 26 GE Innovation Point

Project Website – gereports.com/Boston

  • Information about the project is available on the internet
  • Information about upcoming public meetings and project announcements

is posted.

  • Links are provided to ask questions

Toll Free Hotline 617-443-3434

  • Established to allow communication ‘where project activities are being

conducted.

slide-27
SLIDE 27

Community Communication Program

19 June 2017 27 GE Innovation Point

Email – Innovation.point@ge.com

  • The public is able to communicate with the project via email
  • Link to email address is on the project website

Community Goals

  • Public being to reach out during work activities
  • Phone inquires will be answered during initial communication.
  • Email inquires will be answered in 24 hours
slide-28
SLIDE 28

19 June 2017 28 GE Innovation Point Weekly Report

slide-29
SLIDE 29

GE Innovation Point

19 June 2017 29 GE Innovation Point

slide-30
SLIDE 30

G3- Site logistics

19 June 2017 30 GE Innovation Point

slide-31
SLIDE 31

GE Innovation Point

19 June 2017 31 GE Innovation Point

slide-32
SLIDE 32

G2 Brick Building Restoration

19 June 2017 32 GE Innovation Point

slide-33
SLIDE 33

GE Innovation Point

19 June 2017 33 GE Innovation Point

slide-34
SLIDE 34

Today!

19 June 2017 34 GE Innovation Point

slide-35
SLIDE 35

Truck Routes

19 June 2017 35 GE Innovation Point

slide-36
SLIDE 36

Truck Coordination

19 June 2017 36 GE Innovation Point

slide-37
SLIDE 37

G3-Sheathing & Pile Driving – Summer - Fall 2017

19 June 2017 37 GE Innovation Point
