MWRA Annual CSO Progress Report 2014 This is the 19 th annual report. - - PowerPoint PPT Presentation

mwra annual cso progress report 2014
SMART_READER_LITE
LIVE PREVIEW

MWRA Annual CSO Progress Report 2014 This is the 19 th annual report. - - PowerPoint PPT Presentation

MWRA Annual CSO Progress Report 2014 This is the 19 th annual report. Report includes: Progress in 2014 and Q1 2015 CSO control achievements and benefits to-date Remaining activities and court/regulatory requirements Spending,


slide-1
SLIDE 1

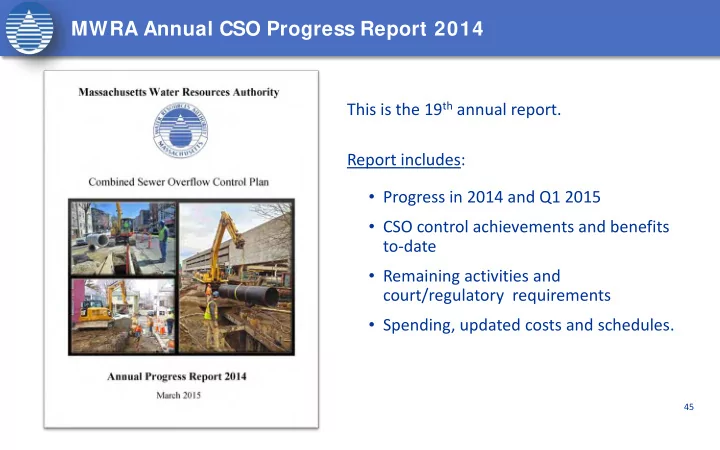

MWRA Annual CSO Progress Report 2014

45

This is the 19th annual report. Report includes:

  • Progress in 2014 and Q1 2015
  • CSO control achievements and benefits

to-date

  • Remaining activities and

court/regulatory requirements

  • Spending, updated costs and schedules.
slide-2
SLIDE 2

MWRA’s Approved Long-Term CSO Control Plan

46

  • 35 projects address site specific conditions
  • $898 million total capital cost (Prop. FY16 CIP)
  • 20-year implementation schedule (1996-2015)
  • >100 CSO milestones in federal court order require full implementation

by 2015 and performance assessment by 2020

slide-3
SLIDE 3

Summary of Achievements to Date

47

 32 of 35 projects in the CSO plan are complete.  Last 3 projects are well into construction.  CSO is eliminated at 38 of 84 CSO outfalls.  Average annual CSO volume is reduced by 86%. (3.3 billion gallons in 1988 to 0.45 billion gallons today) Goal is 0.40 billion gallons.  89% of the remaining volume is treated at MWRA’s four CSO facilities. Goal is 93% treated.

slide-4
SLIDE 4

Construction Progress

48

  • MWRA spent $22.1 million on CSO projects in calendar year 2014 .
  • 47,550 linear feet (9 miles) of drain and sewer pipe in 2014.
  • 497,500 linear feet (94.2 miles) of drain and sewer pipe since 1996.
slide-5
SLIDE 5

$69M BWSC Reserved Channel Sewer Separation

49

3 of 4 major sewer separation contracts are substantially complete. Contract 4 complete this month. Remaining work on schedule for completion by Dec 2015 court milestone.

slide-6
SLIDE 6

$2.7M Outfall MWR003 Gate and Siphon Relief

50

Construction is 40% complete.

slide-7
SLIDE 7

$94M Cambridge CAM004 Sewer Separation

51

All work on schedule for completion by Dec 2015 court milestone.

slide-8
SLIDE 8

Progress in 2014: City of Chelsea Closes Outfall CHE002

52

slide-9
SLIDE 9

Lower CSO Discharges Since 1988

53

slide-10
SLIDE 10

CSO Program Cost and Spending

54

FY15 CIP: $892.4 M

  • Prop. FY16 CIP: $898.3 M

Total CSO Program Community Projects

  • Prop. FY16 CIP Budget

$ 898.3 M $ 413.6 M Spent thru Jan 2015 $ 867.1 M $ 386.1 M Remaining to be spent $ 31.2 M $ 27.5 M Remaining Work: – Complete last three CSO projects in 2015. – Close out construction contracts and perform final eligibility reviews. – Continue to comply with Charles R. and Alewife/Upper Mystic R. CSO variances. – Assess system performance and verify attainment of long-term levels of control by Dec 2020.

slide-11
SLIDE 11

Change in Charles River Water Quality Over Time

55

Graphs show the percent of samples meeting the Enterococcus bacteria limit for swimming, by river reach.

Samples collected from:

1989-1999 2008 - 2014

Charles River mouth

North End/Coast Guard Base

Upper Charles Basin

Watertown Dam to BU Bridge Samples meeting 104 limit

Mid-basin

BU Bridge to Science Museum Samples meeting 104 limit

Downstream of Esplanade

Science Museum to New Charles Dam Samples meeting 104 limit Samples meeting 104 limit

56% 38% 11% 95% 83% 51%

Dry / Damp Light Rain Heavy Rain

82% 80% 48% 97% 100% 83%

Dry / Damp Light Rain Heavy Rain

81% 73% 32% 96% 94% 72%

Dry / Damp Light Rain Heavy Rain

93% 96% 55% 97% 95% 86%

Dry / Damp Light Rain Heavy Rain

slide-12
SLIDE 12

56

Change in Mystic River Water Quality Over Time

Samples collected from:

1989-1999 2008-2014

Upper Mystic Mainstem

Mystic Lakes to Medford Sq.

Alewife Brook

Little River to Alewife confluence Samples meeting 104 limit Samples meeting 104 limit

Lower Mystic mainstem

Rt 16 bridge to Earhart Dam

Samples meeting 104 limit

Mystic River mouth

Earhart Dam to Tobin Bridge

Samples meeting 104 limit

20% 15% 9% 55% 39% 12%

Dry / Damp Light Rain Heavy Rain

81% 45% 31% 94% 74% 42%

Dry / Damp Light Rain Heavy Rain

95% 95% 68% 99% 91% 63%

Dry / Damp Light Rain Heavy Rain

88% 74% 55% 93% 87% 65%

Dry / Damp Light Rain Heavy Rain

Graphs show the percent of samples meeting the Enterococcus bacteria limit for swimming, by river reach.

slide-13
SLIDE 13

57

Change in Neponset River Water Quality Over Time

Samples collected from:

1989-1999 2008 - 2014

Granite Ave Bridge

Near I-93, Milton/Dorchester

Lower Mills Dam

Baker Dam, Milton/Dorchester

Lower Neponset

Rt 3A bridge to Old Colony YC

Samples meeting 104 limit

Neponset River mouth

Southern Dorchester Bay

Samples meeting 104 limit Samples meeting 104 limit Samples meeting 104 limit

21% 14% 7% 90% 57% 37%

Dry / Damp Light Rain Heavy Rain

50% 34% 15% 78% 59% 48%

Dry / Damp Light Rain Heavy Rain

97% 96% 65% 100% 93% 79%

Dry / Damp Light Rain Heavy Rain

65% 45% 37% 87% 62% 44%

Dry / Damp Light Rain Heavy Rain

Graphs show the percent of samples meeting the Enterococcus bacteria limit for swimming, by river reach.

slide-14
SLIDE 14

58

South Boston Beaches Meet Bacteria Limits on More Sampling Days

TUNNEL START-UP MAY 2011

82% 96%

2006 - 2010 2011 - 2014

18% 4%

0% 5% 10% 15% 20%

2006 - 2010 2011 - 2014

% of samples failing limit

100% of samples met limits in 2014

slide-15
SLIDE 15

59

Changes in Boston Harbor Bacteria Levels in Wet Weather

Contours show the geometric means of Enterococcus data collected when more than 0.2 inches of rain fell in the previous day. Blue areas meet the EPA geometric mean swimming standard and red-purple areas exceed the standard. First panel shows data from 1989 to 1991, second panel shows data for 2008 – 2013.

Prior to Boston Harbor projects (1989-1991) Most Boston Harbor projects complete (post-2007)

slide-16
SLIDE 16

Remaining Federal Court Milestones (Schedule Seven)

60

October 2015: Complete construction of Gate, Siphon Relief and Floatables Control at Outfall MWR003 December 2015: Complete construction of CAM004 Sewer Separation Complete construction of Reserved Channel Sewer Separation March 2016: Submit annual progress report (for 2015) January 2018: Commence 3-year performance assessment, including post-construction monitoring December 2020: Submit results of 3-year performance assessment to demonstrate attainment of long-term levels of CSO control
