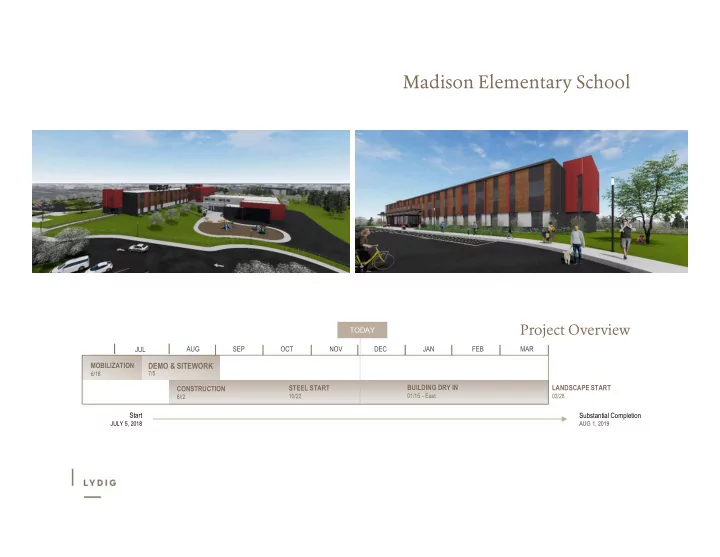

SLIDE 1 Madison Elementary School
Substantial Completion
AUG 1, 2019
Start
JULY 5, 2018
JUL MOBILIZATION
6/18
DEMO & SITEWORK
7/5
CONSTRUCTION
8//2
TODAY
Project Overview
AUG SEP OCT NOV DEC JAN FEB STEEL START
10/22
MAR BUILDING DRY IN
01/15 - East
LANDSCAPE START
03/28
SLIDE 2
Project Milestones:
Building Dry In (East) Drywall - Start Windows & Storefronts - Start Siding - Start Entire Building Dry In Landscaping – Start Substantial Completion DEC 28 JAN 02 JAN 10 JAN 24 FEB 5 MAR 28 AUG 1
Madison Elementary School
SLIDE 3
Madison Elementary School
Project Stats:
JUL - DEC Man Hours – Field Lost Time Accidents Tons of Structural Steel Steel Beams Steel Columns Bolted Steel Connections 24,742 284 636 136 5,319
SLIDE 4
Madison Elementary School
SLIDE 5
Madison Elementary School
Concrete
SLIDE 6
Madison Elementary School
Concrete
SLIDE 7
Madison Elementary School
East Wing
SLIDE 8
Madison Elementary School
East Wing
SLIDE 9
Madison Elementary School
East Wing
SLIDE 10
Madison Elementary School
West Wing
SLIDE 11 Madison Elementary School
Project Challenges:
PAST & CURRENT:
- Additional Hazardous Materials
- Local 302 Operating Engineers Strike
- Underground Storage Tank(s)
- Contaminated Soils - petroleum
- Unsuitable Soils - structure
FUTURE:
- Landscaping Rebid
- Unforseen Conditions:
Additional Contaminated Soils
SLIDE 12
Madison Elementary School
Contaminated Soils
SLIDE 13
Madison Elementary School
Construction Financials: Total Earned as of 11/30/18 Average Daily Burn Rate
OVERVIEW - Cost Impacts To Date:
Addt’l Hazardous Materials Local 302 Strike Class II & III Contaminated Soils $ 8.19M $ 71,250 $ 10,000 $ 67,000 $ 215,000
