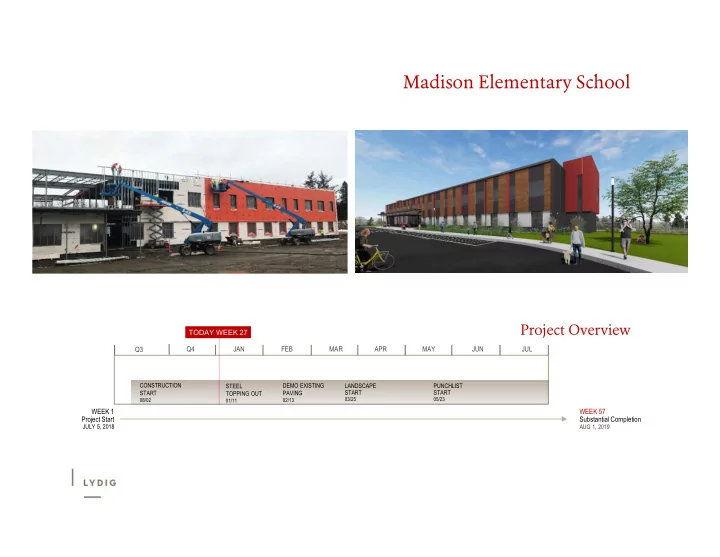

SLIDE 1 Madison Elementary School
WEEK 57 Substantial Completion
AUG 1, 2019
WEEK 1 Project Start
JULY 5, 2018
Q3
CONSTRUCTION START
08/02
TODAY WEEK 27
Project Overview
Q4 JAN FEB MAR APR MAY JUN
STEEL TOPPING OUT
01/11
JUL
LANDSCAPE START
03/25
PUNCHLIST START
05/23
DEMO EXISTING PAVING
02/13
SLIDE 2
Project Milestones:
Drywall - Start Windows & Storefronts - Start Siding - Start Entire Building Dry In Landscaping – Start Owner/Arch Punch - Start Substantial Completion JAN 02 JAN 10 JAN 24 FEB 5 MAR 28 MAY 23 AUG 1
Madison Elementary School
SLIDE 3
Madison Elementary School
Project Stats:
July thru End-Of-Year 2018
Man Hours – Field Lost Time Accident(s) 32,405 1 284 Tons of Structural Steel 1,400 Cubic Yards of Concrete
SLIDE 4
Madison Elementary School
West Wing
SLIDE 5
Madison Elementary School
North & West Wing
SLIDE 6
Madison Elementary School
North Wing
SLIDE 7
Madison Elementary School
Gymnasium
SLIDE 8
Madison Elementary School
Gymnasium
SLIDE 9
Madison Elementary School
West Wing
SLIDE 10
Madison Elementary School
West Wing
SLIDE 11 Madison Elementary School
Project Challenges:
PAST:
- Additional Hazardous Materials
- Local 302 Operating Engineers Strike
- Underground Storage Tank(s)
- Contaminated Soils - petroleum
- Unsuitable Soils - structure
CURRENT & FUTURE:
- Landscaping – Award Contract
- Unforseen Conditions:
Additional Contaminated Soils
SLIDE 12
Madison Elementary School
Construction Financials:
Contract Value Total Earned as of 12/31/18 (approx. given holiday) Average Daily Burn Rate OVERVIEW - Cost Impacts To Date: Addt’l Hazardous Materials Local 302 Strike Class II & III Contaminated Soils $31,613,692 $ 10,500,000 $ 77,800 $ 10,000 $ 54,000 $ 215,000
