Level Crossing Removal Project Kevin Devlin CEO, Level Crossing - - PowerPoint PPT Presentation

level crossing removal project
SMART_READER_LITE
LIVE PREVIEW

Level Crossing Removal Project Kevin Devlin CEO, Level Crossing - - PowerPoint PPT Presentation

Level Crossing Removal Project Kevin Devlin CEO, Level Crossing Removal Authority Level Crossing Removal Project Status Update 1 level crossing completed Over $2.8 billion in contracts awarded 18 in construction The


slide-1
SLIDE 1

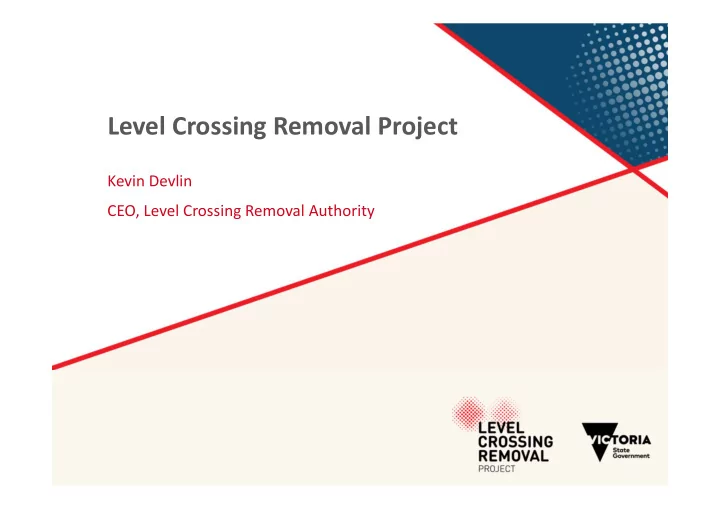

Level Crossing Removal Project

Kevin Devlin CEO, Level Crossing Removal Authority

slide-2
SLIDE 2

Level Crossing Removal Project – Status Update

  • 1 level crossing completed
  • Over $2.8 billion in contracts

awarded

  • 18 in construction
  • The first 35 level crossings have

been identified for removal, with construction on those 35 sites to either be complete or underway by the end of 2018.

  • At least 20 on schedule to be

complete by end of 2018

  • Planning and consultation underway

to deliver entire program.

slide-3
SLIDE 3

Level Crossings:

Burke Road, Glen Iris - completed North Road, Ormond – under construction, completion late 2016 Centre Road, Bentleigh – under construction, completion late 2016 McKinnon Road, McKinnon – under construction, completion late 2016 Furlong Road, St Albans – under construction, completion mid 2017 Main Road, St Albans – under construction, completion mid 2017 Blackburn Road, Blackburn – under construction, completion late 2017 Heatherdale Road, Mitcham – under construction, completion late 2017 Mountain Highway, Bayswater – under construction, completion late 2017 Scoresby Road, Bayswater – under construction, completion late 2017

slide-4
SLIDE 4

Level Crossings:

Grange Rd, Carnegie – contract awarded, completion late 2018 Koornang Rd, Carnegie – contract awarded, completion late 2018 Murrumbeena Rd, Murrumbeena – contract awarded, completion late 2018 Poath Rd, Hughesdale – contract awarded, completion late 2018 Clayton Rd, Clayton – contract awarded, completion late 2018 Centre Rd, Clayton – contract awarded, completion late 2018 Corrigan Rd, Noble Park – contract awarded, completion late 2018 Heatherton Rd, Noble Park – contract awarded, completion late 2018 Chandler Rd, Noble Park – contract awarded, completion late 2018 Thompsons Road, Lyndhurst – in procurement phase, completion late 2018 Melton Highway, Sydenham – pre-procurement phase, completion late 2018

slide-5
SLIDE 5

Level Crossings:

Kororoit Creek Road, Williamstown - planning and consultation, under construction by end of 2018 Abbotts Road, Dandenong South - planning and consultation, under construction by end of 2018 Charman Road, Cheltenham - planning and consultation, under construction by end of 2018 Balcolme Road, Mentone - planning and consultation, under construction by end of 2018 Edithvale Road, Edithvale - planning and consultation, under construction by end of 2018 Station Street, Bonbeach - planning and consultation, under construction by end of 2018 Station Street, Carrum - planning and consultation, under construction by end of 2018 Eel Race Road, Seaford - planning and consultation, under construction by end of 2018 Seaford Road, Seaford - planning and consultation, under construction by end of 2018 Skye/Overton Road - Frankston, planning and consultation, under construction by end of 2018 Bell Street, Preston - planning and consultation, under construction by end of 2018 High Street, Reservoir - planning and consultation, under construction by end of 2018 Grange Road, Alphington - planning and consultation, under construction by end of 2018 Lower Plenty Road, Rosanna - planning and consultation, under construction by end of 2018

slide-6
SLIDE 6

Level Crossings:

Aviation Road, Laverton – early planning, completion by 2022 Bell Street, Coburg – early planning, completion by 2022 Buckley Street, Essendon – early planning, completion by 2022 Camp Road, Campbellfield – early planning, completion by 2022 Cherry Street, Werribee – early planning, completion by 2022 Clyde Road, Berwick – early planning, completion by 2022 Ferguson Street, Williamstown – early planning, completion by 2022 Glenroy Road, Glenroy – early planning, completion by 2022 Hallam Road South, Hallam – early planning, completion by 2022 Manchester Road, Mooroolbark – early planning, completion by 2022 Maroondah Highway, Lilydale – early planning, completion by 2022 Moreland Road, Brunswick – early planning, completion by 2022 South Gippsland Highway – early Dandenong planning, completion by 2022 Toorak Road, Kooyong – early planning, completion by 2022 Werribee Street, Werribee – early planning, completion by 2022

slide-7
SLIDE 7

Other Projects – Status Update

  • Cranbourne-Pakenham Line Upgrade ($608 million) – contract

awarded, completion late 2018

  • Mernda Rail Extension ($598 million) – budget announced, EoI process

underway, completion in 2019

  • Duplication of the Hurstbridge line ($140million) – planning and

consultation yet to commence, completion late 2018

slide-8
SLIDE 8
