Kaituna River Re-diversion and Te Awa o Ngatoroirangi / Maket - - PowerPoint PPT Presentation

kaituna river re diversion and te awa o ngatoroirangi
SMART_READER_LITE
LIVE PREVIEW

Kaituna River Re-diversion and Te Awa o Ngatoroirangi / Maket - - PowerPoint PPT Presentation

Kaituna River Re-diversion and Te Awa o Ngatoroirangi / Maket Estuary Enhancement Project 2 May 2018 Update Meeting agenda 1. Background to project 2. What has been done? 3. Introducing J Swap Contractors 4. What work is planned? 5. How


slide-1
SLIDE 1

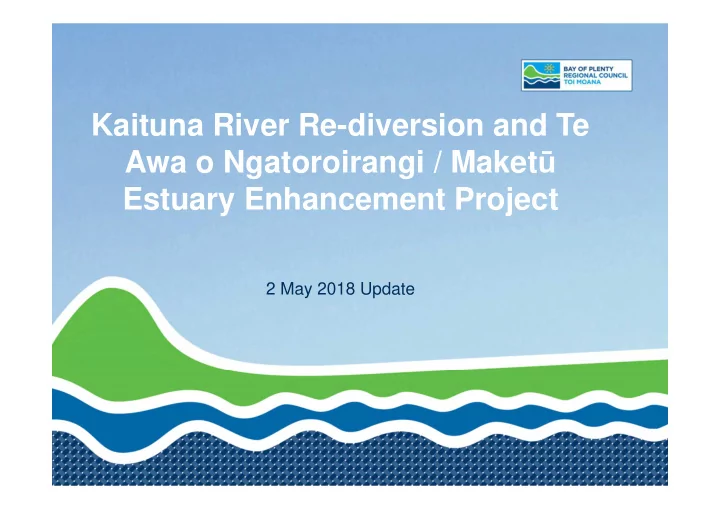

Kaituna River Re-diversion and Te Awa o Ngatoroirangi / Maketū Estuary Enhancement Project

2 May 2018 Update

slide-2
SLIDE 2

Meeting agenda

  • 1. Background to project
  • 2. What has been done?
  • 3. Introducing J Swap Contractors
  • 4. What work is planned?
  • 5. How will that affect you?
  • 6. How will we communicate?
  • 7. He patai / questions
slide-3
SLIDE 3

Background

slide-4
SLIDE 4

4

slide-5
SLIDE 5

5

slide-6
SLIDE 6

2011 Aerials

slide-7
SLIDE 7

The flood tide delta – lower estuary full of sand

slide-8
SLIDE 8

Gracilaria algae and anoxic mud

slide-9
SLIDE 9

Lingbya and Ulva flexuosa algae at Papahikahawai

slide-10
SLIDE 10

Meeting agenda

  • 1. Background to project
  • 2. What has been done?
  • 3. Introducing J Swap Contractors
  • 4. What work is planned?
  • 5. How will that affect you?
  • 6. How will we communicate?
  • 7. He patai / questions
slide-11
SLIDE 11

Progress to date

  • 45ha land acquisition
  • Investigations, modelling
  • Consenting and appeals
  • Causeway removal
  • Papahikahawai Bridge
  • Chenier creation
  • 20,000 plants so far
  • Power and water lines
slide-12
SLIDE 12
slide-13
SLIDE 13

Meeting agenda

  • 1. Background to project
  • 2. What has been done?
  • 3. Introducing J Swap Contractors
  • 4. What work is planned?
  • 5. How will that affect you?
  • 6. How will we communicate?
  • 7. He patai / questions
slide-14
SLIDE 14
  • Company

established 1937 in Matamata

  • 3rd generation of

Swap family

  • 500 employees
  • Key personnel for

this project are: Mike Swap Shanan Mowatt Paul Baker Dudley Clements Sean Paterson 027 642 0935

sean.paterson@jswap.co.nz

slide-15
SLIDE 15
slide-16
SLIDE 16

Meeting agenda

  • 1. Background to project
  • 2. What has been done?
  • 3. Introducing J Swap Contractors
  • 4. What work is planned?
  • 5. How will that affect you?
  • 6. How will we communicate?
  • 7. He patai / questions
slide-17
SLIDE 17

What work is planned?

  • Final pre-start monitoring
  • Pre-start blessing
  • J Swap will set up on site next to ‘Uncle

Boys’ / Tukotahi Marae on Ford Rd late June

  • Pre-start ceremony and release of Kaituna

River Document early July

  • Haul roads and stopbank from August
  • New inlet channel excavation
  • 4 culverts to be replaced with 12 larger ones
slide-18
SLIDE 18

What work is planned?

  • Widening of Ford’s Cut
  • Creation of salinity block and boat berths
  • Wetland creation on Te Paika
  • Removal of Papahikahawai causeways
  • Planting on Te Paika and Papahikahawai
  • Construction will take two years
  • Commissioning planned in June 2020
slide-19
SLIDE 19
slide-20
SLIDE 20

Meeting agenda

  • 1. Background to project
  • 2. What has been done?
  • 3. Introducing J Swap Contractors
  • 4. What work is planned?
  • 5. How will that affect you?
  • 6. How will we communicate?
  • 7. He patai / questions
slide-21
SLIDE 21

How will you be affected?

  • Ford Rd will be closed from 1 August until 20

December 2018 at the pump station

  • Alternative white baiting access will be

available on south side of Ford’s Cut

  • The boat ramp on Ford Rd will be closed

from 1 August 2018 for construction

  • Alternative boat ramps at Bell Rd and

Maketū

  • In the long run, a healthier estuary
slide-22
SLIDE 22

Meeting agenda

  • 1. Background to project
  • 2. What has been done?
  • 3. Introducing J Swap Contractors
  • 4. What work is planned?
  • 5. How will that affect you?
  • 6. How will we communicate?
  • 7. He patai / questions
slide-23
SLIDE 23

Communication

  • Project webpage at:

www.boprc.govt.nz/kaitunamaketurediversion

  • Register there for email updates
  • Regular community and stakeholder meetings
  • Updates in MaiMaketu and Te Puke Times
  • BOP Regional Council Facebook
  • How would you like us to communicate?
slide-24
SLIDE 24

Meeting agenda

  • 1. Background to project
  • 2. What has been done?
  • 3. Introducing J Swap Contractors
  • 4. What work is planned?
  • 5. How will that affect you?
  • 6. How will we communicate?
  • 7. He patai / questions
slide-25
SLIDE 25

He patai, any questions?

slide-26
SLIDE 26

Papahikahawai bridge construction and grand opening

slide-27
SLIDE 27

Creation of 1km of southern shoreline as a chenier

(allowing a more natural interface with the estuary)

slide-28
SLIDE 28

Removal of pampas covered bund. Creation of new chenier and planting.

June 2017 October 2017

slide-29
SLIDE 29

Native planting progress

June 2017 October 2017

slide-30
SLIDE 30

Clearing out of algae build up following causeway removal

March 2017 Now

slide-31
SLIDE 31

The removal of the first causeway saw rapid improvements

6 June 2017 Now

slide-32
SLIDE 32

Maketu Whanau Planting 2017
