Designing for Permeable Pavement: Long Term Performance and Cost - - PowerPoint PPT Presentation

designing for permeable pavement long term performance
SMART_READER_LITE
LIVE PREVIEW

Designing for Permeable Pavement: Long Term Performance and Cost - - PowerPoint PPT Presentation

Designing for Permeable Pavement: Long Term Performance and Cost Efficiency David Hein, P.Eng. Principal Engineer Vice President, Transportation Permeable Surface Open Graded Base Open Graded Subbase Subgrade 1 Long Term Performance


slide-1
SLIDE 1

1

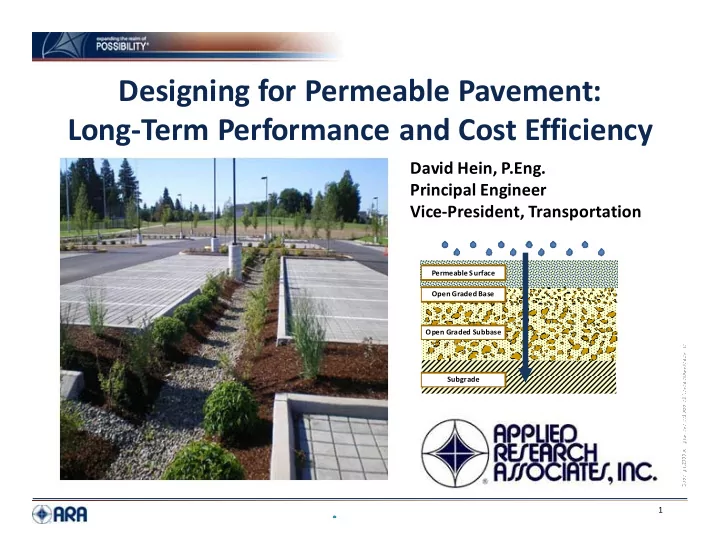

Designing for Permeable Pavement: Long‐Term Performance and Cost Efficiency

David Hein, P.Eng. Principal Engineer Vice‐President, Transportation

Permeable Surface Open Graded Base Open Graded Subbase Subgrade

slide-2
SLIDE 2

2

Long‐Term Performance and Cost Efficiency

  • Introduction to Permeable Pavement
  • Design
  • Construction
  • Maintenance
  • Resources
  • Questions
slide-3
SLIDE 3

3

Impact of Urbanization

  • Point A
  • Point B
  • Point C
  • Point D
  • Point E
slide-4
SLIDE 4

4

The Problem ‐ Increased Flood Flows

Urban Area Flooding

slide-5
SLIDE 5

5

Permeable Pavements – A Green Solution

  • In percolating soils, increases infiltration
  • Reduces stormwater volume/peak flows
  • Reduces stormwater pollutant load
  • Decreases downstream erosion
slide-6
SLIDE 6

6

Early Permeable Pavements

slide-7
SLIDE 7

7

Pervious, Porous & Permeable Pavements

Pavement system designed to permit the infiltration of surface water

slide-8
SLIDE 8

8

Porous Asphalt

slide-9
SLIDE 9

9

Pervious Concrete

slide-10
SLIDE 10

10

Permeable Interlocking Concrete Pavers

slide-11
SLIDE 11

11

Permeable Pavement Functions

Permeable Surface Open Graded Base Open Graded Subbase Subgrade Permeable Surface Open Graded Base Open Graded Subbase Subgrade

Outlet Pipe

Permeable Surface Open Graded Base Open Graded Subbase Subgrade

Outlet Pipe

slide-12
SLIDE 12

12

Design Guides

slide-13
SLIDE 13

13

Array of Different Design Tools

slide-14
SLIDE 14

14

slide-15
SLIDE 15

15

Structural Design ‐ AASHTO

slide-16
SLIDE 16

16

Subgrade Type and Quality

  • Subgrade support is one of the most important

parameters governing pavement structural design

  • Best (complete resilient modulus testing from in‐situ

materials to determine input values)

  • Fair (estimate resilient modulus based on other site or

subgrade materials testing, i.e. FWD back‐calculation, dynamic cone penetrometer, California Bearing Ratio)

  • Poor (select based on ‘typical’ subgrade type and

drainage ability

slide-17
SLIDE 17

17

Subgrade Type and Quality

  • Possible Source – ASCE

58‐10 Publication

  • Current ASCE design

standard for permeable pavement design under development

slide-18
SLIDE 18

18

Infiltration Test Apparatus

slide-19
SLIDE 19

19

Site Design

slide-20
SLIDE 20

20

Source of Water – Contributing Area

slide-21
SLIDE 21

21

Evaluate Site Suitability

slide-22
SLIDE 22

22

Key Decision Factors

Considerations Description Availability of capital funding The initial capital construction cost of permeable pavement is typically higher than for conventional pavement. Overall long‐term life‐cycle costs can be very competitive if consideration is given to stormwater quality and quantity benefits are taken into account. Status of environmental approval In some jurisdictions, permeable pavement may not be permitted or may require additional environmental approvals. Proximity to environmentally sensitive areas The presence of protected watersheds, cold water streams, marshland, etc. may preclude the use of permeable pavement systems or require more extensive treatments. Safety Ability to accommodate safety features such as rumble strips, vegetative growth, areas subjected to rapid icing, etc. Significant longitudinal grades Not recommended for grades of more than 5 percent as sheet flow may overload the ability of the permeable shoulder to infiltrate water which may cause localized flooding. Depth of water table Permeable pavements should not be used in areas where the water table is within 0.6 m (2ft) of the top of the soil subgrade. It must be possible to drain water entering the subgrade. Significant use of sand and/or salt for winter maintenance Melting salt will result in higher concentrations of chlorides in the water which may hinder plant growth. Winter sand may clog permeable pavement systems resulting in reduced system permeability. Risk of accidental chemical spill Is the permeable pavement location in an area where hazardous chemical transportation is present.

slide-23
SLIDE 23

23

Key Decision Factors

Considerations Description Amount and intensity of precipitation May not be suitable in areas of frequent, high intensity storms. Presence of utilities The design and construction of permeable shoulders may be problematic in areas where utilities are present along the roadway shoulders. Risk of flooding Areas subject to frequent flooding may require supplemental drainage features to ensure that the roadway surface is properly drained. Mandates for water quality Permeable pavements may contribute substantially to water quality improvement. Mandates for stormwater management Permeable pavements provide stormwater management alternatives to more costly or complicated practices. Maintenance protocols Permeable pavement systems require mandatory non‐traditional maintenance practices such as vacuum sweeping. Shoulder utilization Some shoulders are used as driving lanes for specification conditions

  • r circumstances, e.g. evacuation routes, rush hour traffic, pullovers

for passing, high occupancy vehicle routes, emergency vehicles, etc. Interest in innovation Utilizing traditional impermeable surfaces for stormwater management provides opportunities for innovation. Complexity of geometric conditions Geometric constraints such as horizontal or vertical grades, presence

  • f bridge structures, curbs, retaining walls, guiderails, etc.

Impact of unknown site conditions Variability of soil conditions, presence of organics, potential for frost heave, etc. may impact shoulder pavement performance. Owner experience and resources The use of permeable pavements for roadway shoulder is very limited a present.

slide-24
SLIDE 24

24

Decision Support Tools

  • A. Primary Considerations

Part A Weighting: 60 Consideration Rating Weighting Weighted Value Low Medium High Availbility of Capital Funding Medium 20.0 12.0 No specific funding available Need to justify funding Project funded Status of Environmental Approval Medium 20.0 12.0 Application required Approval pending Approved Prox imity to Enviornmentally Sensitive Areas Low 20.0 4.0 Adjacent Within watershed area Outside of watershed area Safety High 10.0 10.0 Significant safety issues Safety issues can be addressed Minimal safety issues Significant Grades High 10.0 10.0 Grades > 5 percent Grades of 3 to 4 percent Grades < 3 percent Depth of Water Table Medium 20.0 12.0 Water table < 0.6 m below subgrade Water table 0.6‐0.9 m below subgrade Water table > 0.9 m below subgrade Total 100.0 60.0 Weighted Total: 36.0

  • B. Secondary Considerations

Part B Weighting: 30 Consideration Rating Weighting Weighted Value Low Medium High Salt/Sand use for Winter Maintenance High 10.0 10.0 Used for >4 months Used 1 to 4 months/year Used < 1 month/year Risk of Accidental Chemical Spill High 10.0 10.0 Located in chemical/industrial area On major trucking route Limited exposure Amount and Intensity of Precipitation Medium 15.0 9.0 Intense storms Moderate frequency/intensity Frequent/non‐intense storm Presence of Utilities High 10.0 10.0 Critical utilities Non‐critical utilties None Risk of Flooding Medium 10.0 6.0 Frequent Occasional None Mandates for Water Quality High 10.0 10.0 No concerns Some water quality issues Water quality concerns Mandates for Stormwater Management High 15.0 15.0 No concerns Some stormwater management issues Stormwater management concerns Maintenance Protocols Low 10.0 2.0 Minimal maintenance Reactive maintenance Proactive maintenance Traffic Utilization High 10.0 10.0 Heavy traffic use Occassional traffic use Use for emergency use only Total 100.0 82.0 Weighted Total: 24.6

  • C. Other Considerations

Part C Weighting: 10 Consideration Rating Weighting Weighted Value Low Medium High Interest in Innovation Low 25.0 5.0 Minimal interest Innovation encouraged Regular innovation implementation Complex ity of Geometric Conditions High 25.0 25.0 Significant geometric restrictions Some geometric challenges Minimal geometric restrictions Impact of Unknown Site Conditions Medium 25.0 15.0 No site specific information available Some site information available Site conditions well known Owner Experience and Resources Low 25.0 5.0 No owner experience Limited owner experience Significant owner experience Total 100.0 50.0 Weighted Total: 5.0

Sub Totals

  • A. Primary Considerations

60 36.0 From To Implement Alternative

  • B. Secondary Considerations

30 24.6 65 No

  • C. Other Considerations

10 5.0 65 75 Can Consider Grand Total 100 65.6 75 100 Yes Decision Can Consider Weighting Guidelines Weighting Guidelines Weighting Guidelines Decision Range

slide-25
SLIDE 25

25

Decision Support Tools

  • A. Primary Considerations

Part A Weighting: 60 Consideration Rating Weighting Weighted Value Availbility of Capital Funding Medium 20.0 12.0 Status of Environmental Approval Medium 20.0 12.0 Proximity to Enviornmentally Sensitive Areas Low 20.0 4.0 Safety High 10.0 10.0 Significant Grades High 10.0 10.0 Depth of Water Table Medium 20.0 12.0 Total 100.0 60.0 Weighted Total: 36.0

Low Medium High No specific funding available Need to justify funding Project funded Application required Approval pending Approved Adjacent Within watershed area Outside of watershed area Significant safety issues Safety issues can be addressed Minimal safety issues Grades > 5 percent Grades of 3 to 4 percent Grades < 3 percent Water table < 0.6 m below subgrade Water table 0.6‐0.9 m below subgrade Water table > 0.9 m below subgrade Weighting Guidelines

slide-26
SLIDE 26

26

Decision Support Tools

Decision Range

  • A. Primary

Considerations 60 36.0 From To Implement Alternative

  • B. Secondary

Considerations 30 24.6 65 No

  • C. Other

Considerations 10 5.0 65 75 Can Consider Grand Total 100 65.6 75 100 Yes Decision Can Consider

slide-27
SLIDE 27

27

Subgrade Preparation

slide-28
SLIDE 28

28

Subdrains

Pavers + (50 mm ASTM #8) Base (100 mm ASTM #57) Subbase (200 mm ASTM #2) Subbase (125 mm CDOT Class 5)

slide-29
SLIDE 29

29

Subdrains

slide-30
SLIDE 30

30

Base Materials

  • Availability

– Local DOT aggregate specifications – Industry recommendations – Local aggregate sources

  • Compaction

– No standard Proctor density – Establish target density – Roller versus plate compactor (parking lot/driveway) – Lift thickness

  • Angularity and hardness
slide-31
SLIDE 31

31

Base/Subbase Compaction

slide-32
SLIDE 32

32

Use the Right Equipment

slide-33
SLIDE 33

33

Not the Wrong Equipment

slide-34
SLIDE 34

34

Final Uniform Surface

slide-35
SLIDE 35

35

Paver Installation

  • Mechanical installation reduces

construction time

  • No curing – immediate availability

to traffic

  • Can be reinstated after repairs
  • Guide construction specs at

www.icpi.org

slide-36
SLIDE 36

36

Pervious Concrete Installation

slide-37
SLIDE 37

37

Pervious Concrete Installation

slide-38
SLIDE 38

38

Maintenance

  • Annually: inspection of observation well after major

storm, vacuum and sweep surface – improves infiltration

  • Maintenance checklist
  • Model maintenance agreement
slide-39
SLIDE 39

39

slide-40
SLIDE 40

40

Small Scale Permeability Improvements

slide-41
SLIDE 41

41

Larger Scale Maintenance

slide-42
SLIDE 42

42

slide-43
SLIDE 43
slide-44
SLIDE 44
slide-45
SLIDE 45
slide-46
SLIDE 46
slide-47
SLIDE 47
slide-48
SLIDE 48
slide-49
SLIDE 49
slide-50
SLIDE 50

50

Winter Maintenance

slide-51
SLIDE 51

51

Winter Maintenance

slide-52
SLIDE 52

52

Keep Site Clean During Construction

slide-53
SLIDE 53

53

Detailing – Poor Practice

slide-54
SLIDE 54

54

Permeable

slide-55
SLIDE 55

55

Permeable

slide-56
SLIDE 56

56

Restrict Heavy Vehicles

slide-57
SLIDE 57

57

Permeable Pavement Details/Examples

slide-58
SLIDE 58

58

Zorinsky Recreation Complex Omaha, NE

slide-59
SLIDE 59

59

Thule Street, Colorado

slide-60
SLIDE 60

60

slide-61
SLIDE 61

61

slide-62
SLIDE 62

62

Things Not to Do

Manhattan, Kansas

slide-63
SLIDE 63

63

Sidewalk Features

slide-64
SLIDE 64

64

Main Street ‐ Fort Morgan, Colorado

slide-65
SLIDE 65

65

Toronto Botanical Gardens

slide-66
SLIDE 66

66

Brampton Veterinary Hospital

slide-67
SLIDE 67

67

Brampton Commuter Parking Lot

slide-68
SLIDE 68

68

Natural Stone

slide-69
SLIDE 69

69

Things Not to Do

slide-70
SLIDE 70

70

Things Not to Do

slide-71
SLIDE 71

71

Things Not to Do

slide-72
SLIDE 72

72

Alleyways

slide-73
SLIDE 73

73

Dealing with Slopes

slide-74
SLIDE 74

74

Alleyway

slide-75
SLIDE 75

75

Completed Alleyway

slide-76
SLIDE 76

76

Permeable Roadway Shoulders

Subgrade Impermeable Liner (Optional) Drainage Pipe

Lane Permeable Shoulder

Dense Graded Subbase Surface Course Dense Graded Base Perforated Channel

slide-77
SLIDE 77

77

Detailing – Poor Practice

slide-78
SLIDE 78

78

Detailing – Poor Practice

slide-79
SLIDE 79

79

Detailing – Poor Practice

slide-80
SLIDE 80

80

Settlement of Base/Subbase

slide-81
SLIDE 81

81

Settlement and Ponding at Transition

slide-82
SLIDE 82

82

Jointing for Pervious Concrete

  • Many are not jointed at all – random cracking is not

considered a negative on the textured surface

slide-83
SLIDE 83

83

Strange Choice of Joint Location

slide-84
SLIDE 84

84

Poor Construction Joint

slide-85
SLIDE 85

85

Poor Jointing

slide-86
SLIDE 86

86

Special Features of Some Pavers

slide-87
SLIDE 87

87

Loss of Permeability or Heavy Flows

slide-88
SLIDE 88

88

Deep Clogging

slide-89
SLIDE 89

89

Joint Raveling

slide-90
SLIDE 90

90

Large Scale Raveling

slide-91
SLIDE 91

91

High Severity Raveling

slide-92
SLIDE 92

92

High Severity Raveling

slide-93
SLIDE 93

93

Asphalt Raveling

slide-94
SLIDE 94

94

Conventional Paver Surface

slide-95
SLIDE 95

95

Turn into a Permeable Pavement???

slide-96
SLIDE 96

96

What is Wrong Here?

slide-97
SLIDE 97

97

Joint Much Too Wide

slide-98
SLIDE 98

98

Too Complicated

slide-99
SLIDE 99

99

Very Good

slide-100
SLIDE 100

100

No Sliver Pieces

slide-101
SLIDE 101

101

Keys to a Successful Project

  • Carefully consider the site conditions
  • Both structural and hydrological design
  • Proper specifications
  • Pre‐construction meeting
  • Inspection during construction
  • Keep the site clean
