Alafaya Trail Project Update Avalon Park Boulevard to Mark Twain - - PowerPoint PPT Presentation

alafaya trail project update
SMART_READER_LITE
LIVE PREVIEW

Alafaya Trail Project Update Avalon Park Boulevard to Mark Twain - - PowerPoint PPT Presentation

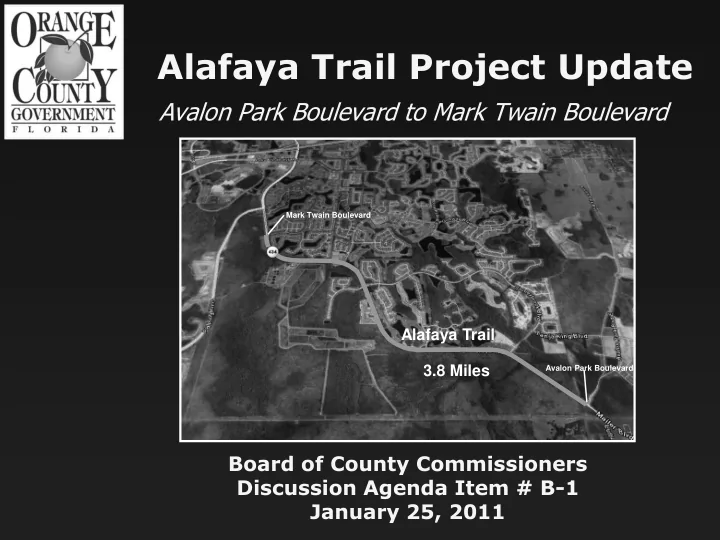

Alafaya Trail Project Update Avalon Park Boulevard to Mark Twain Boulevard Mark Twain Boulevard Alafaya Trail 3.8 Miles Avalon Park Boulevard Board of County Commissioners Discussion Agenda Item # B-1 January 25, 2011 Alafaya Trail Project


slide-1
SLIDE 1

Alafaya Trail Project Update

Avalon Park Boulevard to Mark Twain Boulevard

Mark Twain Boulevard Avalon Park Boulevard

3.8 Miles Alafaya Trail

Board of County Commissioners Discussion Agenda Item # B-1 January 25, 2011

slide-2
SLIDE 2

Alafaya Trail Project Update

Avalon Park Boulevard to Mark Twain Boulevard

 Project

History

 Procurement

and Construction

 Action

Requested

Mark Twain Boulevard Avalon Park Boulevard

3.8 Miles Alafaya Trail

slide-3
SLIDE 3

Alafaya Trail Project Update

Avalon Park Boulevard to Mark Twain Boulevard

 Project

History

 Procurement

and Construction

 Action

Requested

Mark Twain Boulevard Avalon Park Boulevard

3.8 Miles Alafaya Trail

slide-4
SLIDE 4

Planning, Design & Right-of-Way

 Identified in Comprehensive Plan  Public/Private Partnership Agreement

Approved by BCC – Avalon & Associates: Design – Morgran: Up-Fronted Cash & Ponds

 Construction Plans Finalized 2009  Right-of-Way Acquisition Completed

August 2010

Project History

slide-5
SLIDE 5

Design Elements

 10 Stormwater

Ponds

 4 Travel Lanes  Raised Grass

Median

 12,000 Feet of

Retaining Wall

Project History

 Utility Work

– Wastewater, Reuse, Water Mains (Pipe Size Varies from 24” to 36”)

slide-6
SLIDE 6

Design Elements

 3 Signalized Intersections (One New)  No Landscaping or Lighting Due to Budgetary

Constraints

Project History

Existing Signal Upgrade Golfway Bv. Existing Signal Upgrade Innovation Way New Signal Stoneybrook Bv.

slide-7
SLIDE 7

Alafaya Trail Project Update

Avalon Park Boulevard to Mark Twain Boulevard

 Project

History

 Procurement

and Construction

 Action

Requested

Mark Twain Boulevard Avalon Park Boulevard

3.8 Miles Alafaya Trail

slide-8
SLIDE 8

Construction

 Anticipated BCC Approval - January 25, 2011  Anticipated Contract Execution - February 1, 2011  Anticipated Notice to Begin Construction -

February 15, 2011

Procurement and Construction

slide-9
SLIDE 9

Construction

 Construction Duration 2-1/2 Years

(August 2013)

 County’s

$19.6 Million Roadway Estimate: $11.1 Million Utilities $30.7 Million Total

Procurement and Construction

slide-10
SLIDE 10

Construction Bids:

Company Estimated Bid Amount

  • Jr. Davis

$30,203,373 Halifax $31,042,574 Prince $33,359,946 Ranger $34,610,030 County’s $30,700,000 Estimate

Procurement and Construction

slide-11
SLIDE 11

Alafaya Trail Project Update

Avalon Park Boulevard to Mark Twain Boulevard

 Project

History

 Procurement

and Construction

 Action

Requested

Mark Twain Boulevard Avalon Park Boulevard

3.8 Miles Alafaya Trail

slide-12
SLIDE 12

Approval to award Invitation for Bids Y11-708-CH, Alafaya Trail Widening Project (from Avalon Park Boulevard to Mark Twain Boulevard), to the low responsive and responsible bidder, Jr. Davis Construction Company, Inc., in the total estimated contract award amount of $30,203,372.92.

Action Requested
