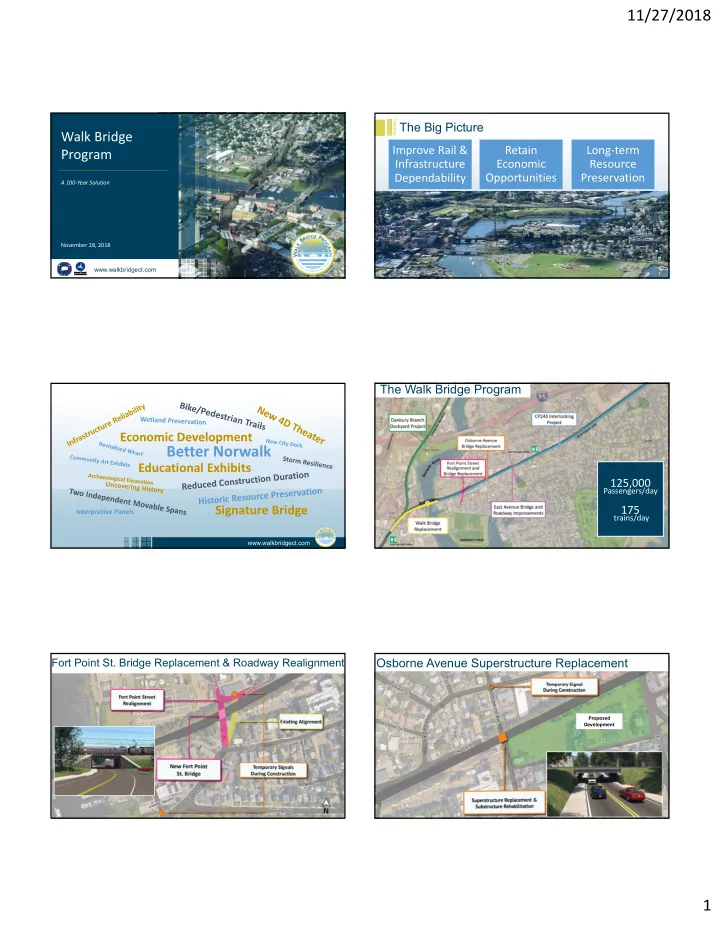

11/27/2018 The Big Picture Walk Bridge Improve Rail & Retain Longterm Program Infrastructure Economic Resource Dependability Opportunities Preservation A 100Year Solution November 28, 2018 www.walkbridgect.com


slide-1
SLIDE 1

11/27/2018 1

www.walkbridgect.com www.walkbridgect.com

Walk Bridge Program

November 28, 2018 A 100‐Year Solution www.walkbridgect.com www.walkbridgect.com

The Big Picture Improve Rail & Infrastructure Dependability Long‐term Resource Preservation Retain Economic Opportunities

www.walkbridgect.com

Better Norwalk

Economic Development Educational Exhibits

Interpretive Panels

Signature Bridge

www.walkbridgect.com

125,000

Passengers/day

175

trains/day

The Walk Bridge Program

www.walkbridgect.com

Fort Point St. Bridge Replacement & Roadway Realignment

www.walkbridgect.com

Osborne Avenue Superstructure Replacement

Proposed Development

slide-2
SLIDE 2

11/27/2018 2

www.walkbridgect.com

East Ave. Bridge Replacement & Roadway Improvements

www.walkbridgect.com www.walkbridgect.com

Walk Bridge Replacement Project

MNR Cable Relocation

www.walkbridgect.com

$1.2 Billion Program

$937M

$234M

Engineering & ROW

Construction

60% 12%

Federal (40%) State

Sandy Grant

28%

www.walkbridgect.com

Estimated Construction Cost ($937 Million)

$511 $242 $89

$26

$20

$27

$12 $10

Walk Bridge CP243 Interlocking Danbury Dockyard East Ave. Fort Point Utility Relocation

Retaining Wall

Osborne Ave.

www.walkbridgect.com

Bridge Design

www.walkbridgect.com www.walkbridgect.com

Design Considerations

slide-3
SLIDE 3

11/27/2018 3

www.walkbridgect.com www.walkbridgect.com

North Water Street Area

New Theater Wharf Area

www.walkbridgect.com

Multimodal Accommodations

Wharf Area

www.walkbridgect.com

TEMPORARY SIGNALS DURING CONSTRUCTION PRELIMINARY DETOUR ROUTES

www.walkbridgect.com www.walkbridgect.com

Environmental Permitting – What’s Included?

  • Stormwater Management
  • Contaminated Soil Management
  • Air Quality and Dust Control
  • Dredging (Dec/Jan)
  • Wetland mitigation
  • Enlisted Species Habitat Enhancements
  • Historic Resource Protection
  • Noise & Vibration Controls
  • In‐water Controls

www.walkbridgect.com

Environmental Restoration Areas

www.walkbridgect.com

Environmental Controls & Mitigation

Groundwater Treatment

Contaminated Soil Management

Turbidity Curtains Marine Enclosures

Habitat Enhancements

slide-4
SLIDE 4

11/27/2018 4

www.walkbridgect.com

Construction

CM/GC Delivery Method

www.walkbridgect.com

Program Construction Schedule

2018 2019 2020

Environmental Permitting

2023 2024

Danbury Branch Dockyard Project Construction

Walk Bridge Construction Fort Point St. /Osborne Ave./ East Ave./ E. Norwalk Station Construction CP243 Interlocking Project Construction

www.walkbridgect.com

Danbury Branch Dockyard Project

www.walkbridgect.com

Construction Activities

Ann Street

Bridge Construction & Intermittent Detours

Through March 2019 Danbury Branch

Open New Track & OCS Pole Installation

Dec/Jan

www.walkbridgect.com

CP243 Interlocking Project

www.walkbridgect.com

Construction Activities

Drilled Shafts & Signal House Installation Through February 2019 CP243 Track Work Rock & Slope Excavation Through Spring 2019

slide-5
SLIDE 5

11/27/2018 5

www.walkbridgect.com www.walkbridgect.com

Walk Bridge/Fort Pt. – Year 1 (Approx. 12-14mo)

www.walkbridgect.com www.walkbridgect.com

Walk Bridge/Fort Pt – Year 2 (Approx. 12-14mo)

Start New Fort Point Remove High Towers

www.walkbridgect.com www.walkbridgect.com

East Ave./Osborne Ave.– Year 2 (Approx. 12-14mo)

Remove & Construct South Halves

www.walkbridgect.com www.walkbridgect.com

Walk Bridge/Fort Pt – Year 3 (Approx. 12-14mo)

North Tracks Removed South Span Float‐in Open South Tracks

www.walkbridgect.com www.walkbridgect.com www.walkbridgect.com www.walkbridgect.com

Walk Bridge/Fort Pt – Year 4 (Approx. 12-14mo)

North Span Float‐in Complete North Half Fort Point

slide-6
SLIDE 6

11/27/2018 6

www.walkbridgect.com www.walkbridgect.com www.walkbridgect.com www.walkbridgect.com

East Ave./Osborne Ave.– Year 4 (Approx. 12-14mo)

Remove & Construct North Halves

www.walkbridgect.com www.walkbridgect.com

Walk Bridge/Fort Pt – Final Year

Open North Tracks

www.walkbridgect.com www.walkbridgect.com

East Ave./Osborne Ave.– Final Year

www.walkbridgect.com www.walkbridgect.com
