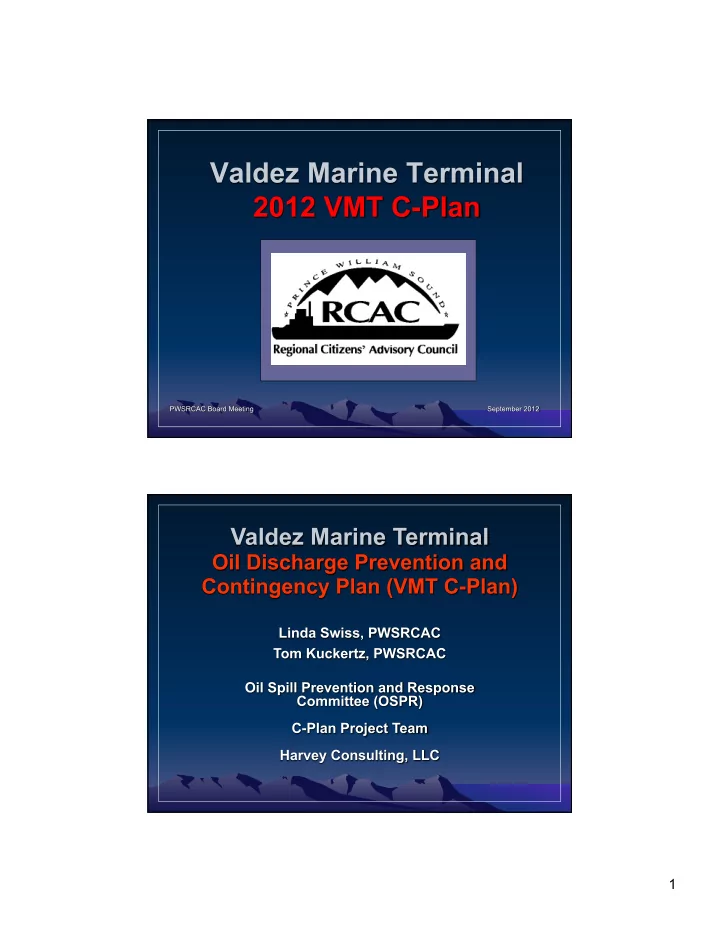

1 VMT C-Plan Renewal VMT Coordination Workgroup VMT C-Plan Changes Tank Inspections IWWS Update 2 VMT C-Plan expires May 2013. Renewal application to be submitted September 2012 for sufficiency review. Once plan is


slide-1
SLIDE 1

1

slide-2
SLIDE 2

2

  • VMT C-Plan Renewal
  • VMT Coordination Workgroup
  • VMT C-Plan Changes
  • Tank Inspections
  • IWWS Update
slide-3
SLIDE 3

3

 VMT C-Plan expires May 2013.  Renewal application to be submitted September 2012 for sufficiency review.  Once plan is found “sufficient for review,” public comment period begins.

slide-4
SLIDE 4

4

  • 1. Alyeska Pipeline Service Company
  • 2. Bureau of Land Management
  • 3. Alaska Department of Environmental

Conservation

  • 4. Environmental Protection Agency
  • 5. United States Coast Guard
  • 6. PWSRCAC
  • Coordinate development, modification and

implementation of the VMT C-Plan

  • Communicate on how C-Plan is implemented
  • Identify issues early on
  • Establish and maintain cooperative forum for

implementation and to address issues

  • Continuous C-Plan improvement
slide-5
SLIDE 5

5

Amendments from 2008-2012:

Routine Amendments:

  • Changes to Tankage Database Report

(tank inspection schedule changes)

  • Annual leak testing of buried pipes
  • Fishing Vessel Administrator Information
  • Did not re-write Scenario 5 – committed to

revise Plan to reference SERVS Technical Manual instead

slide-6
SLIDE 6

6

 Tank Inspections (ongoing)  Part 2, Prevention Review (2010)  Catalytically Blown Asphalt Liner Study (2012)  Status of Contaminated Sites (2012)  PWSRCAC’s Dr. Rust, Inc. Corrosion Report (2012)  August 23, 2012 – Letter to Alyeska with 24 Recommendations  August 31, 2012 – received DRAFT VMT C- Plan

slide-7
SLIDE 7

7

  • Response planning

standard

  • Personnel and Training
  • Organization Charts
  • Prevention
  • VMT Tactics Manual
  • Risk Assessment
  • Tank Inspection Intervals
  • Best Available

Technology

  • Secondary Containment

Integrity Verification

  • Facility Piping
  • Lessons Learned
  • Maps and Drawings

August 31, 2012 – received DRAFT VMT C-Plan September 2012 – C-Plan to be submitted for sufficiency review. October 2012 – ADEC determination of sufficiency review. After sufficiency determination – Public review begins. Will involve Requests for Additional Information (RFAI). May 2013 – C-Plan renewed.

slide-8
SLIDE 8

8 13 11 9 7 5 3 1 14 12 10 8 6 4 2 17 15 18 16

Status of Tank Inspections

West Tank Farm East Tank Farm

17 15 18

Waiver Revoked Taken Out of Service Summer 2012

16 13

14

5

Tanks Inspected 2012 Returned to Service

9

slide-9
SLIDE 9

9

  • Alyeska reports “catch basins unable to hold water

above steel liner within the catch basin” – July 2008

  • ADEC issues Notice of Violation for “failure to

maintain secondary containment system at VMT” – July 2008

  • ADEC deadline for repair completion – October 31,

2012

  • Permanent repairs failed due to installation of

incorrect liner – August 2012

  • New liner materials are on order; delivery expected

in early October – September 2012

slide-10
SLIDE 10

10

Alyeska contractors are finishing the replacement of a manhole in the secondary containment Cell 7 (Tanks 13 and 14). Note that portions of the Hypalon liner have been exposed and are subject to repair when the work with this manhole is finished.

Informational Briefing Only.

No action requested at this time.
