Wheelabrator Parc Adfer Community Liaison Group Meeting 11 Julian - - PowerPoint PPT Presentation

wheelabrator parc adfer
SMART_READER_LITE
LIVE PREVIEW

Wheelabrator Parc Adfer Community Liaison Group Meeting 11 Julian - - PowerPoint PPT Presentation

Wheelabrator Parc Adfer Community Liaison Group Meeting 11 Julian Harrison, Chair of Community Liaison Group Apo Sarandidis, Senior Project Manager Phil Preece, Plant Manager 24 October 2018 CLG Meeting 11 Agenda 1. Welcome and introductions


slide-1
SLIDE 1

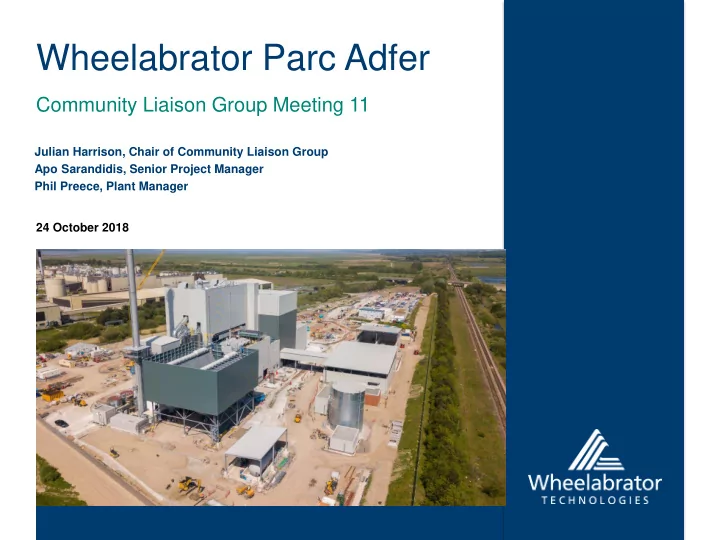

Wheelabrator Parc Adfer

Community Liaison Group Meeting 11

24 October 2018 Julian Harrison, Chair of Community Liaison Group Apo Sarandidis, Senior Project Manager Phil Preece, Plant Manager

slide-2
SLIDE 2

CLG Meeting 11

  • 1. Welcome and introductions (chair)
  • 2. Agreement of minutes and actions from the last meeting (chair, all)
  • 3. Project progress update (Wheelabrator technologies)
  • 4. Focus Topic – commissioning operations (Wheelabrator technologies)
  • 5. North Wales Residual Waste Treatment Project – progress update (Steffan

Owen, Regional Contracts Manager)

  • 6. Community Benefit Fund – progress update (Steffan Owen, Regional

Contracts Manager)

  • 7. Agreement of actions and date of next meeting
  • 8. A.O.B

2

Agenda

slide-3
SLIDE 3

Project Overview

  • Environmental Benefits
  • Process ~200K tonnes per year
  • Renewable energy to power 30,000 homes
  • Divert 98% of post-recycled waste from landfill
  • Recycle over 15% of authority waste through metals and aggregate

recovery, directly increasing North Wales recycling rates by 7%

  • Capacity to export heat or steam energy to nearby industrial, commercial or

residential users

  • Achieve the demanding R1 efficiency standard
  • Educational Facilities & Support (Visitors’ Centre)
  • For use by the Authority at their discretion and educational groups such as

schools, colleges & environmental interest groups

3

Environment & Education

slide-4
SLIDE 4

Project Overview

  • Target Economic Benefits
  • ~500 construction jobs at peak
  • 30+ full-time jobs once operational
  • £50,000 Community Benefit Fund during construction; £51.6K Allocated
  • £230,000 Community Benefit Fund annually once operational
  • Millions of pounds of positive economic impact, utilising local businesses

and suppliers during annual major and routine maintenance projects

  • £40 million supply chain value over contract term
  • Reduction in waste disposal costs & Welsh Government funding
  • Potential for local authority profit sharing

4

Economic Benefits

slide-5
SLIDE 5

Project Progress Update

slide-6
SLIDE 6

Project Progress

6

Health & Safety Performance

Over 1,000,000 construction hours completed without reportable incident

Working at height, lifting

  • perations, interfacing

(plant/people), confined spaces, excavations, electrical, commissioning Manual handling, eye injuries, cuts, abrasions, dropped objects, co-

  • rdination of activities,

knocks, bumps, slips & trips

1 16 67 HSE Observation Cards Influence Behaviour

By targeting Unsafe Acts & Conditions, whilst rewarding good practices

Mandatory Voluntary

High Risk Low Risk

slide-7
SLIDE 7

Project Update

7

Progress To Date

Month Month

35.5

Month

32

Progress to Date Expected 28/11/2019

99% Complete

slide-8
SLIDE 8

Project Update

8

First Year - 2017

October 2016 May 2017 September 2017 December 2017

slide-9
SLIDE 9

Project Update

9

Second Year - 2018

January 2018 April 2018 July 2018 October 2018

slide-10
SLIDE 10

Project Update

10

Third Year 2019

September 2019 July 2019 April 2019 September 2019

slide-11
SLIDE 11

Project Update

11

Key Project Achievements

  • Boiler hydrostatic (pressure) test

passed – 2nd Aug 2018

  • Bunker completed – 3rd Sep 2018
  • Mains electrical connection

energized – 23rd Sep 2018

  • Start of Cold Commissioning –

20th Nov 2018

  • Start of Hot Commissioning – 12th

Jun 2019

slide-12
SLIDE 12

Project Update

12

Key Project Achievements

  • Construction Completion Certificate –

21st Aug 2019

  • Readiness Test Certificate – 24th Aug

2019

  • First Waste Delivery – 27th Aug 2019
  • First Waste Fire – 3rd Sep 2019
slide-13
SLIDE 13

Project Update

13

Latest Drone Footage

slide-14
SLIDE 14

Focus Topic - Operations

slide-15
SLIDE 15

Operations

15

Staff

slide-16
SLIDE 16

Operations

16

Staff

63% of appointments are located within a 20 mile radius of Parc Adfer

22% live within the Flintshire Area

slide-17
SLIDE 17

Operations

17

First Waste Received – Tue 27th August 2019

slide-18
SLIDE 18

Operations

18

First Fire – 11am Tue 3rd September 2019

slide-19
SLIDE 19

Operations

19

Priorities & Key Facts

Safety & Environmental compliance remain of the highest priority! There have been no accidents or environmental release incidents Now some key Operational facts & figures . . .

slide-20
SLIDE 20

Operations

20

Key Facts & Figures

  • Vehicles movements:
  • 749 Heavy Goods Vehicles in Sept (less than 30 per day)
  • Planning estimated a worst case of 67 HGV vehicles per day
  • Waste characteristics:
  • Authority waste inputs – 8,080 tonnes
  • Commercial waste inputs – 5,996 tonnes
  • Composition and calorific value (‘CV’) close to optimal
  • Air Pollution Control Residues – 277 tonnes removed
  • Incinerator Bottom Ash – none removed in Sept during sampling & testing
  • Boiler performance:
  • 14,170t of waste = 50,870t of steam production (410°C, 61bar/900psi
  • 32,960MWth of recovered energy
slide-21
SLIDE 21

Operations

21

Key Facts & Figures

  • Emissions to Air:
  • All CEMS readings within commissioning limits and monthly average for

IED compliance . . . more on this later

  • IBA sampling & testing:
  • IBA removal commenced for processing into aggregate by offtaker
  • Commenced using ESA protocol – 12 (of 24) samples taken so far of

which 10 results (all passes) have been received . . . more on this later

  • Flue Gas Treatment (FGT) APCr removal to offtaker commenced –

recycling trials also commenced

  • Rainwater run-off and capture released from attenuation pond after

sampling and checking

  • NRW (EA) has approved R1 status by design
slide-22
SLIDE 22

Operations

22

IBA – Bottom Ash (Non-Hazardous material)

  • IBA ≡ c.25% of waste tonnes (3,542t in Sept = c.50,000t/pa)
  • Metals are separated & recycled
  • Remaining ash is graded & used as aggregate in road building
slide-23
SLIDE 23

Operations

23

Continuous Emissions Monitoring (‘CEMS’)

50 16 1.3 20 1.9 50 38 10 20 30 40 50 60 70 80 90 100

Sept 2019 Emissions to Air

(as % of Daily ELV)

HCl CO Particulate NH3 T.O.C. NOx SO2
