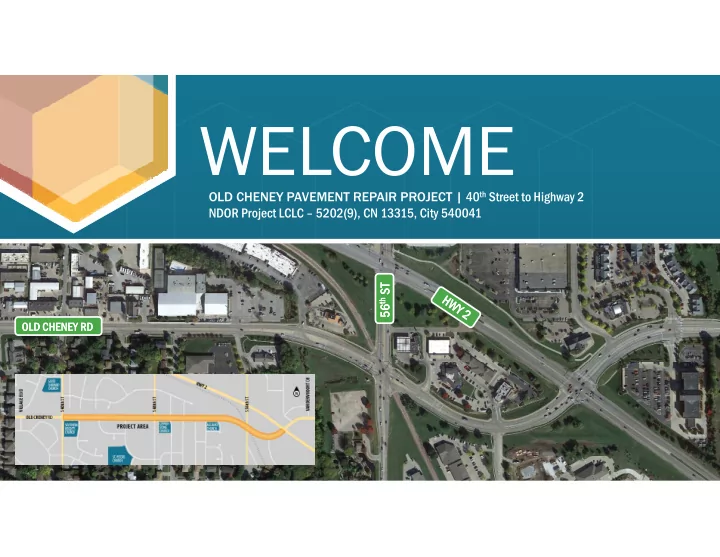

WELCOME OLD CHENEY PAVEMENT REPAIR PROJECT | 40 th Street to Highway 2 NDOR Project LCLC 5202(9), CN 13315, City 540041 56 th ST 56 th ST OLD CHENEY RD OLD CHENEY RD OJECT | 40 th Street to Highway 2 OLD OLD CHEN CHENEY P EY PAVEMEN


slide-1
SLIDE 1

WELCOME

OLD OLD CHEN CHENEY P EY PAVEMEN VEMENT REP REPAIR PR IR PROJECT OJECT | 40th Street to Highway 2 NDOR Project LCLC – 5202(9), CN 13315, City 540041

OLD CHENEY RD OLD CHENEY RD

56th ST 56th ST OLD CHENEY PAVEMENT REPAIR PROJECT | 40th Street to Highway 2 NDOR Project LCLC – 5202(9), CN 13315, City 540041

slide-2
SLIDE 2

PHASING/TRAFFIC CONTROL

  • Maintain Traffic

(1 lane in each direction) with Lane Closures

  • Head to Head Traffic
  • Total Closure with Detour

TYPE OF CONCRETE

  • 47B Standard Concrete

(7 Day Cure Time)

  • 47B-HE High Early Strength

(2-3 Day Cure Time)

  • PR3 Pavement Repair

(6 Hour Cure Time)

CONSTRUCTION CONSIDERATIONS

DAILY CONSTRUCTION

  • Standard
  • Nighttime Only
  • 24 Hour

OLD CHENEY PAVEMENT REPAIR PROJECT | 40th Street to Highway 2 NDOR Project LCLC – 5202(9), CN 13315, City 540041

slide-3
SLIDE 3

ALTERNATIVES CONSIDERED

Scope of Work / Type of Concrete Traffic Control / Access Minimum Safety Standards Daily Construction Estimated Duration (days) Minimum Quality Standards Cost Relative to Preferred 1 Repair w/ 47B Full Intersection Closure Exceeds Standard 24 Yes 93% 2 Repair w/47B-HE Full Intersection Closure Exceeds Standard 14 Yes 100% 3 Repair w/ PR3 Full Intersection Closure Meets Night Time Only 14 No 164% 4 Repair w/ 47B-HE Lane Closure Only Meets Standard 28 Yes 137% 5 Repair w/ PR3 Lane Closure Only Meets Night Time Only 24 No 218% 6 Full Reconstruction w/ 47B Full Intersection Closure Exceeds Standard 28 Yes 154% 7 Full Reconstruction w/ 47B-HE Full Intersection Closure Exceeds Standard 14 Yes 164%

OLD CHENEY PAVEMENT REPAIR PROJECT | 40th Street to Highway 2 NDOR Project LCLC – 5202(9), CN 13315, City 540041

Preferred Not Viable

slide-4
SLIDE 4

Preferred Alternative

N

slide-5
SLIDE 5

Proposed Detour Map

slide-6
SLIDE 6

COMMITMENTS TO MINIMIZE IMPACTS

  • Maintain Bicycle and Pedestrian Traffic
  • Maintain at Least One Access Point to All Businesses
  • Provide Temporary Median Breaks on 56th Street
  • Include Contractor Incentive/Disincentive Compensation
  • Allow 24 Hour Construction (if requested by contractor)

OLD CHENEY PAVEMENT REPAIR PROJECT | 40th Street to Highway 2 NDOR Project LCLC – 5202(9), CN 13315, City 540041

slide-7
SLIDE 7

For more information: http://lincoln.ne.gov/city/pworks/engine/dconst/copecnst

Ac Access ss D Duri ring C ng Cons nstruction truction Clos Closur ures an and d De Detours Utilities ities Access ccess Af After C r Cons nstruction truction Ne New En Envir vironm nmen ent Glo Glossar sary of

  • f Usef

Useful ul Terms rms Freq eque uently Ask Asked d Questi Questions Do Down wnload ad PDF Br PDF Broch

  • chure

re Te Temporary G Guide Signs Tips and Tips and Ideas Ideas Advice and vice and Ex Expe perience rience OLD CHENEY PAVEMENT REPAIR PROJECT | 40th Street to Highway 2 NDOR Project LCLC – 5202(9), CN 13315, City 540041

COPING WITH CONSTRUCTION

slide-8
SLIDE 8

THANKS FOR ATTENDING!

ERIKA NUNES Pr Project Engineer

  • ject Engineer

City of Lincoln Engineering Services 949 W Bond Street, Suite 200 Lincoln, NE 68521 402-326-1037 enunes@lincoln.ne.gov STEPHANIE RITTERSHAUS Public In Public Involv lvement Coor ement Coordinat dinator

  • r

Alfred Benesch & Company 825 "M" Street, Suite 100 Lincoln, NE 68508 402-479-2200 srittershaus@benesch.com

OLD CHENEY PAVEMENT REPAIR PROJECT | 40th Street to Highway 2 NDOR Project LCLC – 5202(9), CN 13315, City 540041
