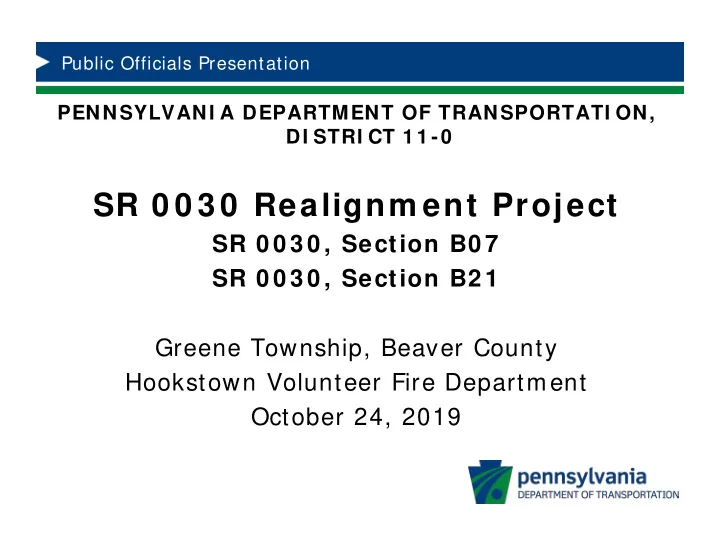

Public Officials Presentation PENNSYLVANI A DEPARTMENT OF TRANSPORTATI ON, DI STRI CT 1 1 -0 SR 0 0 3 0 Realignm ent Project SR 0 0 3 0 , Section B0 7 SR 0 0 3 0 , Section B2 1 Greene Township, Beaver County Hookstown Volunteer Fire
Opening Remarks
Project Team
PennDOT District 11
- Cheryl Moon-Sirianni, P.E.
- Doug Seeley, P.E.
- Victor DeFazio, P.E.
- Robert Collins, P.E.
- Jacqueline Evans, P.E.
- Robert Slagel, P.E.
- Mark Young
- Nick Krobot, P.E.
SAI Consulting Engineers, Inc.
- William Siess, P.E.
- Arnold Harker, P.E.
Skelly & Loy Inc.
- Mike Zizan, P.E.
- John Gustkey
A.G.E.S. Inc.
- Sebastian Lobo-Guerreo, P.E.
Agenda
- Opening Remarks
- Project Team
- Project Scope of Work
– Section B07 Realignment Portion – Section B21 Repaving and Safety I mprovement Portion
- Phases of Construction and Associated Traffic Impacts.
– Phase 1 – Offline Embankment Construction – Phase 2 – Red Dog Road I ntersection Realignment and Construction – Phase 3 – SR 0030/ Red Dog Road Reconstruction – Phase 4A/ 4B – Completion of Realignment Section and Slide Repairs – Phase 5 – Embankment Repair at WV border and safety improvements from WV border to SR 0168.
- Anticipated Construction Schedule
- Questions and Answer Period
Project Scope of Work – Section B07
Project Scope of Work – Section B21
Phases of Construction and Traffic Impacts
Phases of Construction and Traffic Impacts
Red Dog Road Detour
Phases of Construction and Traffic Impacts
SR 0030 Detour
Phases of Construction and Traffic Impacts
Phases of Construction and Traffic Impacts
Phases of Construction and Traffic Impacts
- Phase 5
Anticipated Construction Schedule
- Bidding/ Award Process. Fall 2019 to Spring 2020
- Phase 1 Construction: Spring 2020 to Summer 2020
- Phase 2 Construction: Fall 2020 to Winter 2021
- Phase 3 Construction: Spring 2021 to Summer 2021
- Phase 4A/ 4B Construction: Summer 2021 to Fall 2021
- Phase 5 Construction: Fall 2021 to end of 2021
