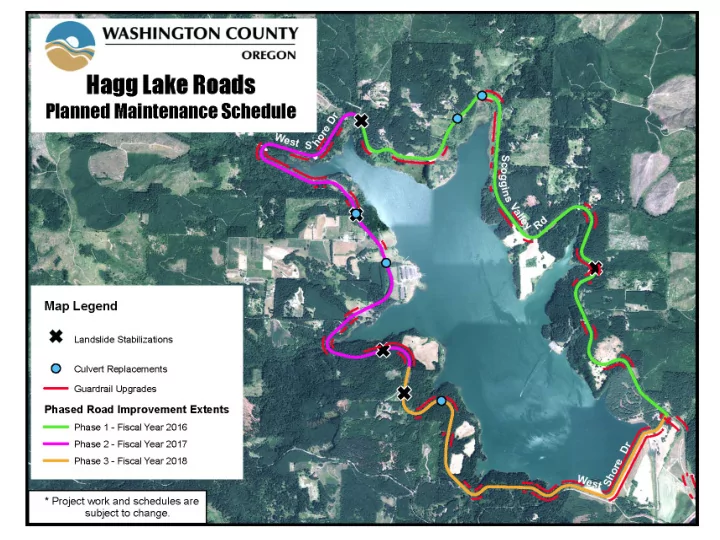

Phase 1 Scoggins Valley Road Estimated Budget Design/ Planned - - PowerPoint PPT Presentation
Phase 1 Scoggins Valley Road Estimated Budget Design/ Planned - - PowerPoint PPT Presentation
Phase 1 Scoggins Valley Road Estimated Budget Design/ Planned Activity Engineering Construction Status Construction Culvert Replacements $100,000 $260,000 Complete Fall 2015 Landslide Stabilization MP 4.6 Deep Patch $192,000
Phase 1 – Scoggins Valley Road
Activity Estimated Budget Status Planned Construction Design/ Engineering Construction
Culvert Replacements $100,000 $260,000 Complete Fall 2015 Landslide Stabilization MP 4.6 Deep Patch $192,000 $490,000 Design Winter/Spring 2016 MP 7.6 Deep Patch or Tieback Wall Postponed Fall 2017 Stepien Intersection Drainage Improvements $30,000 $185,000 Design Winter/Spring 2016 Guardrail Upgrade and Asphalt Overlay $165,000 $1,872,000 Design Spring 2016 Total $487,000 $2,807,000 $3,294,000
Culvert 2014
Culvert 1793
Phase 2 – West Shore Drive
Activity Estimated Budget Status Planned Construction Design/ Engineering Construction
Culvert Replacements – MP 9.2 and MP 9.6 $37,500 $200,000 Planning Fall 2016 Landslide Stabilizations Hankins Slide MP 11.04 $195,000 $660,000 Planning Fall 2016 MP 9.2 or MP 10.6 $195,000 $600,000 to $1,500,000 Planning Fall 2016 Guardrail Upgrade and Asphalt Overlay $50,000 $1,251,500 Design Spring 2017 Total $477,500 $2,711,500 to $3,611,500 $3,189,000 to $4,089,000
Hankins Slide
Phase 3 – West Shore Drive
Activity Estimated Budget Status Planned Construction Design/ Engineering Construction
Culvert Replacements – MP 11.1 $16,500 $125,000 Planning Fall 2017 Landslide Stabilizations Scoggins Valley MP 7.6 $230,000 $150,000 to $3,000,000 Planning Fall 2016 West Shore MP 9.2 or MP 10.6 $195,000 $600,000 to $1,500,000 Planning Fall 2016 Guardrail Upgrade and Asphalt Overlay $50,000 $1,104,500 Design Spring 2017 Total $491,500 $1,979,500 to $5,729,500 $2,471,000 to $6,221,000
