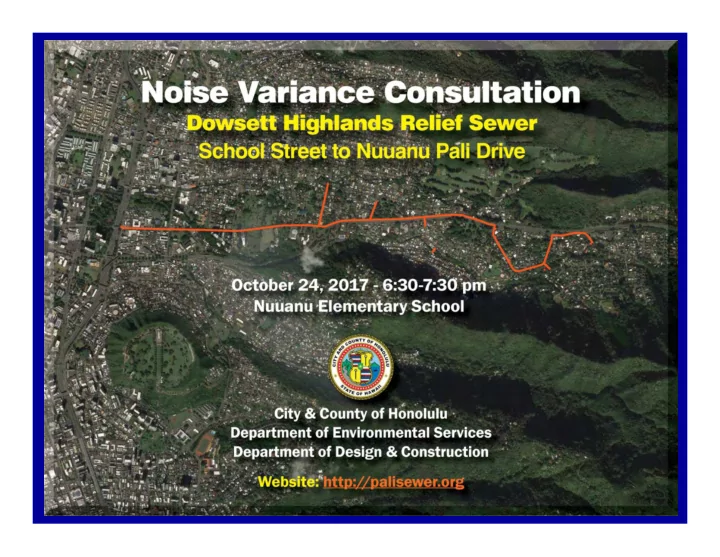

pali highway improvement projects pali highway
play

Pali Highway Improvement Projects Pali Highway Improvements Projects - PowerPoint PPT Presentation

Pali Highway Improvement Projects Pali Highway Improvements Projects Proposed Construction Schedules 2018 2017 2019 2020 2021 Pali Hwy Imprv SUMMER 2019 Phase 1 Dowsett Highlands SPRING 2020 Relief Sewers Pali Hwy Imprv


  1. Pali Highway Improvement Projects

  2. Pali Highway Improvements Projects Proposed Construction Schedules 2018 2017 2019 2020 2021 Pali Hwy Imprv – SUMMER 2019 Phase 1 Dowsett Highlands SPRING 2020 Relief Sewers Pali Hwy Imprv – WINTER 2020 Phase 2

  3. NOISE VARIANCE CONSULTATION PROJECT SCOPE OF WORK NUUANU AVENUE • Installation of relief sewer along Nuuanu Avenue from School Street to Wyllie Interchange. • Open cut excavation which includes trenching, excavation and backfill, paving, new sewer line and manholes, traffic controls, and pavement markings shall be utilized along Nuuanu Avenue from School Street to Wyllie Interchange.

  4. NOISE VARIANCE CONSULTATION PROJECT SCOPE OF WORK PALI HIGHWAY • Installation of relief sewer along Pali Highway from Wyllie Interchange to Nuuanu Pali Drive. • Utilization of Guided Boring Method (GBM) for installation of relief sewers within Pali Highway where feasible. GBM is a trenchless installation method however still requires excavated 10’ diameter pits strategically situated at new sewer manhole locations for the tunneling / jacking machine. • Contractor shall also be installing sewers within Pali Highway via open-cut excavation where required.

  5. Pali Highway Improvements Traffic Control between Country Club Road and Nuuanu Avenue – Honolulu Bound

  6. Proposed Relief Sewer Line stream EXISTING CONDITION existing sewer Highway Pali existing sewer stream

  7. Proposed Relief Sewer Line PROPOSED CONDITION Pali Highway stream stream existing existing new sewer sewer sewer

  8. Proposed Relief Sewer Line PROPOSED CONDITION Pali Highway stream stream existing existing new sewer sewer sewer

  9. Tunnel Boring & Pipe Jacking Guided Boring Method Pilot Tube Drilling Access Shaft

  10. Backfilling Trench Open Cut Excavation Pipe Laying Trench Excavation

  11. Pali Highway Construction Proposed Work Coordination Current Conditions shoulder paved side travel lane travel lane travel lane median shoulder walk FALL 2017

  12. Pali Highway Construction Proposed Work Coordination Pali Highway Improvements – Phase 1 – Shoulder Widening widened shoulder paved side travel lane travel lane travel lane median shoulder walk SPRING 2018

  13. Pali Highway Construction Proposed Work Coordination Pali Highway Improvements – Phase 1 – Lighting new highway paved shoulder work zone light barricade side paved 10’ travel 10’ travel 10’ travel median walk shoulder lane lane lane temporary new lane markings electrical reconstruct sidewalk line SUMMER 2018

  14. Pali Highway Construction Proposed Work Coordination Dowsett Highlands Relief Sewer new highway paved shoulder work zone light barricade side paved 10’ travel 10’ travel 10’ travel median walk shoulder lane lane lane temporary new lane markings electrical line new sewer line SPRING 2019

  15. Pali Highway Construction Proposed Work Coordination Dowsett Highlands Relief Sewer new highway paved shoulder work zone light side paved 10’ travel 10’ travel 10’ travel median walk shoulder lane lane lane temporary new lane markings reconstruct pavement electrical line new sewer line WINTER 2019

  16. Pali Highway Construction Proposed Work Coordination Pali Highway Improvements – Phase 2 – Repaving new highway paved shoulder Provide finished surface layer light widened side 11’ travel 11’ travel 11’ travel median paved walk lane lane lane shoulder permanent lane markings new electrical reconstruct pavement line new sewer line SUMMER 2020

  17. Pali Highway Construction Proposed Work Coordination All Projects Completed New Sewer, Lighting, Pavement & Markings new highway paved shoulder light widened side 11’ travel 11’ travel 11’ travel median paved walk lane lane lane shoulder permanent lane markings new electrical line new sewer line WINTER 2020

  18. NOISE VARIANCE CONSULTATION Noise Regulations • HAR Title 11, Chapter 46 sets the rules and restrictions on sound levels for construction projects. It states : “No permit shall allow any construction activities which emit noise: • Monday thru Friday before 7 a.m. and after 6 p.m. of the same day • Saturday before 9 a.m. and after 6 p.m. • Sundays and on Holidays” • A Noise Variance must be obtained for any construction activities to occur outside the permissible hours (i.e. after 6 p.m. weekdays).

  19. NOISE VARIANCE CONSULTATION • Noise Meeting was initially held July 26, 2017. Comments were received and revisions to the Noise Variance App have been incorporated. • Requesting work be allowed 24 hours, 7 days a week during project schedule of June 2018 to June 2020. • Night work enables project to meet Consent Decree deadline. • Night work will increase safety to both motorists and pedestrians in the construction area to minimize the interaction between construction equipment and passenger vehicles.

  20. NOISE VARIANCE CONSULTATION Pali Hwy Dowsett Ave to DAYTIME WORK Jack Lane End Project Limit Nuuanu Pali Dr DAYTIME WORK Dowsett Ave DAYTIME Wyllie Street WORK DAYTIME WORK Pali Hwy Phase Wyllie St to Dowsett Ave Nuuanu Ave Phase School St to Wyllie St Begin Project Limit Nuuanu Ave/School St

  21. NOISE VARIANCE CONSULTATION SOUND PROPAGATION • Sound propagates uniformly outward in a spherical pattern and decreases with distance and shielding. • As sound propagates over a distance, it changes in level and frequency. The sound level attenuates (or decreases) at a rate of 6 dB for each doubling of distance from the point source. • As sound propagates over terrain with large objects or barriers in the path between a source and a receiver, the sound level can decrease at least 5 dB.

  22. NOISE VARIANCE CONSULTATION CONSTRUCTION EQUIPMENT SOUND LEVEL This table illustrates sound levels of typical construction equipment anticipated to be used during construction. Most of the equipment generates sound at a levels in the mid 80s at a distance of 50 feet however the distance is typically greater which reduces the sound level.

  23. NUUANU AVE (SCHOOL ST TO WYLLIE ST) ORIGINAL NOISE VARIANCE APP NIGHTWORK LIMITS

  24. NUUANU AVE (SCHOOL ST TO WYLLIE ST) 50’ DISTANCE FROM CONSTRUCTION (~85 dB outdoor) (~80 dB indoor – garbage disposal)

  25. NUUANU AVE (SCHOOL ST TO WYLLIE ST) 100’ DISTANCE FROM CONSTRUCTION (~79 dB outdoor) (~74 dB indoor – toilet, vacuum)

  26. NUUANU AVE (SCHOOL ST TO WYLLIE ST) 200’ DISTANCE FROM CONSTRUCTION (~73 dB outdoor) (~68 dB indoor–shower, dishwasher)

  27. NUUANU AVE (SCHOOL ST TO WYLLIE ST) 400’ DISTANCE FROM CONSTRUCTION (~67 dB outdoor) (~62 dB indoor– AC, conversation)

  28. NUUANU AVE (SCHOOL ST TO WYLLIE ST) 800’ DISTANCE FROM CONSTRUCTION (~61 dB outdoor) (~56 dB indoor – refrigerator)

  29. PALI HWY (WYLLIE TO NUUANU PALI DRIVE) ORIGINAL NOISE VARIANCE APP NIGHTWORK LIMITS

  30. PALI HWY (WYLLIE TO NUUANU PALI DRIVE) 50’ DISTANCE FROM CONSTRUCTION (~85 dB outdoor) (~80 dB indoor – garbage disposal)

  31. PALI HWY (WYLLIE TO NUUANU PALI DRIVE) 100’ DISTANCE FROM CONSTRUCTION (~79 dB outdoor) (~74 dB indoor – toilet, vacuum)

  32. PALI HWY (WYLLIE TO NUUANU PALI DRIVE) 200’ DISTANCE FROM CONSTRUCTION (~73 dB outdoor) (~68 dB indoor–shower, dishwasher)

  33. PALI HWY (WYLLIE TO NUUANU PALI DRIVE) 400’ DISTANCE FROM CONSTRUCTION (~67 dB outdoor) (~62 dB indoor– AC, conversation)

  34. PALI HWY (WYLLIE TO NUUANU PALI DRIVE) 800’ DISTANCE FROM CONSTRUCTION (~61 dB outdoor) (~56 dB indoor – refrigerator)

  35. NOISE VARIANCE CONSULTATION • Out to bid in early 2018 • Once a Contractor has been awarded the project, coordination will begin to establish a viable construction schedule which minimizes impact to the public. • Contractor shall notify residents of construction in their neighborhood with at least one week advance notice. Website will be used to update the public on project status and activities. Website: www.palisewer.org

  36. NOISE VARIANCE CONSULTATION NOISE ABATEMENT • Limit excavation work at night along the project areas. • The louder construction equipment which includes hoe rams, jackhammers, and walk behind saw shall be limited to be used no later than 10:00 PM. • Guided Boring Method work continuing uninterrupted from day operations into the night hours optimizes construction progress. GBM equipment such as the Horizontal Boring Hydraulic Jack Machine will be located at bottom of ~20’ deep excavated pit which provides a solid barrier all around and reduces the sound level at least an additional 5dB.

  37. NOISE VARIANCE CONSULTATION NOISE ABATEMENT Noise Abatement measures include the following: • Contractor will be required to maintain all equipment in good working order. • All equipment with an exhaust of gas or air will have mufflers. • City personnel and Contractor will monitor all equipment and construction activities to ensure utilization of noise abatement measures. • Instructional training sessions for construction crews and truck drivers to discuss proper noise abatement procedures for use of engine brakes, loading and unloading cargo, shouting, use of signal callers, and best management practices to reduce sound.

Download Presentation
Download Policy: The content available on the website is offered to you 'AS IS' for your personal information and use only. It cannot be commercialized, licensed, or distributed on other websites without prior consent from the author. To download a presentation, simply click this link. If you encounter any difficulties during the download process, it's possible that the publisher has removed the file from their server.
