MEASURE L BOND UPDATE April 10, 2018 Measure L Overview Phase 2 - - PowerPoint PPT Presentation

measure l bond update
SMART_READER_LITE
LIVE PREVIEW

MEASURE L BOND UPDATE April 10, 2018 Measure L Overview Phase 2 - - PowerPoint PPT Presentation

Majestic Way MEASURE L BOND UPDATE April 10, 2018 Measure L Overview Phase 2 Project Update Phase 3 Project Update Phase 4 Project Update FIS and Classroom Furniture Update Program Schedule Review Measure L Phase 2


slide-1
SLIDE 1

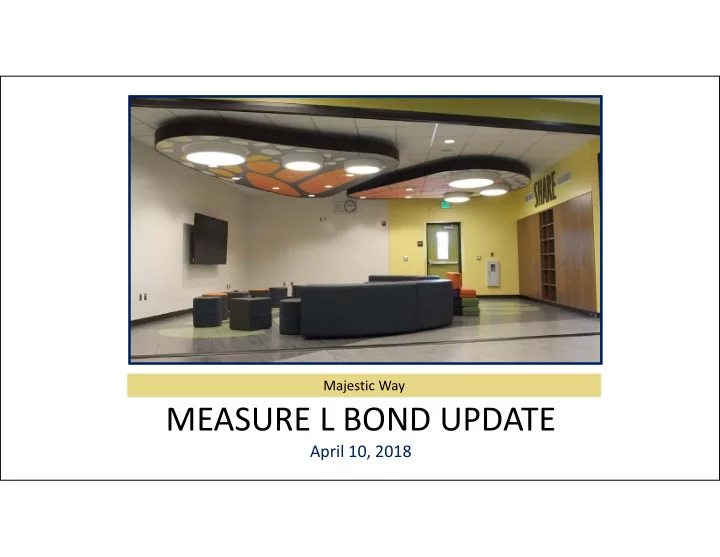

Majestic Way

MEASURE L BOND UPDATE

April 10, 2018

slide-2
SLIDE 2
  • Phase 2 Project Update
  • Phase 3 Project Update
  • Phase 4 Project Update
  • FIS and Classroom Furniture Update
  • Program Schedule Review

Measure L – Overview

slide-3
SLIDE 3
  • Vinci Park Elementary School ‐ FIS
  • Phase 1 – Interior Work
  • Anticipated completion by April 16, 2018
  • Phase 2 – Exterior Work
  • Awaiting pricing for site work (Concrete, fencing, plumbing and electrical.
  • Pavement Rehabilitation – Piedmont Middle School
  • Receive bids April 5, 2018
  • Construction starts June 2018

Measure L – Phase 2 Projects

slide-4
SLIDE 4

Majestic Way FIS Project

Main FIS Space

Measure L – Phase 3 Projects

slide-5
SLIDE 5

Majestic Way FIS Project

Main FIS Space

Measure L – Phase 3 Projects

slide-6
SLIDE 6

Majestic Way FIS Project

Wet Area

Measure L – Phase 3 Projects

slide-7
SLIDE 7
  • FIS Furniture ‐ Vinci Park
  • Awaiting final quote from vendor
  • Furniture delivery May 2018
  • FIS Furniture ‐ Laneview & Majestic Way
  • Awaiting delivery of miscellaneous chairs for each
  • Furniture ‐ 2018 Project
  • Meeting with Principal in May 2018
  • Classroom Furniture ‐ 2018 Projects
  • Awaiting final quote from vendor

Measure L – Furniture

slide-8
SLIDE 8
  • Ruskin Elementary School ‐ FIS
  • No bids were received/Negotiating with Contractor
  • Piedmont Middle School ‐ FIS
  • No bids were received/Negotiating with Contractor
  • Brooktree Elementary School
  • FIS/Modernization Package
  • Receive bids in March 29, 2018, received 2 bids
  • Recommendation of award at the May 8, 2018 meeting
  • Start construction June 2018
  • Flooring Package
  • Start construction June 2018

Measure L – Phase 4 Projects

slide-9
SLIDE 9
  • Cherrywood Elementary School
  • Interior Painting Package
  • Receive bids March 28, 2018, received 13 bids
  • Recommendation of award at the May 8, 2018 meeting
  • Start construction June 2018
  • Flooring Package
  • Start construction June 2018
  • FIS/Modernization Package
  • Awaiting structural comments from DSA
  • Start construction Fall 2018
  • Toyon Elementary School
  • Interior/Exterior Painting Package
  • Receive bids March 28, 2018, received 13 bids
  • Recommendation of award at the May 8, 2018 meeting
  • Start construction June 2018
  • Flooring Package
  • Start construction June 2018
  • FIS/Modernization Package
  • Submit to DSA early May 2018
  • Construction to begin in Fall of 2018

Measure L – Phase 4 Projects

slide-10
SLIDE 10
  • Morrill Middle School
  • Flooring Package
  • Start construction June 2018
  • FIS/Modernization Package
  • Receive bids on April 3, 2018
  • Recommendation of award at the May 8, 2018 meeting

Measure L – Phase 4 Projects

slide-11
SLIDE 11

Measure L – Program Schedule

Design Preconstruction Furniture Order Finalized Furniture Ordered DSA Review Construction Quote Pricing Lead Time Bid Start of School PO Generated Furniture Received and Placed Award Punch List

Construction Projects

1 2 3 4 1 2 3 4 5 1 2 3 4 1 2 3 4 1 2 3 4 1 2 3 4 1 2 3 4 5 1 2 3 4 1 2 3 4 1 2 3 4 5 1 2 3 4 Vinci Pa rk FI S interior FI S Exterior La ne v ie w FI S Ma j e stic W a y FI S Rusk in FI S Pie dm ont FI S Parking I m provem ents Br ook tr e e Flooring Modernization FI S Che r r y wood I nterior Painting Flooring FI S/ Modernization Toy on I nterior/ Exterior Painting Flooring FI S/ Modernization Mor r ill Flooring Modernization FI S Week Week Week Week Week

2018 Construction & Furniture Projects

Week Week Week Week Week Week January February July August September October November December April May June Construction Legend Furniture Legend

slide-12
SLIDE 12

Thank You
