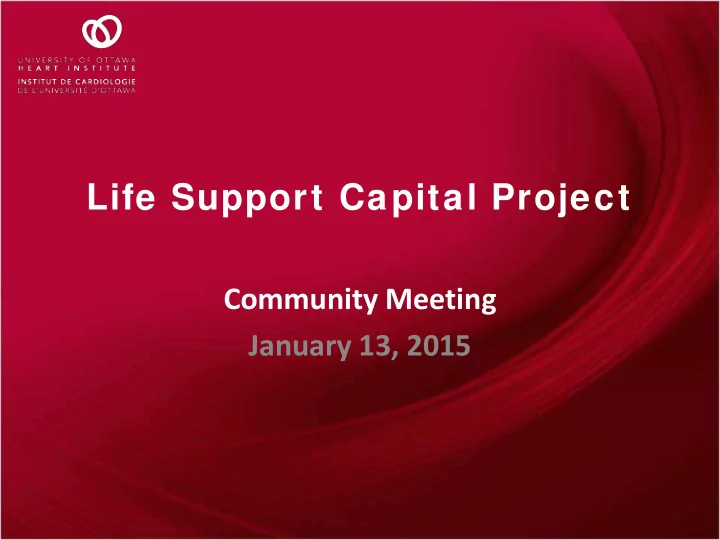

Life Support Capital Project Community Meeting January 13, 2015 Agenda for tonight A brief trip down memory lane The Project Overview The why of the project The where of the project The what of the project The when of the


slide-1
SLIDE 1

Life Support Capital Project

Community Meeting January 13, 2015

slide-2
SLIDE 2

Agenda for tonight

  • A brief trip down memory lane
  • The Project Overview

– The why of the project – The where of the project – The what of the project – The when of the project

slide-3
SLIDE 3
slide-4
SLIDE 4
slide-5
SLIDE 5

PHASE 3 – Research Wing – 1987-89

slide-6
SLIDE 6

6

CIVIC CAMPUS

UOHI

Nov 12, 2013 presented by the University of Ottawa Heart Institute

slide-7
SLIDE 7

So why are we expanding

  • Population over AGE 50 in this region will

grow by 66% BY 2031

  • No room to grow in existing footprint
  • Existing facility was built in 1974 and is

undersized and inadequate for today’s standards

slide-8
SLIDE 8

So why are we expanding

  • Many new procedures
  • Many new Programs created – like STEMI
  • Many advances in technology (CT and MRI to

name two)

  • Planning for this expansion started in 2005
slide-9
SLIDE 9

So why here?

  • Need to be efficient – not duplicating what is

already provided on site

  • If move to an entirely new site then would

cost way more

  • In 2005 plans to move the Campus not

developed

  • Dec 2014 -Ag Canada land announcement –

will still take ‘til 2025-30 to start construction

slide-10
SLIDE 10

So what is being planned?

  • 146,000 sq ft addition (4 floors + penthouse)

– Will house cardiac procedures rooms

  • Surgical suites, cath labs and electrophysiology labs
  • 27 ICU beds for cardiac surgery patients
  • 60,000 sq ft renovations (existing building)

– Renovate S level once the procedure rooms to new addition and once completed, consolidate cardiac imaging in this level

slide-11
SLIDE 11

Site Plan WITH NEW ADDITION

11

EXISTING UOHI ADDITION MELROSE STREET RUSKIN STREET

Please note that these drawings are schematic only and might not reflect final drawings.

slide-12
SLIDE 12

12

Location of New Extension

slide-13
SLIDE 13

NEW INSTITUTE FRONT ENTRANCE

slide-14
SLIDE 14

How does it work?

  • Project is managed by Infrastructure Ontario
  • Project constructors are PCL
  • Complex site with significant issues and

phasing

  • TOH/UOHI still have to operate throughout
  • Strict time line and hard deadlines
slide-15
SLIDE 15

RFP (tender) for contractors

2013 2014 2015 2016 2017 2018 2019 2020

PROJECT START Relocation of Loading docks & Melrose Ambulance Entrance START on new building

New Building Completed (2 years)

S-Level start renovations

Project Phases

Level-1 start renovations

Project Complete (5 ½ years)

slide-16
SLIDE 16

SITE PLAN

Please note that these drawings are schematic only and might not reflect final drawings.

slide-17
SLIDE 17

SITE PLAN

Please note that these drawings are schematic only and might not reflect final drawings.

slide-18
SLIDE 18

Some things to note

  • Web site for information and email address for

issues

  • Will be contacting immediately adjacent

neighbors (see map attached) for vibration consultants

  • Regular updates will be provided to the

Community Association

slide-19
SLIDE 19

Pre-Construction Condition Survey

Survey usually for structures within the 65 m radius No residential properties within this zone; consultant recommended to survey at the 100m radius – 9 properties
