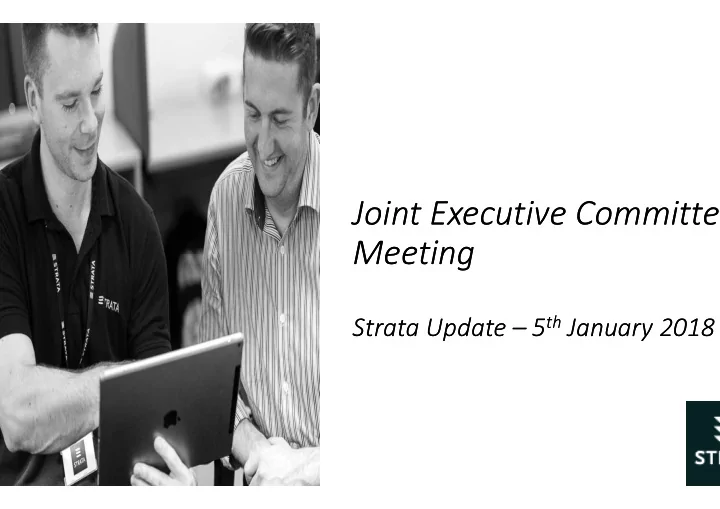

J M
S
Joint Executive Committee Joint Executive Committee Meeting Meeting Meeting Meeting
Strata Update Strata Update – – 5 5th
th January 2018
J Joint Executive Committee Joint Executive Committee M Meeting - - PowerPoint PPT Presentation
J Joint Executive Committee Joint Executive Committee M Meeting Meeting Meeting Meeting th January 2018 5 th S Strata Update Strata Update 5 January 2018 Strata Board Chairmans Updat te Business Plan 2018 / 2019
th January 2018
achievable through introduction of 3rd line supp unfilled
discuss, agree and monitor Strata priorities mov
f savings, target of £382k savings for 2018 / 2019 – port and leaving two Business Analyst posts 19 as costs now far better understood at’s the right focus for the authorities uthority and a Joint IT Steering committee to ving forward he Strata service catalogue
“Move has been completed quickly and ef (apprentice) and Sam (work experience)…t Thank you very much.”
Dana Kurtovic – Homelessness Officer
fficiently… praise to two wonderful young man, Val …they were brilliant…
tipping in development TDC One Teignbridge progressing well
rget completion early Jan 2018 ed in conjunction with ECC, Garden Waste renewals, Bulky waste and uy in to Strata ieved ross Strata across service teams ata focus to ‘get it right first time’ really well
as previous changes settle in and performance improves
being proposed in Bronze, Silver and Gold Plan
will only investigate this issue further if we take out a Premier Support contract and this is very expensive !
Global Desktop
across all three authorities.
taking place
Compliance and Security
successfully gone live with SFB and Anywhere365.
schedule for the new telephony platform
Global Comms
there’s a proactive engagement with each authority to prioritise work.
each authority to prioritise project work
BCR’s and Project Work
“Thank you for your help with recent issues. Th Thank you Lorraine Mitchell”
he out of hours service is of great use.
identifying IT issues and potentially resolv working day is of key importance – since w Nov, any issues identified overnight have the authorities
call and obtain a response and fix is valued
ment and users work patterns changing, lving them before the start of the standard e we introduced the trial OOH service on 6th e been resolved without impact to any of e weekends, so the ability to log a support lued escalation to Strata management
alls Logged by authority ECC 7 EDDC 3 TDC 11 (8 calls for leisure centres)
53% 14% 33% TDC EDDC ECC
There are two elements to the OOH charging mode
Authority Percentage T EDDC 36.692% ECC 35.93% TDC 27.372%
Overtime is paid at the standard O/T rate and will be
el :
Total Charge for Post Feb 2018 £11,137.12 £10,905.83 £8,308.22
e recharged back to each authority as and when incu
ms to focus on ‘Value work’
educe reactive workload on Business Analysts and Infrastru
1st Line S 2nd Line S 3rd Line S
Systems Project Manager Business Analysts
G A P roblems & Incidents R’s & Projects
ructure Specialists and to better Support
Support Support
Technical Project Manager Infrastructure Specialists
3 181 13 ept 2017
Security Service Req Incidents
9 162 12 n 2018 6
ange ease / rease 299 283 85
BCR’s Maintenance Problems
262 80 283
100 120 140
Open KPI Break
20 40 60 80 Incidents Service Requests Security ECC
kdown by Authority
Problems Maintenance BCR EDDC TDC
0,000.00 0,000.00 0,000.00 0,000.00
Product and Service by Cost Code Per Month
0,000.00 0,000.00 0,000.00 £0.00 0,000.00 0,000.00 0,000.00 ST01 ST02 ST03 ST04 ST05 ST06 ST13 ST14 01/04/2017 01/05/2017 01/06/2017 01/07/2017 01/08/2017 01/09/2017 01/10/2017 01/11/2017 01/12/2017
£0.00 £100,000.00 £200,000.00 £300,000.00 £400,000.00 £500,000.00 £600,000.00 £700,000.00 £800,000.00
Total Product Spend by Month
£0.00 £200,000.00 £400,000.00 £600,000.00 £800,000.00 £1,000,000.00 £1,200,000.00 £1,400,000.00 £1,600,000.00 £1,800,000.00 Q1 Q2 Q3
Quarter by Quarter Product and Services Spend Analysis 2017 / 2018
Project Resourc
ce Utilization (%)
15% Leave & Absence 15% Non-Change eg Support, Tr 20% BCRs 50% Projects Over Commitment Project Commitment
500
Open BCR’s
50 100 150 200 250 300 350 400 450 7th Dec 2016 7th Dec 2017
Drop o BCR
en BCRs
200
Open BCR Trend
Dec 2016 Jan 2017 Feb 2017 Mar 2017 Apr 2017 May 2017 Jun 2017 Jul 2017 Aug 2017 Sep 2017 Oct 201 ECC 84 81 85 90 80 82 92 86 84 77 64 EDDC 169 169 154 156 149 132 136 118 102 111 107 TDC 176 174 162 153 147 154 133 135 133 127 118 20 40 60 80 100 120 140 160 180 200
R’s
ct Type 2017 / 2018 2018 / 2019 e Convergence Projects 16 13 e Service Projects 55 16 Total 71 29
Project Demand 2017 / 2018
Total Projects East Devon Exeter Strata Teignbridge
PLEASE NOTE : These graphs do not reflect the size
projects.
10 20 30 40 50 60
Project Demand 2018 / 2019
Total Projects East Devon Exeter Strata Teignbridge
ECC EDD 3255 218 45% 30%
Service Incidents Apr 15 to Oct 17
50 100 150 200 250 300 350
Service Incidents Apr 15 to Oct 17
ECC EDDC TDC
DC TDC 88 1861 % 25%
Total Service Incidents Apr 15 - Oct 17
50 100 150 200 250 300 350 400 450 500
50 100 150 200 250 300 350 400 Feb-17 Mar-17 Apr-17 May-17 Jun-17 Jul-1
End User Feedback Received
10 20 30 40 50 60 70 80 90 100
Positive Neutral
Apr-16 May-16 Jun-16 Jul-16 Aug-16 Sep-16 Feb-17 Mar-17 Apr-17 May-17 Jun-17 Jul-17
17 Aug-17 Sep-17 Oct-17 Nov-17
Received
Negative
Oct-16 Nov-16 Dec-16 Jan-17 Aug-17 Sep-17 Oct-17 Nov-17
the figures are highlighted in green. There has been the figures are highlighted in green. There has been improvement in every area compared to 2016.
Strata has also been commented upon by UNISON.
would recommend Strata as a place to work. years,
50 60 70 80 90 100
Line Management Contact
f n
10 20 30 40 I regularly receive supportive feedback and appreciation from my line manager’s manager I can rely on my line manager’s manager to help me out with a work problem My line manager’s manager champions improvements that benefit our customers I can talk to my line manager’s manager about something that has upset or annoyed me at work I have eno
question manag manager changes at 2015 2016 2017
Adrian
ian Smith
rovement programme
eutral
Office Moves
sues
Robin B
Barlow
PSN
Business Continuity
time requirements recorded
GDPR
Audit
Security status
misconfiguration . Now resolved and further control
h three councils where key systems were agreed and initial recovery ntinuity design paper accredited practitioner (Tracy White) GDPR tandard Data Privacy Impact Assessment forms spam emails being routed via Strata email system due to technical ls put in place to prevent/detect
Martin Millm
Millmow
ull fleet replacement d Printers Underway mouth Offices mouth Offices illed
David Ser
ercombe
Major Projects
Site Service Area Application
ECC Planning, Building Control, Land Charges Uniform Control, Land Charges ECC Corporate Firmstep TDC OneTeignbridge Firmstep EDDC GardenWaste TBA ECC, TDC HR & Payroll iTrent
Status Go Live Notes
Live July 2017
Live November 2017 Phased release to follow Commenced November 2017 Business Case May 2018
underway Implementation Q1 2018
travel claims
Steve Gam
ammon
7/1/2014 11/13/2015 Authorised Projects BACS convergence CMS and Website Redesign (ECC) CMS and Website Redesign (TDC) Digital Delivery Platform (TDC) Door Access GIS ESRI convergence HR and Payroll (ECC) HR and Payroll (TDC) Idox TLC Land Charges Idox UNIform Licensing (TDC) Idox UNIform Planning (ECC) Idox UNIform Planning (ECC) LLPG GGP convergence Time and Attendance Business Cases Car Parks system convergence Cemeteries system Financial Management system Firmstep (EDDC) Grounds / Streets / Public Realm Idox UNIform Env Health (ECC) Legal Case Management Forecast Projects Cash & Income Management systems Document Management convergence Idox UNIform Estates (ECC) Idox UNIform Estates (TDC) Idox UNIform Licensing (ECC+EDDC) Insurance claims management Revenues & Benefits
3/27/2017 8/9/2018 12/22/2019
Steve Gammon
Monthly comparison and analysis of…
Trends…
Incidents down Service-Requests constant BCRs down
e Requests and BCRs ves
System-Outages improving Satisfaction on Completed Jobs 95% Positive
