Indoor Accuracy Test Bed Framework Indoor Accuracy Test Bed Framework Working Group #3 E911 Location Accuracy E911 Location Accuracy September 12, 2012 Stephen J. Wisely and Richard Craig, Co Chairs Test Bed High Level Overview F ll


slide-1
SLIDE 1

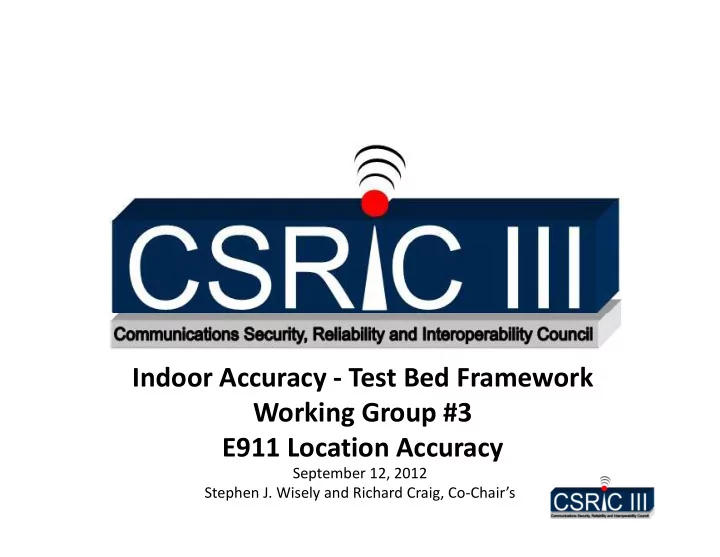

Indoor Accuracy ‐ Test Bed Framework Indoor Accuracy Test Bed Framework Working Group #3 E911 Location Accuracy E911 Location Accuracy

September 12, 2012 Stephen J. Wisely and Richard Craig, Co‐Chair’s

slide-2
SLIDE 2

Test Bed High Level Overview

F ll th FCC’ ti i d f f E911 Ultimate Goal Fully answer the FCC’s questions on indoor performance of E911 location technologies M h l i Dense urban, urban, suburban and rural areas Morphologies , ,

Representative performance data applicable to a cross‐section of the country

Building Types Different building types identified by construction and use

i l id ti l d b i k t / t l t

g yp

commercial, residential, wood, brick, concrete/steel, etc.

Test Points All technologies will be tested at common, undisclosed test points

Deilverable timing may impact number but goal is statistical validity

Testing Entity All testing, including ground truth creation, to be performed by an independent, 3rd party, testing entity

slide-3
SLIDE 3

Test Bed Benefits

P f d t i d d tl d bj ti l ll t d

  • Performance data independently and objectively collected
  • Blind selection of data points

No “cherry picking” or pre‐test optimization T t d 3rd t d i i t ti Objectivity

  • Trusted 3rd party administration
  • Common test methodology across technologies
  • Broad range of morphologies

Sh t h l t th d k i i i t Show technology strengths and weakness in various environments Cost savings Testing costs spread among 7 technologies in stage 1 Results Equal access to results including ground truth for future campaigns – entire industry benefits

slide-4
SLIDE 4

Testing in two stages

Stage 1‐ Target completion ‐ March 31, 2013 Stage 2 – Target TBD, set up after CSRIC III

  • Evaluation of existing technologies and

known new technologies

  • Evaluation of newer location technologies
  • n an ongoing basis
  • Prior to CSRIC III charter termination
  • Proposed to be in San Francisco Bay area
  • Use methodology developed for Stage 1
  • Funding and oversight to be explored
  • Proposed to be in San Francisco Bay area
  • Provides diverse setting that spans all

morphologies while being practical to

  • Funding and oversight to be explored
  • Test focus refined as FCC needs evolve

p g g p execute within given time frame

  • Geographical coverage expanded as

needed

slide-5
SLIDE 5

Participating Companies

Company Technology

Boeing BTL Iridium only mode CommScope [1] DAS proximity detection Boeing NextNav Wide area beacons Polaris Wireless RF Fingerprinting Q l

( h h )

AGPS+AFLT+MCS Qualcomm ( in partnership with Verizon) AGPS+AFLT+MCS TruePosition UTDOA Carriers: ATT, Sprint, T‐Mobile and Verizon

[1]: CommScope will be testing in limited scenarios

slide-6
SLIDE 6

Stage 1 Test Bed Funding Model

Selection of Test Bed Entity Through competitive RFI process ‐ firms familiar to WG3 participants and known to be capable and actively engaged in testing efforts today Contractual Relationships Directly between test bed entity and technology company or combination of technology company and participating carrier partner M d l l b b d i NDA b b d Confidential & Proprietary Info

  • Managed closely by test bed entity, NDAs between test bed

company and test participants directly

  • Carriers can see raw test data for all participants – with NDA only
  • Technology companies only see their own raw data

gy p y Contractual Deliverable Deliverable to WG3 will be non‐proprietary report based on criteria defined in the scope of services developed by WG3 Ultimate Deliverable Report to the FCC with commentary from WG3 providing some color around feasibility and readiness of technologies – for public record

slide-7
SLIDE 7
  • ID Participants
  • ID Available Carrier Networks

D l t t th d l &

High Level Test Bed Schedule

2Q12

  • Develop test methodology & scope
  • Financial model
  • Geographical location of test area
  • Finalize: testing management & oversight of the testing, reporting and auditing process

High Level Test Bed Schedule

3Q12

  • Identification of specific buildings with access
  • Vendor carrier partnership agreement finalization
  • Selection of test house
  • Agreement on test plan

F lfill t f t t i it

  • Fulfillment of test pre‐requisites

4Q12

  • Dry run readiness review
  • Physical testing
  • Data collection and management

4Q12 Data collection and management

  • Produce Report with Assessment
  • Analysis of data ‐ Completion of Preliminary Test Report
  • Audit and verification of Test Report

1Q13

  • Assessment Report will have two parts:
  • (1) Performance observed
  • (2) Assessment of technology availability, standards impact, life cycle cost factors, and projected

implementation timeline
