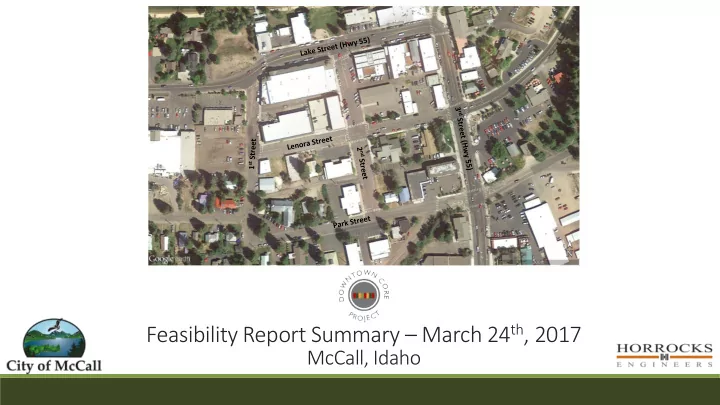

Feasibility Report Summary March 24 th , 2017 McCall, Idaho - - PowerPoint PPT Presentation
Feasibility Report Summary March 24 th , 2017 McCall, Idaho - - PowerPoint PPT Presentation
Feasibility Report Summary March 24 th , 2017 McCall, Idaho Project Schedule Recap November 18 th , 2016 Council Briefing/Workshop Dec. 19 th -23 rd , 2016 Informational Mailer Sent January 4 th , 2017 Open House with Property Owners Draft
Project Schedule Recap
Council Briefing/Workshop November 18th, 2016 Informational Mailer Sent
- Dec. 19th-23rd, 2016
Open House with Property Owners January 4th, 2017 Draft Feasibility Report Jan-March, 2017 Final Council Meeting March 24th, 2017
Project Phasing Options
Originally Shown to Council and the Public
- Option 1: Original Streets L.O.T. Schedule – 4 years of construction; 6 years to complete
- Option 2: 3 years of construction; 5 years to complete
- Option 3: 3-4 years of construction; 3-4 years to complete
Construction Season Options
- Option 1: All surface and subsurface improvements constructed April –
November
- Option 2: Subsurface improvements constructed August – November
(Phase 1) and surface improvements constructed April-June (Phase 2)
Open House Summary
Which Proj Project Ph Phasing o
- ption
- n d
do you
- you pref
efer er? Answe swer O Opt ptions Res espons nse e Per ercent ent Res espons nse e Coun unt Option 1 – 4 years of construction 6 years to complete 0.0% Option 2 – 3 years of construction 5 years to complete 29.0% 9 Option 3 – 3 to 4 years of construction 4 years to complete 64.5% 20 No Preference 6.5% 2 answe wered q d quest stion 31 31 skip ipped q que uestio ion 1
- Occurred January 4, 2017
- 41 people signed in
- 32 comment forms were collected
- Two questions were asked
- Preference for Project Phasing Option 3
- Preference for Construction Season
Option 2
Which c con
- nstru
ruction
- n s
season
- n w
wou
- uld you
you pre refer? Answe swer O Opt ptions Res espons nse e Per ercent ent Res espons nse e Coun unt Option 1 - Construct all improvements April – November 21.9% 7 Option 2 - Construct subsurface utilities from Sept – Nov, with surface construction from April - June 71.9% 23 No Preference 6.2% 2 answe wered q d quest stion 32 32 skip ipped q que uestio ion
Recommendation
It is recommended that the Downtown Core be reconstructed following:
- Project Phasing Option 3a
(3-4 Years Construction)
- Construction Season Option 2
(No work during peak Summer Season)
Project Phasing Option 3a (Recommended)
- Underground Franchise Utilities
in 2017, 2018 or 2019
- 2nd Street & Lenora Street finish
in 2019
- Park Street & Veteran’s Alley
finish in 2020
- 3-4 years of construction 3-4
years to complete
- 1st Street and Storm Water
Facilities when funding is available
Design and Construction Schedule
Option 3 3A Recommende ded d Design n & & Construc uctio ion S Sche hedule ule
Streets L.O.T. Funding Schedule
Based on Project Phasing Option 3a and Construction Season Option 2
*Carries over $1.1 million in Streets L.O.T. fund from 2016 Assumes $1 million from Streets L.O.T. per year after 2016
Year Road Name/Description Current Estimated Total Cost Current Estimated LOT Funds Required Estimated LOT Funds Accumulated Estimated LOT Funds Available after Improvements
2017
Commerce St
$651,000 $651,000 *$2,100,000 $1,449,000 2018
Idaho St/Brown Circle + 2nd St & Lenora Phase 1
$1,735,680 $1,316,046 $2,449,000 $1,132,954 2019
2nd St & Lenora Phase 2 + Park St & Veteran's Alley Phase 1
$4,004,860 $2,403,470 $2,132,954 ($270,516) 2020
Park St & Veteran's Alley Phase 2
$1,332,422 $1,211,562 $729,484 ($482,078) 2021
1st Street Phase 1
$346,016 $194,164 $517,922 $323,758 2022
1st Street Phase 2
$901,037 $844,702 $1,323,758 $479,056 2023
E Deinhard Ln
$1,349,270 $1,349,270 $1,479,056 $129,786 2024
Storm Water Facilities
$720,391 $720,391 $1,129,786 $409,395
City Council Decisions
- Approval of Project Phasing Option
- Approval of Construction Season Option
- Adding 1st St reconstruction and Veteran’s Alley to
improvements
- Adding storm water management facilities to improvements
Next Steps
- Snow removal responsibility policies
- Annual and long term infrastructure maintenance
responsibility policies
- Execute the preliminary design and investigate more specific
