Connect NC Update Joint Legislative Oversite Committee on Capital Improvements Prepared by: The Office of State Budget and Management October 11, 2017 Mark Bondo Monica Scott Andrew Shaw Jim Lora Connect NC Bond Information The Connect


slide-1
SLIDE 1

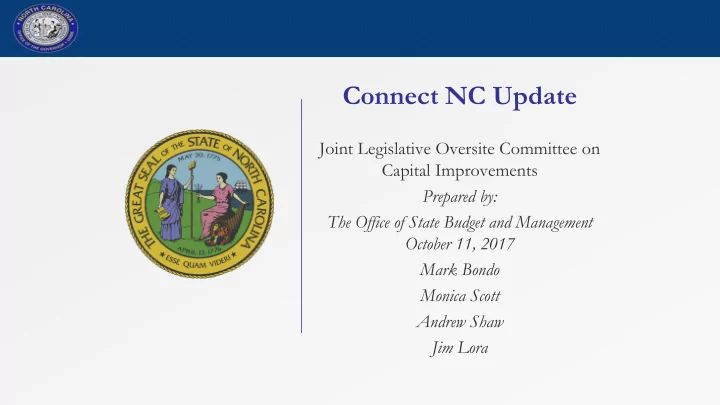

Connect NC Update

Joint Legislative Oversite Committee on Capital Improvements Prepared by: The Office of State Budget and Management October 11, 2017 Mark Bondo Monica Scott Andrew Shaw Jim Lora

slide-2
SLIDE 2

Connect NC Bond Information

  • The Connect NC Bond Act was passed by the General Assembly in

2015 and approved by the Voters in March 2016

  • The Connect NC Bond is a $2 Billion Bond supporting University,

Community College, Public Safety, State and Local Parks, NC Zoo, and Agriculture

2

slide-3
SLIDE 3

Connect NC Bond Information

University 53% Community College 18% Water and Sewer 15% Parks and Zoo 5% Public Safety 4% Agriculture 5%

3

Agriculture includes only the Department of Agriculture and Consumer Services Project. The Plant Sciences Building is included in the University Total

slide-4
SLIDE 4

Debt Service Projections (Prior to Sale of Connect NC Bond)

$0 $100,000,000 $200,000,000 $300,000,000 $400,000,000 $500,000,000 $600,000,000 $700,000,000 $800,000,000 $900,000,000 2015-16 2016-17 2017-18 2018-19 2019-20 2020-21 2021-22 2022-23 2023-24 2024-25

Estimated Connect NC Bond Debt Service

Existing Debt Service Debt Service Estimate 3.5% Debt Service Estimate 5.75%

4

slide-5
SLIDE 5

Debt Service (First Sale of Connect NC Bond)

  • The First Issuance of the Connect NC Bond was sold in August 2016

at an interest rate of 2.079%

  • The First Connect NC Bond sale was for $200 Million
  • The State issues debt based on the cash flow needs of the projects

being financed.

5

slide-6
SLIDE 6

Debt Service Schedule (Post First Connect NC Bond Issuance)

$0 $100,000,000 $200,000,000 $300,000,000 $400,000,000 $500,000,000 $600,000,000 $700,000,000 $800,000,000 $900,000,000 2015-16 2016-17 2017-18 2018-19 2019-20 2020-21 2021-22 2022-23 2023-24 2024-25

Estimated Connect NC Bond Debt Service After First Debt Issuance

Existing Debt Service with First Issuance Projected at 3.5% Projected at 5.75%

6

slide-7
SLIDE 7

Projected Connect NC Project Cash Flow

$0 $200,000,000 $400,000,000 $600,000,000 $800,000,000 $1,000,000,000 $1,200,000,000 $1,400,000,000 $1,600,000,000 $1,800,000,000 $2,000,000,000 FY 2016-17 FY 2017-18 FY 2018-19 FY 2019-20 FY 2020-21 FY 2021-22 FY 2022-23 Original Cash Flow Updated Cash Flow

7

slide-8
SLIDE 8

Connect NC Bond Expenditures

8

$0.56M $2.7M $3.1M $3.4M $1.7M $4.97M $5M $6.8M $9.6M $11.6M $4.9M $15.4M

2,000,000 4,000,000 6,000,000 8,000,000 10,000,000 12,000,000 14,000,000 16,000,000 18,000,000 Aug 16 Sep 16 Oct 16 Nov 16 Dec 16 Jan 17 Feb 17 Mar 17 Apr 17 May 17 Jun 17 Jul 17 Aug 17 Sep 17 Oct 17 Nov 17

Budget Close Out: No Transactions

slide-9
SLIDE 9

Summary Project Detail

9

slide-10
SLIDE 10

Project Updates – Community Colleges Community Colleges received $350 Million in Connect NC Proceeds

– Amount Allocated: $240,100,120

  • New Construction: 52% of Projects
  • Repairs and Renovation: 48% of Projects

– Amount Remaining to be Allocated: $109,899,880 – Community College Campuses Matching Funds: $86,774,859 – New projects are approved by the State Board of Community Colleges Monthly

10

slide-11
SLIDE 11

Project Updates – Community Colleges Project Status:

– Sixty-five (65) approved by State Board awaiting design contracts – Eight (8) projects are under design – advance planning stage – Sixty-five (65) projects are under design – Forty-eight (48) projects are under construction – Nine (9) projects are closed out – Five (5) land purchases have closed

11

slide-12
SLIDE 12

Project Updates: Community Colleges

12

Rowan Community College: Building 300 Renovation (Before and After)

slide-13
SLIDE 13

Project Updates: Community Colleges

13

Rockingham Community College: Center for Advanced Manufacturing Renovations

slide-14
SLIDE 14

Project Updates – University of North Carolina University of North Carolina received $1,065,000,000 in Connect NC Proceeds

– Universities matching $225,667,232 in non-State funds – All funds have been allocated to specific projects – 21 Projects Total – Two (2) projects in construction: Appalachian State, Western Carolina – One (1) Winston Salem State will break ground at the end of 2017 – Of remaining projects:

  • All Projects Have Selected Designer
  • One is still pursuing external fund raising opportunities (UNC Pembroke)

14

slide-15
SLIDE 15

Appalachian State Health Sciences Building

15

slide-16
SLIDE 16

Appalachian State Health Sciences Building

16

slide-17
SLIDE 17

UNC Greensboro: Nursing and Instructional Building

17

slide-18
SLIDE 18

Project Updates – Water and Sewer Infrastructure Department of Environmental Quality Received $209,500,000 for water and sewer loans (Revolving Fund Loan Program) and $100,000,000 in water and sewer grants

  • Department has completed 3 rounds of applications: January 2017,

July 2017, September 2017

  • Currently awarded $74,806,908 in grants and $136,105,962 in loans

with $98,587,130 remaining to award from the last round of applications

  • Projects are funded on a reimbursement cycle with no funds expected

to be drawn until FY 2018-19

18

slide-19
SLIDE 19

Project Updates – Water and Sewer Infrastructure Examples of Projects Funded Under First Two Award Rounds:

– Town of McAdenville: Connection to Two Rivers Utility (Wastewater) – Cape Fear Public Utility Authority: EPA Consent Decree Improvements (Wastewater) – City of Eden: Water Line Extension – Town of Valdese: Water Meter Replacement – City of Graham: Wastewater Line Replacement – Tuskaseigee Water and Sewer Authority: Wastewater Line Replacement and New Pump Stations

19

slide-20
SLIDE 20

Project Updates – Department of Public Safety Received $8,500,000 for Phase II of the Samarcand Training Academy

– Dormitory Renovations:

  • 1)Hope Hall – design and 90% construction complete, delivery scheduled for mid November 2017;
  • 2) Carroll Hall – design and 5% construction complete, delivery scheduled for 4th quarter of calendar year

2018;

  • 3) Tufts Hall – design complete and is in material procurement, construction start scheduled for 1st quarter
  • f calendar year 2018, completion scheduled for 3rd quarter of calendar year 2019

– Dining Hall: design will be issued for construction by late October 2017, construction start scheduled for March 2018, completion scheduled for 3rd quarter of calendar year 2019 – Tactical Training Building – under scope development – Swimming Pool Removal – design complete, construction will fit into the overall project schedule during calendar year 2018

20

slide-21
SLIDE 21

Leonard Hall. To be razed for New Dining Hall. Carroll Hall. 14,000 SF Renovation. Tufts Hall. 11,000 SF Renovation. Hope Hall. 8000 SF Renovation. Swimming Pool. To be removed. Replaced with a recreation area.

Samarcand Training Academy Phase Two Connect NC Bond Aerial Overview

Vocation Building. Removed from scope. 5000 SF Renovation.

slide-22
SLIDE 22

New Dining Hall

  • 8000 SF New Construction
  • Four Serving Lines
  • 200 Person Indoor Seating
  • 50 Person Outdoor Seating
  • Located on Former Leonard Hall Site
slide-23
SLIDE 23

Hope Hall

  • 8000 SF Renovation
  • 20 Dorm Rooms
  • Cardio/Weight Room
  • Housekeeping offices
  • Recreation Room
slide-24
SLIDE 24

Carroll Hall

  • 14,000 SF Renovation
  • 27 Dorm Rooms
  • Classroom
  • Physical Contact Training Room
  • Administrative offices
  • Recreation Room
slide-25
SLIDE 25

Tufts Hall

  • 11,000 SF Renovation
  • 24 Dorm Rooms
  • Classroom
  • Physical Contact Training Room
  • Recreation Room
slide-26
SLIDE 26

Pool Site

  • Remove former swimming pool
  • Convert Pool House to a Picnic Pavilion
  • Convert pool area to a landscaped

gathering space

slide-27
SLIDE 27

Project Updates – Department of Public Safety Received $70 million for Three North Carolina National Guard Readiness Centers:

− Burke County: Advance planning complete, currently in Phase I Design with the demolition of the current Western Youth Institute scheduled no earlier than January, concurrently Phase II of design is at 35% Schematic Design – Guilford County: currently finalizing unit force structure and approvals through National Guard Bureau for environmental and a real estate action plan, designer is completing a utility infrastructure strategy for the site – Wilkes County: currently in preliminary Development Planning of the site location

27

slide-28
SLIDE 28

Burke County

28

slide-29
SLIDE 29

Project Updates: NC Parks North Carolina State Parks Received $75 million for projects at each State park

– All NC Park Projects have been identified – Ten (10) Land Acquisitions To Expand Parks – Twelve (12) Camping/Cabin Area Improvements – Nine (9) Visitor and Community Center Projects – Four (4) Access Improvements (Parking and Roads) – Four (4) Day Use Improvements (Boat ramps, Public Access Facilities, Etc) – Five (5) Other Projects (Renovations, Bathroom Facilities, Etc).

29

slide-30
SLIDE 30

Project Updates: NC Parks Project Status:

– Two (2) Construction Projects Complete – Ten (10) Construction Projects in Design – Seven (7) Designer Interviews Scheduled – One (1) Under Internal Staff Planning – Five (5) Land Acquisitions Expended Funds

30

slide-31
SLIDE 31

Project Updates: Pilot Mountain State Park Visitors Center

31

slide-32
SLIDE 32

Project Updates: Pilot Mountain State Park Visitor Center:

32

slide-33
SLIDE 33

33

Project Updates: Fort Fisher Toilet Building Renovations

slide-34
SLIDE 34

Project Updates: Lake James Visitor Center

34

slide-35
SLIDE 35

Project Update: North Carolina Zoo North Carolina Zoo received $25 million

– Project in Programing and Advance Planning

35

slide-36
SLIDE 36

Project Updates: North Carolina Zoo, Baboon Holding Facility

36

slide-37
SLIDE 37

Project Updates: North Carolina Zoo, Baboon Holding Facility

37

slide-38
SLIDE 38

Project Update: Grants to Local Parks Department of Natural and Cultural Resources received $3 million in matching grants for parks for Children and Veterans with Disabilities

– Grant Applications Closed Dec. 2016 – Grants Awarded March 2017 – Received 45 applications totaling $9.5 million – Awarded 18 projects

38

slide-39
SLIDE 39

Project Update: Grants to Local Parks Examples of Grant Recipients:

– City of Fayetteville: Massey Hill Recreation Center Universally Accessible Sports Field – Town of Maysville: Frost Park Splash Park – Yadkin County: Lance Corporal Daniel Swaim Playground – Town of Oak Island: ADA Beach Access Project – City of Shelby: ALL Aboard Park! Unlimited Play for Everyone – Town of Waynesville: Recreation Park Inclusive Playground

39

slide-40
SLIDE 40

Project Status – Department of Agriculture and Consumer Services Received $94,000,000 for the Veterinary/Food/Drug/Motor Fuels Laboratory

– Currently in the Design Development phase of design – Construction Manager at Risk, J.E. Dunn/T. A. Loving has been approved by the State Building Commission – Commissioning Agent recommendation will be considered by the State Building Commission on October 31 – On track to begin site work in the Spring of 2018 and building construction in the Summer of 2018 – Completion scheduled for Fall of 2020

40

slide-41
SLIDE 41

Project Status: Department of Agriculture and Consumer Services

41

North Carolina Agricultural Science Center – Raleigh, NC – South/Main Entrance

slide-42
SLIDE 42

Project Status – Department of Agriculture and Consumer Services

42

North Carolina Agricultural Science Center – Raleigh, NC - North/Employee Entrance

slide-43
SLIDE 43

Questions Office of State Budget and Management Capital Team:

  • Thomas Cheek, Assistant State Budget Officer
  • Mark Bondo, Budget Analyst
  • Monica Scott, Budget Analyst
  • Andrew Shaw, Budget Analyst
  • Jim Lora, Budget Analyst

mark.bondo@osbm.nc.gov or 919-807-4786
