Board d of E f Educa cation tion Meeting ng Novembe ber r 10, - - PowerPoint PPT Presentation

board d of e f educa cation tion meeting ng novembe ber r
SMART_READER_LITE
LIVE PREVIEW

Board d of E f Educa cation tion Meeting ng Novembe ber r 10, - - PowerPoint PPT Presentation

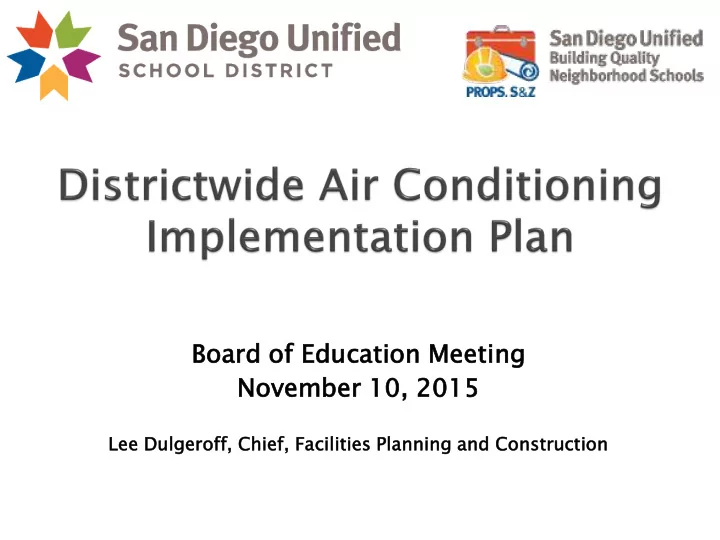

Board d of E f Educa cation tion Meeting ng Novembe ber r 10, 2015 Lee Dulge gero roff, ff, Chief, f, Faciliti ties Planni ning ng and Constr truct uctio ion Temperature and Student Learning Air Conditioning at San Diego


slide-1
SLIDE 1

Board d of E f Educa cation tion Meeting ng Novembe ber r 10, 2015

Lee Dulge gero roff, ff, Chief, f, Faciliti ties Planni ning ng and Constr truct uctio ion

slide-2
SLIDE 2
  • Temperature and Student Learning
  • Air Conditioning at San Diego Unified
  • Implementation Plan
  • Air Conditioned Spaces
  • Schedule
  • Design and Construction Cost
  • Minimize Impact to the General Fund
  • Energy Conservation Measures

2

slide-3
SLIDE 3

 “The preponderance of data of safety,

absenteeism and efficiency…leads to the conclusion that human performance deteriorates rapidly at a temperature above or below a relatively narrow comfort zone.

 Students experience approximately a two

percent reduction in learning ability for every degree a room fluctuates from the optimum.”

Council of Educational Facility Planners journal article by C. William Day

3

slide-4
SLIDE 4

 Researchers have been studying the temperature

range associated with optimum learning for several decades and concluded:

 Students perform mental tasks best when room humidity is between 40-70% and temperatures range from 68 to 74 degrees Fahrenheit  Teacher effectiveness and morale are similarly impacted by classroom temperature

 Adequate Ventilation is essential

Proper oxygen levels are also essential to achieving

  • ptimum performance in logical reasoning and arithmetic

Source: EPA Study

4

slide-5
SLIDE 5

 1999 – Climate Study Initiated

  • Established three climate zones

 Zone 1 = coastal  Zone 2 = central  Zone 3 = inland

 2001 – Ceiling Fan Initiative

  • Board directed staff to utilize passive measures for hottest

schools

  • Ceiling fans, window tinting, etc.

 2008 –Prop S passed; included A/C for Zone 3  2012 – Prop Z passed; included A/C for Zone 2  2013 – HVAC 2000

  • Board directed staff to expedite A/C for 2000 hottest

classrooms

5

slide-6
SLIDE 6

 Expedited air conditioning in remaining

qualifying spaces in all climate zones

 Three-year implementation plan starting  in January 2016  Template approach:

  • Standardized systems
  • Individual, rooftop package units
  • Fast-track process for design,
  • DSA review and procurement

 Separate expedited project and WSM  Minimize impact on schools during

construction

  • Work performed after school hours, including

evenings, weekends, and vacations

6

slide-7
SLIDE 7

 Indefinite Delivery Indefinite Quantity (IDIQ)

  • Competitively bid construction contracts based on estimated

quantities

  • Allows for a large amount of work across multiple sites in a

condensed timeframe

  • Individual A/C projects scheduled according to

heat ranking

 Whole Site Modernization (WSM)

  • Schools scheduled to start their WSM by 2018,

will receive A/C under that project

  • HVAC will be incorporated into the overall WSM

project design,

Installation will be performed with other WSM work

7

slide-8
SLIDE 8

 Electrical Upgrades

  • Sufficient electrical infrastructure required

 A/C installation requires electrical infrastructure, transformers, switch gear, new conduit wiring and electrical panels

  • Some schools will need power upgrades

 Potential periods of power outages

  • Requires coordination with utility company

8

slide-9
SLIDE 9

 Core classrooms, assembly areas, nurses’ offices and

  • ther primary use spaces:
  • Permanent Classroom
  • Non-Permanent Classroom
  • Assembly Space
  • Auditorium
  • Cafeteria
  • Career Center
  • Conference Rooms
  • Core Support/Resource/Focus/Push-

in/Pull-out room

  • Counselor’s Office
  • Custodial Office
  • Faculty Lounge or Dining
  • IDF/MDF Rooms
  • Lecture Hall
  • Library
  • Multi-purpose Room
  • Nurse/Health
  • Occupational/Physical/Speech Therapy
  • Parent Rooms
  • PE/Coaches Office
  • Pre-School/Headstart
  • PrimeTime
  • Principal/Staff Office
  • Reception/Waiting Area
  • School Police Office
  • Stage
  • Student Center
  • Study Hall
  • Testing Room
  • Theatre
  • Vocational Classroom (excluding shops)
  • Work Rooms
  • One-on-One Instruction/Small Group

Instruction/Behavior Modification Room

9

slide-10
SLIDE 10

 To conserve energy the following types of spaces will

not be air conditioned:

  • Kiln Rooms
  • Kitchens
  • Restrooms
  • Showers
  • Storage Spaces
  • Supply Rooms
  • Team/Locker Rooms
  • Gymnasiums
  • Interior Corridors
  • PE Prep
  • Weight Training
  • Wrestling Rooms
  • Dance Studios
  • Vocational Shops

(Woodshop, Auto Shop, Metal Shop, etc.)

10 10

slide-11
SLIDE 11

 DESIGN: Each A/C project at each school requires an architectural

design and engineering plan

  • Average duration three months

 DSA: Plans must be submitted to the Division of State Architect

for review and approval prior to the start of construction

  • Average duration three to six months

 BID and AWARD: A construction contract for the performance of

the A/C installations must be procured through the bid and award process

  • Average duration four months

 CONSTUCTION: Installation will occur either through an IDIQ

contract or a WSM project

  • Duration varies depending on type and quantity of spaces to be air

conditioned

11 11

slide-12
SLIDE 12

Phase ase 1A - Proj

  • ject

ct Comple plete te $110M 0M Actual al

  • Board approved February 2013: 2,000 hottest classrooms
  • Climate Zone 3 schools and some Zone 2 schools
  • Air conditioning for classroom spaces
  • Projec

ect t complete te

Phase ase 1B - Ins nstal tallation lation 2016 $18M Estima timate ted

  • Continuation of A/C at Phase 1A sites
  • A/C for nurse’s offices, assembly areas, and other critical spaces
  • Project in design
  • Installation starts in early 2016

Phase ase 2 (Prop

  • pose
  • sed)

d) - Inst stal allation lation 2016-2019 019 $204M 4M Esti tima mate ted

  • Expedited A/C for remaining qualifying spaces in all climate zones
  • Continuation of A/C in remaining spaces at Phase 1A sites

12 12

slide-13
SLIDE 13

 Additional Energy Cost Estimate: $2.8M Annually  Maintenance Cost Estimate:

  • Initial Year Total: $2.15M
  • $1.4M (maintenance)
  • $750,000 (trucks, tools, and equipment)
  • Ongoing: $1.4M per year (maintenance staff and materials)

 Offsets:

  • Concurrent Photovoltaic (PV) projects
  • Modernization projects include insulation

efficient windows, etc.

  • A/C System Controls

13 13

slide-14
SLIDE 14

 Installation of solar panels at 16-20 schools

  • Offset air conditioning consumption 10.5M KWhr/year
  • $40M estimated construction/installation cost
  • $2.8M estimated energy cost offset annually

 PV at 8 schools designed for installation in 2016:  Nye ES  Penn ES  Tierrasanta ES  Scripps ES  Zamorano ES  Mira Mesa HS  Morse HS  Serra HS  PV at an additional 8-12 schools

installed 2017

14 14
