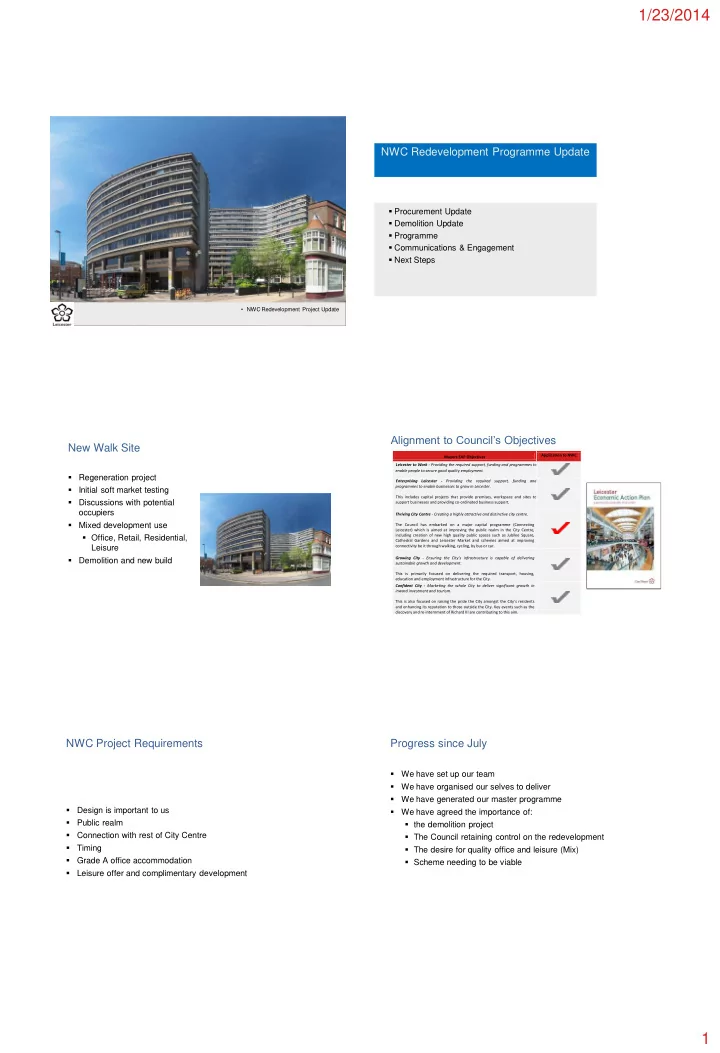

slide-1
SLIDE 1

1/23/2014 1

  • NWC Redevelopment Project Update
  • Procurement Update
  • Demolition Update
  • Programme
  • Communications & Engagement
  • Next Steps

NWC Redevelopment Programme Update New Walk Site

  • Regeneration project
  • Initial soft market testing
  • Discussions with potential
  • ccupiers
  • Mixed development use
  • Office, Retail, Residential,

Leisure

  • Demolition and new build

Alignment to Council’s Objectives

Mayors EAP Objectives Application to NWC Leicester to Work - Providing the required support, funding and programmes to enable people to secure good quality employment. Enterprising Leicester - Providing the required support, funding and programmes to enable businesses to grow in Leicester. This includes capital projects that provide premises, workspace and sites to support businesses and providing co-ordinated business support. Thriving City Centre - Creating a highly attractive and distinctive city centre. The Council has embarked on a major capital programme (Connecting Leicester) which is aimed at improving the public realm in the City Centre, including creation of new high quality public spaces such as Jubilee Square, Cathedral Gardens and Leicester Market and schemes aimed at improving connectivity be it through walking, cycling, by bus or car. Growing City - Ensuring the City’s infrastructure is capable of delivering sustainable growth and development. This is primarily focused on delivering the required transport, housing, education and employment infrastructure for the City. Confident City - Marketing the whole City to deliver significant growth in inward investment and tourism. This is also focused on raising the pride the City amongst the City’s residents and enhancing its reputation to those outside the City. Key events such as the discovery and re-internment of Richard III are contributing to this aim.

NWC Project Requirements

  • Design is important to us
  • Public realm
  • Connection with rest of City Centre
  • Timing
  • Grade A office accommodation
  • Leisure offer and complimentary development

Progress since July

  • We have set up our team
  • We have organised our selves to deliver
  • We have generated our master programme
  • We have agreed the importance of:
  • the demolition project
  • The Council retaining control on the redevelopment
  • The desire for quality office and leisure (Mix)
  • Scheme needing to be viable
slide-2
SLIDE 2

1/23/2014 2

New Walk Centre Project

  • Information

Sarah Woffenden Project delivery team Project Lead Project Lead Peter Cook NWC Demolition

Stakeholder Groups Project Board

Andrew Tice Project delivery team NWC Commercial Team Project delivery team Planning / Highways / Technical Support Project delivery team NWC Communications & Engagement Andrew Shilliam / Nicola Mirams Andrew Smith Project delivery team Accommodation Strategy Implementation (ASI)

Soft market testing

  • The soft market testing exercise proved to be a very useful
  • We better understand how potential developers see the site; and

how they see working with the Council

  • Overall, the market appears to be very keen on the development

potential

  • Any procurement process or next steps need to be succinct and

inclusive for all In summary

Procurement strategy

■ Influence time and design ■ Public Procurement Route ■ Focus on New Walk Site/ Marlborough Site ■ Competitive Dialogue ■ Partner

Demolition update

  • Programme developed
  • Council will contract directly
  • Start on site July 2014
  • Engagement and consultation as the

project develops

  • Hand over site as development starts

Programme

  • Communication of scheme (January 2014)
  • OJEU notice released (Feb 2014)
  • Sign-off of demolition contractor (April 2014)
  • Decant NWC staff June (2014)
  • Vacant Possession of NWC site (July 2014)
  • Final Redevelopment proposals (Sept 2014)
  • Developer selection and contract sign-off (December

2014)

Timeline

Q4 Q3 Q1 Q2 Q3 Q4 Q1 Q2 Q3 Q4 Q1 Q2

  • Information

Project Lead Peter Cook NWC Commercial Redevelopment Procure Demolition Scope and specify Tender & Evaluate Select & Appoint Mobilise Planning / Highways / Technical Support Refurbishment & preparation

  • f new LCC Office

Accommodation Accommodation Strategy Implementation (ASI) NWC Demolition Project Decant Employees Secure & Set Site up Vacant Possession Summer 2014 Demolition Project Surveys & Investigations Safe Strip Out, Enabling Works Soft Strip (Recyclables) etc. Progressive Demolition Commercial Redevelopment Project Vision, Strategy, Invite final proposals Market demand, procurement, Evaluate proposals Finalise delivery strategy Comm Close-out Prepare prospectus PIN Marketing Commencement PQQ Contracts / Agreements Exchange Early 2015 Approvals & Mobilisation Development Partner Planning Applications Statutory consents Design / Specifications Start Redevelopment Works on Site Development Partner Possible phased development

2013 2014 2015 2016

Development Partner Starts Redevelopment Work on NWC Site Mid / Late 2015 Completion on Site TBC Possible phasing Late 2017 & Beyond LCC Technical Support to Commercial Redevelopment Project Planning Conservation Land & Property Highways (Stopping up orders etc.) Civils Handover Site to Development Partner

slide-3
SLIDE 3

1/23/2014 3

Communications & engagement

  • Stakeholders mapped
  • Members
  • Staff/ Trade unions
  • Local residents
  • Local businesses
  • City Centre business community
  • On-going regular updates
  • Asking some groups how they would like to engaged
  • Regular email
  • Newsletter
  • Face to face

Next steps

■ Communications and engagement ■ Forward plan entry ■ Formal approval to proceed in February ■ Commence procurement mid February for development and demolition

Accommodation Strategy Phase 1 Update

  • £19.9m programme
  • Vacate NWC by end of June 2014
  • Programme of buildings:
  • City Hall
  • Princess Road West (formerly Hearts of Oak House)
  • Sovereign House
  • 16 New Walk
  • York House (new Customer Service Centre)
  • Relocation of data centre

Accommodation Strategy Progress Update

  • City Hall
  • Contractors on-site,
  • 2nd, 3rd and 4th office floors construction complete early June,
  • ccupancy by 30 June
  • Ground and first floors completion 31 July
  • Princess Road West
  • Contractors on-site, completion end March, occupancy April
  • Sovereign House
  • Contractors on-site,
  • 3rd and 1st Floors complete and occupied. Completion 10th

February;

Progress Update – cont’d

  • 16 New Walk
  • minor works tenders currently being evaluated,
  • 1st floor completion and occupancy by end February
  • York House
  • 2 elements – Customer Service Centre and office

accommodation:

  • Customer Service Centre – opening 27th January;
  • Office accommodation – current phase of works complete end

June;

  • Data Centre – contractors on-site, completion expected end

March.

  • Procurement of construction packages - using Source

Leicester

Accommodation Strategy Phase 2

Moving on to phase 2. This includes: ■ Amendments/revisions/deletions to phase 1 ■ New schemes.

slide-4
SLIDE 4

1/23/2014 4

Amendments/Revisions/Deletions to Phase 1

  • Cost adjustments following building assessments:
  • Asbestos removal
  • Mechanical and electrical requirements
  • Fire protection requirements
  • Energy savings initiatives (that will payback over time)
  • Facilitating new ways of working (floor plans, desk layout and

associated furniture)

  • Tender prices received
  • Provisional sums not required

New Schemes

  • Additional availability of space
  • Former “Haart” space in City Hall
  • Princess Road West extra capacity
  • Phoenix House
  • Relocation of Connexions service (to 16 New Walk) with
  • ccupancy in April;
  • Training facilities
  • Upgrading heating and ventilation to increase occupancy levels

(Princess Road West)

  • Regulatory services
  • Coroners requirements – Town Hall

Funding of Phase 2

Expected cost £3.5m Funding £ Existing funding 1.8 One-off corporate underspends (pay award and capital financing) 1.7 3.5

Questions
