Village of Clinton Proposed Sanitary Sewer System December 11, 2017 - - PowerPoint PPT Presentation

village of clinton
SMART_READER_LITE
LIVE PREVIEW

Village of Clinton Proposed Sanitary Sewer System December 11, 2017 - - PowerPoint PPT Presentation

Village of Clinton Proposed Sanitary Sewer System December 11, 2017 December 16, 2017 6:30 P.M. 10:00 A.M. WHY ? Hot Spot Areas Health Concerns EPA Involvement EPA Findings & Orders ($$) Keep Local Control


slide-1
SLIDE 1

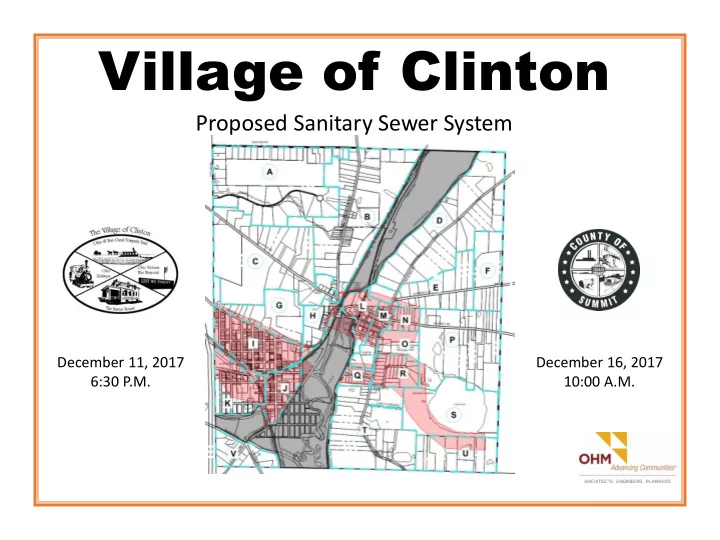

Village of Clinton

Proposed Sanitary Sewer System

December 11, 2017 6:30 P.M. December 16, 2017 10:00 A.M.

slide-2
SLIDE 2

WHY ?

  • “Hot Spot” Areas
  • Health Concerns
  • EPA Involvement
  • EPA Findings &

Orders ($$)

  • Keep Local

Control

  • Village / County
  • Alternative: EPA
slide-3
SLIDE 3

Public Meetings to Date

  • Meeting 1 – March 9th, 2016
  • Introduction and Background
  • Meeting 2 – April 19th, 2016
  • Information Investigation and Preliminary Analysis
  • Meeting 3 – May 17th, 2016
  • Sewer Type Comparison and Preliminary Cost Estimate
  • Meeting 4 – September 6th, 2016
  • Narrowed System Types and Assessment Method Comparisons
  • Meeting 5 – November 15th, 2016
  • Provided Engineer’s recommendation for System Type, Assessment Method and Project

Cost Estimate

slide-4
SLIDE 4

Village of Clinton

Sanitary Sewer Collection Study Sewer Meeting #1 - March 9th, 2016

Introduction and Background

slide-5
SLIDE 5

Project History

  • 2010-2011
  • Summit County Department of Sanitary Sewer Services:
  • Southwest Summit County Wastewater Study (Nov. 2010)
  • Southwest Summit County Sanitary Sewer Master Plan (Dec. 2010)
  • Southwest Summit County Wastewater Action Plan (Oct. 2011)
  • “Hot Spot” Areas Delineated
  • Analyzed Gravity Sewer vs. Vacuum Sewers
  • Vacuum Sewers - $3.95 Million Assessment Cost
  • 2014
  • Design for Vacuum sewer is mostly completed
  • Public meeting presents the Construction Estimate at $8.06 Million
  • 2015
  • Village Interviews firms and hires OHM
  • Attended SCEIG to review funding options
  • Decision made to work cooperatively with the County to find

a fair & equitable solution

slide-6
SLIDE 6
  • 2016
  • Began re-engagement with 5 public meetings

throughout the year

  • Reviewed alternative sanitary sewer designs
  • Reviewed alternate assessment methods
  • Discussed findings with the Village, DSSS, and citizens
  • 2017
  • Negotiated with Summit County DSSS to finalize

assessment method and discuss DSSS participation

  • NOW
  • Village & County Councils: Legislation to Proceed
slide-7
SLIDE 7

Village of Clinton

Sanitary Sewer Collection Study Sewer Meeting #2 – April 19th, 2016

Information Investigation and Preliminary Analysis

slide-8
SLIDE 8

Service Areas Selection

  • Service Areas were

divided based on many factors:

  • Geography (Land

features, Hills and Valleys, etc.)

  • Land Use (i.e. future

development)

  • Natural Divides (e.g.

River, Railroad, etc.)

  • Project Priority Areas

(i.e. phases)

  • Settled on 22

Sections

slide-9
SLIDE 9

SERVICE AREA TOTAL AREA (AC) EXISTING PARCELS FUTURE PARCELS TOTAL FUTURE PARCELS EXISTING ZONING ELEVATION (FT.) POSSIBLE SEWER DESIGN LOW HIGH A 217 35 54 89 R1/CON 1000 1185 P,G B 219 45 66 111 R1/CON 955 1005 G,P,V C 213 26 123 149 CON 955 1170 G (P,V) D 200 11 27 38 R1 1000 1085 P E 79 16 6 22 R1/R2 995 1101 G (P,V) F 57 6 30 36 R1 1065 1101 P G 68 16 26 42 CON/R3 990 1017 G (P,V) H 33 19 12 31 R3 955 990 G (P,V) I 83 76 128 204 R3 960 1012 G (P,V) J 35 30 42 72 R3 950 960 G (P,V) K 60 23 4 27 I 948 958 P,V L 31 29 19 48 C1/C2/R3 949 959 P,V M 32 43 5 48 CR/R3 1001 962 G,P,V N 17 18 18 R2 973 999 G (P,V) O 27 2 14 16 R2 960 961 G (P,V) P 157 24 83 107 CON/R1 980 1031 P,V Q 14 22 1 23 R3 946 960 P,V R 35 18 1 19 R2 957 962 G,P,V S 122 69 10 79 CON 945 957 P,V T 161 26 26 52 R2/CON 950 960 P,V (G) U 73 5 40 45 CON 954 1005 P V 38 15 11 26 CON 950 999 G,P,V TOTAL 1971 574 728 1302 POPULATION 1219 1546 2765

slide-10
SLIDE 10

Village of Clinton

Sanitary Sewer Collection Study Sewer Meeting #3 – May 17th, 2016

Sewer Type Comparison and Preliminary Cost Estimate

slide-11
SLIDE 11

PUBLIC AGENCY COSTS

  • Sewer System Costs
  • Underground collection system
  • Piping, valves, vaults, manholes, pumps, etc.
  • Restoration Costs
  • Surface repairs and infrastructure repairs
  • Yards, driveways, sidewalks, streets, utilities, etc.
  • General Contract Costs
  • Mobilization, bonding, traffic control, contingencies, etc.
  • Long-Term Operation and Maintenance
  • Cleaning, jetting, repairs, replacements, power, permitting, etc.

Private Property Owner Costs

  • Private Sewer Connection Costs
  • Demo and Abandon Existing System
  • Connect House System to Public System (at the right-of-way)
  • Long-Term Operation and Maintenance costs
  • Cleaning, jetting, repairs, replacements, power, etc.
slide-12
SLIDE 12

SYSTEM COMPARISONS

VACUUM GRAVITY STEP LOW PRESS. DEPTH OF MAIN VARIES VARIES 5’ 5’ SIZE OF MAIN (Approximate Size) VARIES (4”-10”) VARIES (8”-24”) VARIES (2”-10”) VARIES (3”-10”) VAULT REQUIRED YES NO YES YES OWNER OF VAULT PUBLIC N/A PUBLIC PUBLIC VALVE/PUMP REQUIRED YES NO YES YES OWNER OF VALVE/PUMP PUBLIC N/A PRIVATE PRIVATE POWER REQUIRED NO NO YES YES OWNER OF POWER N/A N/A PRIVATE PRIVATE

slide-13
SLIDE 13

Service Areas Public Costs

PRIMARY SECONDARY FUTURE NOT FEASIBLE

Note: Service Area H is included in the primary subtotal for Vac Sewers. Service Areas H and T are included in the primary subtotal for Pressure Sewer.

TOTAL CONNECTION TOTAL CONNECTION TOTAL CONNECTION TOTAL CONNECTION A 40 $ 730,427.20 $ 18,260.68 $ 723,747.20 $ 18,093.68 $ 730,427.20 $ 18,260.68 B 36 $ 564,708.80 $ 15,686.36 $ 587,302.00 $ 16,313.94 $ 591,152.00 $ 16,420.89 $ 587,302.00 $ 16,313.94 C 24 $ 663,752.00 $ 27,656.33 $ 639,168.80 $ 26,632.03 $ 490,068.80 $ 20,419.53 $ 502,488.80 $ 20,937.03 D 12 $ 537,820.00 $ 44,818.33 $ 438,520.00 $ 36,543.33 $ 537,820.00 $ 44,818.33 E 18 $ 339,224.00 $ 18,845.78 $ 353,124.00 $ 19,618.00 $ 305,024.00 $ 16,945.78 $ 304,024.00 $ 16,890.22 F 7 $ 114,400.00 $ 16,342.86 $ 115,400.00 $ 16,485.71 $ 114,400.00 $ 16,342.86 G 21 $ 579,195.80 $ 27,580.75 $ 469,103.80 $ 22,338.28 $ 364,740.80 $ 17,368.61 $ 362,760.80 $ 17,274.32 H 15 $ 579,195.80 $ 38,613.05 $ 248,436.00 $ 16,562.40 $ 270,924.00 $ 18,061.60 $ 267,524.00 $ 17,834.93 I 78 $ 1,178,872.40 $ 15,113.75 $ 1,473,209.20 $ 18,887.30 $ 1,247,568.00 $ 15,994.46 $ 1,230,068.00 $ 15,770.10 J 26 $ 442,737.80 $ 17,028.38 $ 559,802.00 $ 21,530.85 $ 397,694.40 $ 15,295.94 $ 390,604.40 $ 15,023.25 K 19 $ 408,768.40 $ 21,514.13 $ 409,985.60 $ 21,578.19 $ 289,385.60 $ 15,230.82 $ 280,525.60 $ 14,764.51 L 23 $ 529,476.20 $ 23,020.70 $ 629,127.40 $ 27,353.37 $ 495,414.20 $ 21,539.75 $ 487,724.20 $ 21,205.40 M 45 $ 563,179.00 $ 12,515.09 $ 554,170.80 $ 12,314.91 $ 666,724.80 $ 14,816.11 $ 641,994.80 $ 14,266.55 N 19 $ 153,864.00 $ 8,098.11 $ 157,840.80 $ 8,307.41 $ 204,664.00 $ 10,771.79 $ 185,564.00 $ 9,766.53 O N/A N/A N/A N/A N/A N/A N/A N/A P 20 $ 303,931.60 $ 15,196.58 $ 311,041.60 $ 15,552.08 $ 303,931.60 $ 15,196.58 Q 16 $ 117,868.00 $ 7,366.75 $ 200,668.00 $ 12,541.75 $ 166,168.00 $ 10,385.50 $ 148,968.00 $ 9,310.50 R 16 $ 242,181.60 $ 15,136.35 $ 211,302.40 $ 13,206.40 $ 196,662.40 $ 12,291.40 $ 185,022.40 $ 11,563.90 S 68 $ 684,762.40 $ 10,070.04 $ 808,596.00 $ 11,891.12 $ 859,196.00 $ 12,635.24 $ 808,596.00 $ 11,891.12 T 17 $ 470,431.00 $ 27,672.41 $ 515,744.60 $ 30,337.92 $ 416,929.20 $ 24,525.25 $ 389,729.20 $ 22,925.25 U 7 $ 18,000.00 $ 2,571.43 $ 227,038.40 $ 32,434.06 $ 244,698.40 $ 34,956.91 V $ 8,240,926.40 $ 23,817.71 $ 7,752,131.00 $ 23,420.34 $ 6,158,137.40 $ 16,964.57 $ 5,961,147.40 $ 16,421.89 $ 1,567,684.80 $ 20,098.52 $ 2,637,620.80 $ 19,394.27 $ 1,322,617.60 $ 16,328.61 $ 1,309,657.60 $ 16,168.61 $ 470,431.00 $ 27,672.41 $ 1,710,733.40 $ 28,512.22 $ 1,879,374.40 $ 22,643.07 $ 2,015,434.40 $ 24,282.34 $ 9,808,611.20 $ 23,133.52 $ 10,389,751.80 $ 22,247.86 $ 7,480,755.00 $ 16,848.55 $ 7,270,805.00 $ 16,375.69 $ 10,279,042.20 $ 23,308.49 $ 12,100,485.20 $ 22,961.07 $ 9,360,129.40 $ 17,761.16 $ 9,286,239.40 $ 17,620.95 PRIMARY SUBTOTAL SECONDARY SUBTOTAL FUTURE SUBTOTAL P.S. & F.M. PRIMARY + SECONDARY VILLAGE TOTAL Service Area Connections

GRAVITY SEWER STEP SEWER LOW PRESSURE SEWER

N/A N/A N/A N/A N/A N/A

VACUUM SEWER

PROPOSED SERVICE AREAS

$ 2,760,825.00 $ 2,578,325.00 $ 582,066.00 $ 582,066.00 N/A N/A N/A

slide-14
SLIDE 14

CAUTION:

  • Preliminary cost estimate prior to detailed design
  • These costs are subject to change
  • Based upon engineering assumptions
  • Prices could go down:
  • Commercial/Industrial Connections
  • Sharing Connections
  • Trench relocations/Installation method
  • Prices could go up:
  • Upsizing pipes for future flows
  • Material & Labor Costs/Inflation
  • Unforeseen Conditions/Underground Issues
slide-15
SLIDE 15

Village of Clinton

Sanitary Sewer Collection Study Sewer Meeting #4 – September 6th, 2016

Narrowed System Types and Assessment Method Comparisons

slide-16
SLIDE 16

Narrowing the System Types

VACUUM GRAVITY STEP LOW PRESS. DEPTH OF MAIN VARIES VARIES 5’ 5’ SIZE OF MAIN (Approximate Size) VARIES (4”-10”) VARIES (8”-24”) VARIES (2”-10”) VARIES (3”-10”) VAULT REQUIRED YES NO YES YES OWNER OF VAULT PUBLIC N/A PUBLIC PUBLIC VALVE/PUMP REQUIRED YES NO YES YES OWNER OF VALVE/PUMP PUBLIC N/A PRIVATE PRIVATE POWER REQUIRED NO NO YES YES OWNER OF POWER N/A N/A PRIVATE PRIVATE WHY REMOVE STEP AND GRAVITY?

slide-17
SLIDE 17

Gravity

  • Expensive
  • Topography Issues
  • Deep Pipe (increased

disturbance)

  • Need for lift stations
  • Still need Low Pressure in

some areas

  • Future Development
  • Upsizing now might not

meet existing requirements (i.e. pipe velocity)

  • Extra cost for upsizing that

may not be needed

STEP

  • County does not want to

maintain the system

  • Filter Cleaning
  • Septic Tank Pumping
  • Pump Replacement
  • Cleaning filter is not

environmentally friendly

  • Some people may require

additional pumping from the house to the R/W.

  • Extra storage capacity is

not as important on well water systems

slide-18
SLIDE 18

Vacuum Sewers

Pros

  • Already Designed
  • Completely maintained

by the County

  • Continues working

during power outage

  • Don’t pay for electrical
  • Vacuum station can be

split and moved away from downtown

Cons

  • Higher Construction

Cost

  • Must be installed at

right-of-way

  • May require pumping

from house

  • Higher Sewer Rates
slide-19
SLIDE 19

Low Pressure Sewer

Pros

  • Can be located

anywhere on the Property

  • Cheaper Construction

Cost

  • Lower Sewer Rates
  • No need for utility

stations in town

Cons

  • Will need to pay for

redesign

  • Existing Design

Modification

  • All equipment

maintained by the homeowner

  • Pump (5-10 yrs)
  • Tank (30+ yrs)
  • Electrical Panel
  • Will not work without

power

slide-20
SLIDE 20

Service Areas Public Costs

TOTAL CONNECTION TOTAL CONNECTION G 15 $ 223,344.80 $ 14,889.65 $ 331,160.80 $ 22,077.39 H 21 $ 603,595.80 $ 28,742.66 $ 299,124.00 $ 14,244.00 I 75 $ 1,216,172.40 $ 16,215.63 $ 1,214,268.00 $ 16,190.24 J 32 $ 473,787.80 $ 14,805.87 $ 423,004.40 $ 13,218.89 K 24 $ 402,518.40 $ 16,771.60 $ 307,325.60 $ 12,805.23 L 27 $ 541,576.20 $ 20,058.38 $ 508,924.20 $ 18,849.04 M 44 $ 551,079.00 $ 12,524.52 $ 637,194.80 $ 14,481.70 N 19 $ 153,864.00 $ 8,098.11 $ 185,564.00 $ 9,766.53 Q 17 $ 124,118.00 $ 7,301.06 $ 154,368.00 $ 9,080.47 R 23 $ 229,481.60 $ 9,977.46 $ 221,422.40 $ 9,627.06 S 68 $ 684,762.40 $ 10,070.04 $ 808,596.00 $ 11,891.12 T 29 $ 463,981.00 $ 15,999.34 $ 453,129.20 $ 15,625.14 $ 8,429,106.40 $ 21,393.67 $ 6,126,147.40 $ 15,548.60 PRIMARY SUBTOTAL (389 Services) P.S. & F.M.

VACUUM SEWER

PROPOSED SERVICE AREAS

$ 2,760,825.00 $ 582,066.00 Service Area Connections

LOW PRESSURE SEWER

slide-21
SLIDE 21

Gravity Lateral to Vacuum Grinder Lat to Vacuum Low Pressure Private Assessment $21,394 $21,394 $15,549 Lateral $3,5002,3 $3,0002 $2,000 Electrical Installation $0 $1,000 $1,000 Electricity (.5hr/day)1 $0 $544 $544 Pump REPLACEMENT $0 $1,0004 $7504 TOTAL $24,894 $26,938 $19,843

ESTIMATED 20 YEAR COST

  • 1. All pumps run 1/2 hour per day @ $0.10 per kWh
  • 2. Vacuum laterals cost more due to added length needed to run lateral to the intersection of the property line and R/W.
  • 3. Gravity Laterals cost more due to increased lateral diameter.
  • 4. Grinder Pumps are 2 HP, $250, and 5 yr lifespan (first pump included in assessment).
slide-22
SLIDE 22

CHOOSING THE RIGHT ASSESSMENT FOR CLINTON

  • What makes a good assessment?
  • Is it fair?
  • Ensure that everyone being assessed is pay the proper share of

their project.

  • Is it defendable?
  • The method should be able to stand up in court.
  • Does it account for unusual circumstances?
  • People with unique properties (e.g. flag lots, shared parcels,

HOA ownership, etc.) should pay a fair portion of the assessment.

  • Does it account for future development?
  • People building after sewer construction should still pay for

their portion of the project.

slide-23
SLIDE 23

THE CHALLENGES…

  • Clinton has VERY unique and diverse property
  • wnership.
  • Flag Lots
  • Lots of area, very little frontage
  • Shallow Lots
  • Lots of frontage, very little area
  • Paper Streets
  • Very small parcels (many are shared by one home)
  • Many parcels are unlikely to develop
  • Luna Lake
  • One Parcel, many houses, very little frontage
slide-24
SLIDE 24

The Original Assessment

  • Based and weighted on 5 criteria
  • Frontage (5%)
  • Area (5%)
  • Land Value (25%)
  • Parcel Connection (60%)
  • Zoning (5%)
  • Vacant lots were assessed as if they were

developed

slide-25
SLIDE 25

Method Analysis

  • Chose a small representative group of properties
  • Ran multiple scenarios to see change across

properties

  • Fair distribution was more significant than actual cost
  • 4 Scenarios were run and modified
  • Modified Summit County Assessment (land value and

zoning) removed

  • Stark County Codified Ordinance
  • Stark County modified for acreage instead of frontage
  • Land Value Appreciation with connection
slide-26
SLIDE 26

Summary of Assessment Methods

No. Parcel Original Summit County Modified Summit County Stark County Modified Stark County Land Value Only 1 2701096 $25,194 $23,012 $47,377 $23,905 $22,237 2 2701084 $14,538 $20,102 $14,993 $21,344 $20,422 3 2701665 $42,497 $8,381 $2,699 $35,004 $6,780 4 2700107 $17,615 $20,572 $22,189 $21,344 $21,157 5 2700348 $15,956 $20,599 $14,993 $34,150 $20,698 6 2700349 7 2700350 8 2700351 9 2700129 $18,580 $21,616 $38,382 $21,344 $21,202 10 2701425 $23,515 $8,924 $18,441 $22,198 $2,418 11 2700175 $20,267 $24,486 $97,753 $21,344 $21,067 12 2701832 $15,732 $20,599 $23,988 $21,344 $20,632 13 2700563 $1,025,790 $1,364,791 $1,019,510 $1,316,489 $1,385,362 ($13,862) ($20,070) ($14,993) ($17,790) ($20,373) 14 2701550 $29,413 $32,720 $261,474 $21,344 $23,702 15 2701537 $20,154 $21,578 $16,792 $23,905 $21,037

slide-27
SLIDE 27

Recommendations

  • A land value based approach appears to work best
  • Does not single out unique properties
  • Frontage/acreage doesn’t matter
  • Vacant land is still accounted for (through value

appreciation) but not charged extra for a connection they may never get

  • Future development can be incorporated into Connection Cost

(i.e. tap-in fees)

  • Majority of cost is in the connection
slide-28
SLIDE 28

Challenges

  • Estimating property appreciation
  • May need to hire appraiser (defendable)
  • County must assume a portion of upfront cost in
  • rder to make future tap-in fees balance over time
  • A good compromise (residents can get a discount and

the county can return on investment)

  • Clinton must estimate future growth over the next 20

years to a confident degree of accuracy

  • Actual numbers have yet to be negotiated with the

county

slide-29
SLIDE 29

Village of Clinton

Sanitary Sewer Collection Study Meeting #5 – November 15th, 2016

Provided Engineer’s recommendation for System Type, Assessment Method and Project Cost Estimate

slide-30
SLIDE 30

Engineer’s Recommendation: Low Pressure Sewer

slide-31
SLIDE 31

Project Cost Estimate

Low Pressure Sewer Vacuum Sewer Construction Cost $6,330,664 $8,671,000 Estimated Design Cost 7% 7% Inspection & Testing 5% 5% Bidding/Legal/Interest 3% 3% AVERAGE OWNER COST $15,500 $18,500

What is included in construction? What is the property owner responsibility?

slide-32
SLIDE 32

TOTAL PROJECT COST PER PROPERTY

slide-33
SLIDE 33
  • GOAL:
  • Affordable
  • Fair & Equitable
  • Two Part Assessment

Criteria

  • 1. Land Value
  • 10% of Land Value (Vacant
  • r Occupied)
  • 2. Connection Cost
  • Connecting to the Public

Sewer

Engineer’s Recommendation:

Assessment

Assessment Cost

A Construction Cost $6,330,664 B Design Cost (7%) $443,147 C County Share (-2%) $135,476 D Assessment Cost A+B-C $6,638,335

Land Value Cost (LVC)

E LVC Rate 10.00% F Total LVC Cost $864,272 G Remaining Cost D - F $5,774,063

Connection Cost

H Total Connection Cost G $5,774,063 I Present Non-exempt Connections 393 J Future Growth Rate (± 3 Homes per Yr) 15% K Future Non-exempt Connections I + J 452 L Unit Connection Cost G ÷ K $12,774 M Present Total Connection cost I * L $5,020,369 N Cost to Present Owners M + F $5,884,641 P Outstanding Balance (County?) D - N $753,694

slide-34
SLIDE 34

What’s Changed?

Primary Area Assessment Cost 475 Future Connections

A Construction Cost (2017 Cost) $6,377,235 B Design Cost $446,406 C Construction Administration (6%) $382,634 D Legal (2%) $127,545 E Assessment Cost $7,333,820

Outside Funding

F Summit County DSSS Contribution $922,869

Land Value Charge (LVC)

G LVC Rate 10.00% H Total LVC Charge $887,306 I Remaining Cost E-F-H $5,523,645

Tap Charge

J Total Tap Charge I $5,523,645 K Present Non-exempt Taps 407 L Future Growth Rate (20Yr) 17% M Future Non-exempt Taps K + L 475 N Unit Tap-in Charge J ÷ M $11,628.73

slide-35
SLIDE 35

PROJECT COSTS

2017 DOLLARS SHOWN ADD +/- 3%/YEAR FOR INFLATION. $7,333,820 TOTAL COSTS $ (922,869) COUNTY FUNDING $6,410,951 TOTAL ASSESSED $6,410,951 TOTAL ASSESSED $ (887,306) 10% LAND VALUE $5,523,645 TOTAL TAP CHARGE @ 475 CONNECTIONS (TAPS) $ 11,629 PER CONNECTION $ LAND VALUE CHARGE (10%) $ SEE MAP TOTAL TAP CHARGE INTERACTIVE GIS MAP http://arcg.is/0my8ay

FACT SHEET

PROJECT SCHEDULE

2017 PUBLIC MEETINGS @ VILLAGE 2018 VILLAGE & COUNTY LEGISLATION 2018 ENGINEERING DESIGN 2019 CONSTRUCTION 2020 CONSTRUCTION 2021 ASSESSMENT TO TAXES (20 YRS)

CONNECTION SCHEDULE

2020 - 2022 VOLUNTARY CONNECTIONS 2023 HEALTH DEPT INSPECTIONS 2025 MANDATORY CONNECTIONS VOLUNTARY CONNECTIONS WILL BE ABLE TO ASSESS PRIVATE CONNECTION COSTS TO THEIR TAXES – PAYABLE OVER 10 YEARS. HEALTH DEPT INSPECTIONS WILL ALLOW GOOD WORKING HSTS TO REMAIN.
