LBNF Long-Baseline Neutrino Facility SURF Space Availability Joshua Willhite LBNF Far Site Conventional Facilities Project Manager 14 December 2017 2 LBNF Lead Area 3 LBNF Access 4 LBNF General Areas 5 LBNF Ross Complex 6 LBNF


slide-1
SLIDE 1

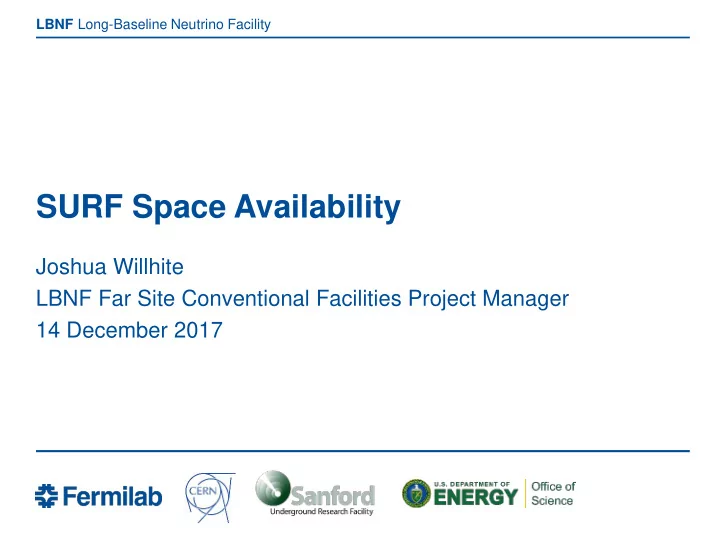

Long-Baseline Neutrino Facility LBNF

SURF Space Availability

Joshua Willhite LBNF Far Site Conventional Facilities Project Manager 14 December 2017

slide-2
SLIDE 2

LBNF 2

slide-3
SLIDE 3

LBNF

Lead Area

3

slide-4
SLIDE 4

LBNF

Access

4

slide-5
SLIDE 5

LBNF

General Areas

5

slide-6
SLIDE 6

LBNF

Ross Complex

6

slide-7
SLIDE 7

LBNF

Ellison and Yates Complex

7

slide-8
SLIDE 8

LBNF

CM/GC Used Space (Admin Parking)

8

slide-9
SLIDE 9

LBNF

CM/GC Used Space (Ross)

9

slide-10
SLIDE 10

LBNF

CM/GC Used Space (Yates)

10

slide-11
SLIDE 11

LBNF

Underground Relationship

11

slide-12
SLIDE 12

LBNF 12

Existing facilities Proposed facilities

Underground

10.24.17 Joshua Willhite | LBNF/DUNE Project Update

slide-13
SLIDE 13

LBNF Spray Chamber

FY20 BSI Scope - Central Utility Cavern Elements

11.1.2017 Joshua Willhite | LBNF FSCF Scope 13

slide-14
SLIDE 14

LBNF

Primary Space Available to DUNE

14

slide-15
SLIDE 15

LBNF

Drift Dimensions

15

(5m) (5.2m) (6m) (1m)

slide-16
SLIDE 16

LBNF

Timeline

16

  • Based on P6 as of today (12/18/17):
  • Chamber 1 is turned over to cryostat December 29, 2021
  • Chamber 2 is turned over January 23, 2022
  • All phase 1 and 2 BSI is done June 2022
  • Chamber 3 and 4 excavation completes May 19, 2023
  • Cryogenics in the CUC begins September 2023
  • currently shown as all four at once
  • Ross Shaft gas piping is done October 2022
slide-17
SLIDE 17

Long-Baseline Neutrino Facility LBNF

Questions?
