South End project Age Agenda 1. Consultation process and outcomes - - PowerPoint PPT Presentation

south end project
SMART_READER_LITE
LIVE PREVIEW

South End project Age Agenda 1. Consultation process and outcomes - - PowerPoint PPT Presentation

South End project Age Agenda 1. Consultation process and outcomes 2. Building fronts General update Timescales 3. Public realm General update Timescales 4. Budget update 5. Social Value (involving local


slide-1
SLIDE 1

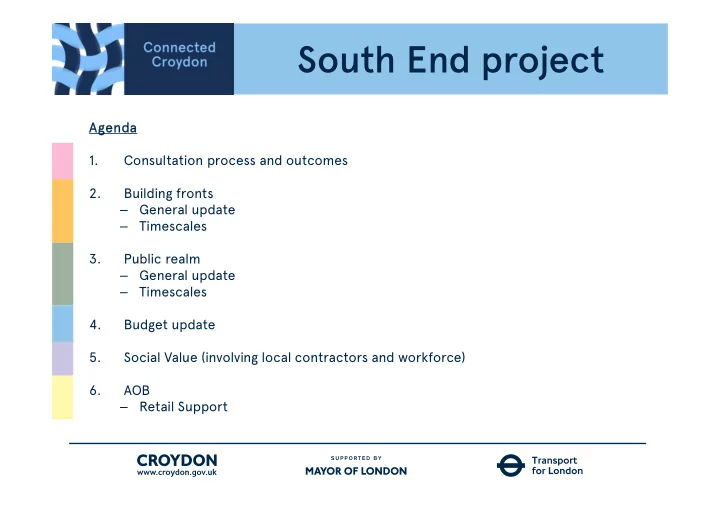

South End project

Age Agenda 1. Consultation process and outcomes 2. Building fronts – General update – Timescales 3. Public realm – General update – Timescales 4. Budget update 5. Social Value (involving local contractors and workforce) 6. AOB – Retail Support

slide-2
SLIDE 2
  • 1. Consultation

Pr Process ess

  • Officers from GLA, LBC and TfL reviewed all comments made

during the public consultation;

  • Comments that would have led to a change of scope, or a

departure from the agreed objectives, were discounted as part of this project (and passed on to relevant departments as appropriate);

  • The rest was used to review and amend if necessary the

proposals;

  • Responses to all comments received were circulated 4th Sep (and

again on 1st Oct 2013).

slide-3
SLIDE 3

Exam ampl ples of

  • f comments and

and r resp spon

  • nse

ses

  • “To calm and reduce, but not eliminate, the flow of traffic through the area. This

would mean redirecting and restricting through traffic to Croydon and other areas.” > Out of scope

  • “We do not believe that the elimination of bus stops from South End is viable.”

> Retain bus stops

  • “The Council should impose a commitment on businesses whose shop fronts are

being improved to on-going maintenance of their properties to prevent future deterioration and reversion to their present run down state.” > The agreements reached with the property owners and businesses for building frontage improvement will include a requirement to retain and maintain the works for a minimum of 5 years (confirms approach undertaken by the council)

  • 1. Consultation
slide-4
SLIDE 4
  • 2. Building fronts

Public ic c cons nsul ultation pro proposals

slide-5
SLIDE 5
  • 2. Building fronts

Work rks ba s batches

slide-6
SLIDE 6

Time imescale ales

  • Finalising design proposals and costing

Oct – December 2013

  • Pre-application discussions

Nov–December 2013

  • Legal agreements with businesses and owners

Dec 2013 -January 2014 _____________________________________________________________________________________TODAY

  • Planning and advertising consent applications

Jan-Feb 2014

  • Tender Preparation

Nov 13 -January 2014

  • 6 companies invited to quote

Early February 2014

  • Tender return

Late February 2014

  • Tender evaluation

March 2011

  • LBC’s approval process (CCB and CSC boards)

April 2014

  • Contractor Appointment and Mobilisation

Apr - May 2014

  • Works to South End

May – July 2014

  • South End Food festival

July 2014

  • Works to Selsdon Road

July to November 2014

  • Construction Works Completion

November 2014

  • 2. Building fronts
slide-7
SLIDE 7
  • 3. Public Realm

Ag Agreed eed s scheme

slide-8
SLIDE 8
  • 3. Public Realm

Time imescale ales

  • Review and fix proposals following consultation

July – August 2013

  • Issue responses to consultation comments

4th Sep and 1st Oct 2013

  • Tender preparation

September - November 2013

  • 6 companies invited to quote

22nd Nov 2013 _____________________________________________________________________________________TODAY

  • Preparation of further information for construction

December 13 – February 14

  • Tender return

20th Dec 2013

  • Tender evaluation

January 2014

  • LBC’s approval process (CCB and CSC boards)

January 2014

  • Contractor Appointment and Mobilisation

February 2014

  • Works to South End

February – July 2014

  • South End food festival

July 2014

  • Works to Selsdon Road

July – November 2014

  • Construction Works Completion

November 2014

slide-9
SLIDE 9
  • 4. Budget update
  • Overall budget September 2012 (GLA, TfL and Croydon

Council’s funding):

– £2.8m – Public realm works: 82.2% – Building fronts: 17.8%

  • Overall budget today

– £3.1m (construction budget 2.5£) – Public realm works: 81.9% – Building fronts: 18.1%

slide-10
SLIDE 10
  • 5. Social Value

Public ic re realm c contractor

  • r pro

procure rement

  • Via the procurement framework: 6 contractors invited to quote
  • 60% of assessment on price, 40% on quality (contractors having already passed a quality

test to be on the framework) “Questi uestion 5 5 ( (5%): Please describe any additional social values that your tender

  • ffers – such as local employment/training opportunities, links with the third

sector and the sourcing of materials and services locally. You should also describe how you intend to evidence that this additional social value has been delivered.” Buil ildi ding fro fronts c contractor

  • r pro

procure rement

  • The council is reviewing possibilities to see if local skills/services can be procured direct.
  • If this is not possible or not sufficient the list will be completed by LBC framework

contractors

  • Part of the assessment will be on what do they do to encourage local workforce (as

above)

  • The South End design team has done a review of local specialists artisans and craftsmen

– this will be appended for info to the tendering document.

slide-11
SLIDE 11
  • 6. AOB

Retail Support

  • South End Activation project:

– 3 units to be activated by April 2014

  • South End free 30min parking

– Spices’ Yard; since November – On street (South End and Selsdon road): from January

  • South End capacity building (business support to local

businesses)
