Public Information Meeting Davis Pressure Plane Expansion Phase 1 - - PowerPoint PPT Presentation

public information meeting
SMART_READER_LITE
LIVE PREVIEW

Public Information Meeting Davis Pressure Plane Expansion Phase 1 - - PowerPoint PPT Presentation

Public Information Meeting Davis Pressure Plane Expansion Phase 1 Project No. WUOP16011 January 31, 2018 Ms. Lana Wolff City of Arlington City Council Member (District 5) (817) 459-6122 Keith Hamby City of Arlington Construction Inspector


slide-1
SLIDE 1

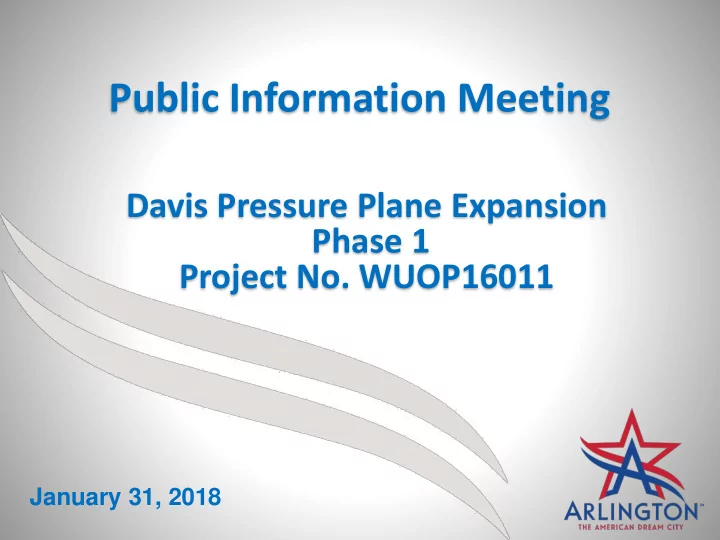

Public Information Meeting

January 31, 2018

Davis Pressure Plane Expansion Phase 1 Project No. WUOP16011

slide-2
SLIDE 2
  • Ms. Lana Wolff

City of Arlington City Council Member (District 5) (817) 459-6122

Keith Hamby

City of Arlington Construction Inspector (817) 459-6550

Preeti Shrestha KC, P.E.

City of Arlington Project Engineer (817) 459-6605 Preeti.KC@arlingtontx.gov

Jay Bell

SYB Construction Co., Inc. 1-800-215-1448

slide-3
SLIDE 3

Water Main 8,530 LF of 8-inch to 12-inch Sanitary Sewer Main 3,430 LF of 8-inch Sidewalk New sidewalk from Fourth Street to Second Street Street Reclamation 23,150 SY TOTAL PROJECT COST $5,425,236

slide-4
SLIDE 4
slide-5
SLIDE 5

1” Water Service

slide-6
SLIDE 6

Temporary Pavement Repair

street with temporary patch after water and sanitary sewer mains and services installed

slide-7
SLIDE 7

Street Reclamation Process

pulverize and mix existing asphalt surface and base with lime and cement, and stabilize to a new 8-inch base

slide-8
SLIDE 8

Street Reclamation Process

pulverize and mix existing asphalt surface and base with lime and cement, and stabilize to a new 8-inch base

slide-9
SLIDE 9

Street Reclamation Process

install 8-inch Hot Mix Asphaltic Concrete (HMAC) for the entire width of the street

slide-10
SLIDE 10

Pavement Stripping

slide-11
SLIDE 11

Construction Schedule

Construction is scheduled to begin February 5, 2018 The anticipated construction time is 375 calendar days http://www.arlingtontx.gov/ waterconstruction/watersewer-projects/

slide-12
SLIDE 12

Questions

  • How long will the water be shut off?

Scheduled water shut off typically takes 4-6 hours. Affected properties will be notified 48 hours prior to the scheduled shut off by the contractor using door hangers.

  • Will there be any disruption to the sewer service?

No sewer disruption is anticipated.

  • Will the contractor restore the grass affected by construction?

Grass areas affected by construction will be restored to match existing condition and will require watering by the property owner after being established. The city inspector will videotape the project area to document existing conditions before the start of construction.

  • Is the driveway still accessible?

Parking in your driveway may be restricted during the installation of pipes and street reclamation process. This will be coordinated with you by the contractor.

  • How to maintain the traffic during construction?

The construction will be in two phases. Park Row Drive to Mitchell Street and Mitchell Street to UTA Blvd. One way traffic will be allowed in only ONE phase at a time. Stabilization and paving will also be performed in two phases. Two way traffic will be maintained on one phase at all times.

  • Will the contractor work on weekends?

May be working on Saturdays, but not on Sundays.

slide-13
SLIDE 13

Thank You!
