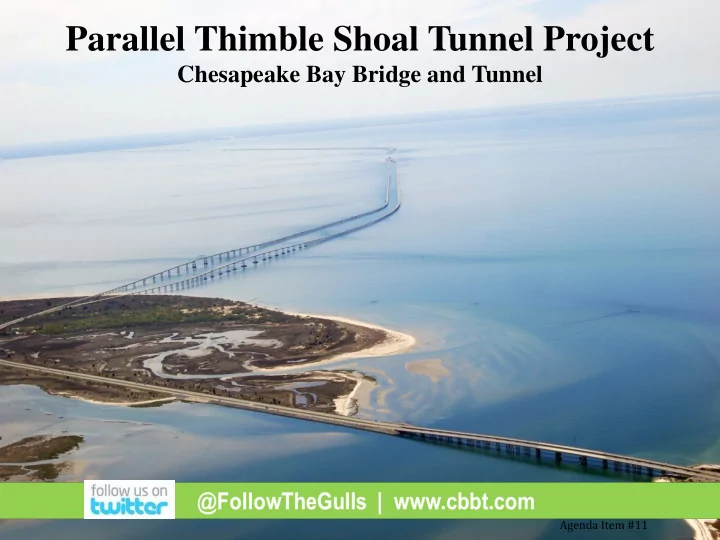

Parallel Thimble Shoal Tunnel Project Chesapeake Bay Bridge and Tunnel Agenda Item #11 Parallel Thimble Shoal Tunnel Project Location Existing Crossover Proposed Parallel #2 Island Thimble Shoal Tunnel (SB Traffic) Existing Thimble Shoal


slide-1
SLIDE 1

Parallel Thimble Shoal Tunnel Project

Chesapeake Bay Bridge and Tunnel

Agenda Item #11

slide-2
SLIDE 2

Existing Crossover #2 Island Existing Thimble Shoal Channel Tunnel (NB Traffic) #1 Island Fishing Pier Proposed Parallel Thimble Shoal Tunnel (SB Traffic) Approximate Edge of Existing Island

Parallel Thimble Shoal Tunnel Project Location

Agenda Item #11

slide-3
SLIDE 3

Scoring

Immersed Tube Tunnel Section 2 - General Qualifications 50 points Section 4 - Immersed Tube Tunnel Qualifications 50 points Total Score: 100 points maximum Bored Tunnel Method Section 2 - General Qualifications 50 points Section 3 - Bored Tunnel Qualifications 50 points Total Score: 100 points maximum

  • Evaluation and scoring independently for each tunneling method.
  • The highest score, regardless of method, for an Offeror used to

determine the short-list

  • Teams able to submit qualifications for both methods
  • Teams that qualified for both methods, only allowed to submit one

Technical and Price Proposal

Agenda Item #11

slide-4
SLIDE 4

Short-Listed Teams

Design-Build Team ITT TBM Archer Western-Vinci Construction (AWVC) X X Bouygues TP / Traylor / Manson (BTM) X X Dragados USA and Schiavone Construction (CTJV) X Skanska, Kiewit, Weeks (SKW) X

  • Draft DB ATC RFP founded on VA’s P.P.T.A. issued August 11, 2015
  • Final RFP issued February 1, 2016
  • Preliminary Technical Proposals submitted March 1, 2016
  • Final Tech. and Price Proposals submitted April 29, 2016
  • Revised Technical Proposals submitted July 12, 2016
  • Revised Price Proposals submitted July 15, 2016
  • Award to CTJV on July 27, 2016 for $ 755,987,318

Agenda Item #11

slide-5
SLIDE 5

Rotating cutter head The machine is operated from the control room Pressure is maintained in the cutting chamber Rotating arm adds pre-cast concrete Tunnel segments to form a ring Pre-cast concrete segments delivered to rotating arm Excavated earth removed by conveyor belt Hydraulic rams push against newly-placed concrete segments to drive machine forward Approximate TBM diameter is 42’

Tunnel Boring ng Machine

Agenda Item #11

slide-6
SLIDE 6

Proj

  • jec

ect T Timel eline

Agenda Item #11

slide-7
SLIDE 7

Project Funding

Source Allocation CBBT General Fund $ 172,643,799 CBBT Revenue Bonds 363,618,253 USDOT TIFIA Loan 338,528,672 VTIB Loan 50,000,000 Total Cost w/Contingency $ 924,790,724

Agenda Item #11

slide-8
SLIDE 8

PARALLEL THIMBLE SHOAL CHANNEL TUNNEL

For up-to-date information, news releases, project documents, and more as it pertains to the Parallel Thimble Shoal Channel Tunnel Project, please visit the CBBT’s website at www.cbbt.com/parallelthimbleshoaltunnel/
