Nevada DOT has started the Risk Management journey Learning - - PowerPoint PPT Presentation

nevada dot has started the risk management journey
SMART_READER_LITE
LIVE PREVIEW

Nevada DOT has started the Risk Management journey Learning - - PowerPoint PPT Presentation

Nevada DOT has started the Risk Management journey Learning Deliver mechanisms Full Value Establish process of RM requirements Learn from results of initial applications Plan/execute appropriate Continuously decision


slide-1
SLIDE 1

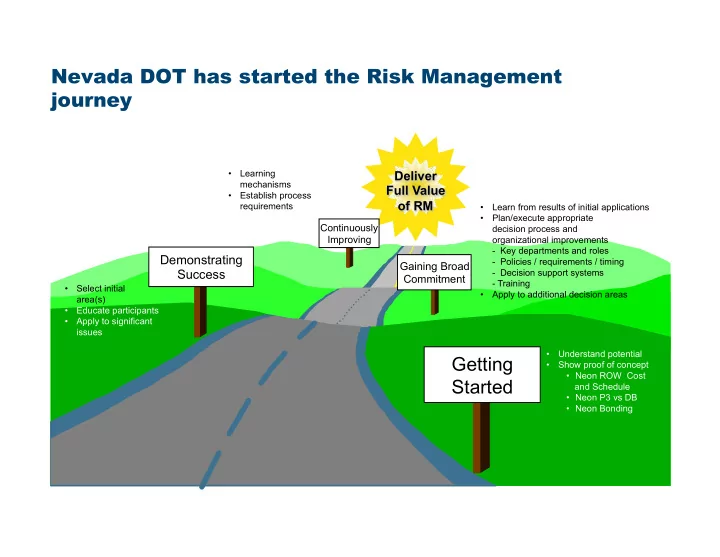

Nevada DOT has started the Risk Management journey

Getting Started

Demonstrating Success

Gaining Broad Commitment

Continuously Improving

  • Understand potential
  • Show proof of concept
  • Neon ROW Cost

and Schedule

  • Neon P3 vs DB
  • Neon Bonding
  • Select initial

area(s)

  • Educate participants
  • Apply to significant

issues

  • Learn from results of initial applications
  • Plan/execute appropriate

decision process and

  • rganizational improvements
  • Key departments and roles
  • Policies / requirements / timing
  • Decision support systems
  • Training
  • Apply to additional decision areas
  • Learning

mechanisms

  • Establish process

requirements

Deliver Full Value

  • f RM
slide-2
SLIDE 2

Nevada DOT’s 3 initial Risk Management applications.

  • Project NEON ROW Cost and Schedule Risk

– What is the ROW acquisition and relocation schedule risk (including legal risks)? – What is the ROW acquisition and relocation cost risk and cash flow implications (including legal risks)?

  • Project NEON P3 vs. DB Decision

– What are the ROW schedule implications to P3 vs. DB? – What are the cost implications of P3 vs. DB? – Which delivery method is more advantageous to NDOT on a risk-adjusted basis?

  • Project NEON Bonding

– How would bonding impact the total cost and cash flow risk of Project NEON?

slide-3
SLIDE 3

Nevada DOT’s Risk Management program will include 4 primary elements

  • Corporate / Enterprise Risk Strategy

– Level 1: Corporate – Level 2: Functions / Departments – Level 3: Projects / Operations

  • Project NEON

– ROW Cost and Schedule (Bayesian) Update – ROW / Legal Risk Inputs to Decision Lens Tracking Model – ROW Cash Flow over Time Profiles – Inter-Department Support / Risk Monitoring (ROW, Legal, Finance)

  • 5-Year Capital Plan

– ERM Inputs to Decision Lens Capital Plan – Global Risk Assessment – Financial Plan Project Reviews

  • Risk Training & Knowledge Transfer

– Policies, Roles and Responsibilities – Training and Reference Materials – Training Courses

slide-4
SLIDE 4

The ERM program will be delivered over a two-year period and includes strategy, additional applications, and training.

PROJECT NEON Corporate Support/Global Risk Assessments Training and Reference Materials ROW / Legal Risk Inputs to Tracking Model Policies, Roles and Responsibilities ROW Cost and Schedule Bayesian Update RISK TRAINING State Fiscal Quarter Program Element Financial Plan Review Training Courses FY2015 FY2016 Q3 Q4 Q1 Q2 Q3 Q4 Q1 Q2 FY2017 ROW Cash Flow Profiles 5-YEAR CAPITAL PLAN ENTERPRISE RISK STRATEGY Functions / Departments Corporate Projects / Operations Inter-Department Support / Risk Monitoring ERM Inputs to Decision Lens Capital Plan

slide-5
SLIDE 5

Nevada DOT’s Safety program

  • Critical Emphasis Areas in Strategic Highway Safety Program

– Lane Departure – Intersections – Impaired Driving – Seat Belts – Pedestrians – Motorcycles

  • Data Driven Process
  • Road Safety Assessments / Safety Management Plans
  • Highway Safety Manual Implementation
  • Commitment of $10 M in State Funds for Pedestrian Safety
