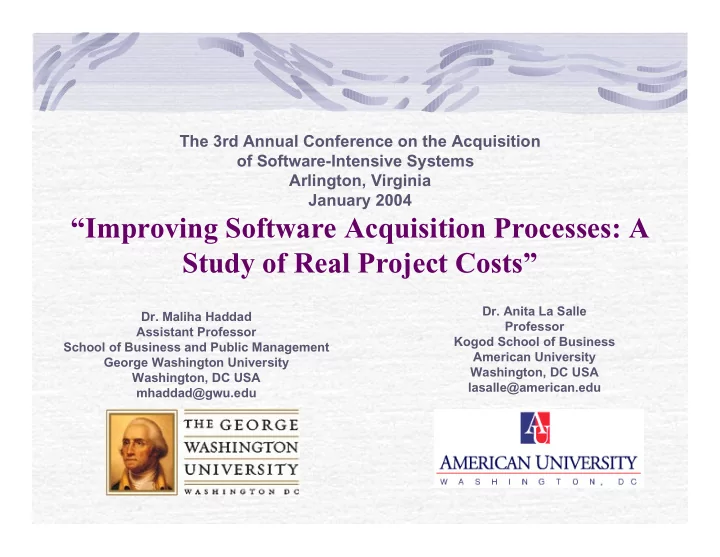

Improving Software Acquisition Processes: A Study of Real Project - - PowerPoint PPT Presentation

improving software acquisition processes a study of real
SMART_READER_LITE
LIVE PREVIEW

Improving Software Acquisition Processes: A Study of Real Project - - PowerPoint PPT Presentation

The 3rd Annual Conference on the Acquisition of Software-Intensive Systems Arlington, Virginia January 2004 Improving Software Acquisition Processes: A Study of Real Project Costs Dr. Anita La Salle Dr. Maliha Haddad Professor


slide-1
SLIDE 1
  • Dr. Maliha Haddad

Assistant Professor School of Business and Public Management George Washington University Washington, DC USA mhaddad@gwu.edu

  • Dr. Anita La Salle

Professor Kogod School of Business American University Washington, DC USA lasalle@american.edu

The 3rd Annual Conference on the Acquisition

  • f Software-Intensive Systems

Arlington, Virginia January 2004

“Improving Software Acquisition Processes: A Study of Real Project Costs”

slide-2
SLIDE 2

3rd Annual Conference - Acquisition of Software Intensive Systems -- January 2004 -- Haddad and La Salle 2

§ Real and Hidden Costs in Software

Acquisition

  • Software Acquisition Issues
  • Research Background
  • Research Results
  • Impact of the Hidden Cost

§ Conclusions

Outline

slide-3
SLIDE 3

3rd Annual Conference - Acquisition of Software Intensive Systems -- January 2004 -- Haddad and La Salle 3

Organization is sole developer (In- House Projects) Organization is sole developer (In- House Projects) Role of Organizations re Software Projects Role of Organizations re Software Projects Organization contracts for software (Out- House Projects) Organization contracts for software (Out- House Projects) Organization is prime, with one

  • r more

external sub- contractors Organization is prime, with one

  • r more

external sub- contractors

Domain of interest

Role of Organizations and Software Projects

slide-4
SLIDE 4

3rd Annual Conference - Acquisition of Software Intensive Systems -- January 2004 -- Haddad and La Salle 4

“A major problem that has been recognized in acquisition of software intensive systems is management

  • practices. The problem is characterized as continued

failure of large software intensive acquisition and development efforts to meet cost, schedule, and/or performance goals. An immature acquisition

  • rganization can doom a software intensive project to

failure as surely as an immature software development

  • rganization.”

From the SEI Web Site

Software Acquisition Issues

slide-5
SLIDE 5

3rd Annual Conference - Acquisition of Software Intensive Systems -- January 2004 -- Haddad and La Salle 5

Software Cost Estimation Issues

Rationale for Cost Estimation

  • Cost estimation supports the planning and control

functions of project management:

Develop Project’s schedule Budget Allocate personnel and resources

  • Cost Estimation is needed in economic analysis to

support strategic decisions for software acquisition or development.

slide-6
SLIDE 6

3rd Annual Conference - Acquisition of Software Intensive Systems -- January 2004 -- Haddad and La Salle 6

Software Cost Estimation Issues

Problems in Current Estimation Methods and Tools

  • Focus primarily on the technical resources needed for

developing the software product.

  • Do not produce estimates for and do not take into

consideration the cost of the contracting organization cost i.e. the “hidden cost”

slide-7
SLIDE 7

3rd Annual Conference - Acquisition of Software Intensive Systems -- January 2004 -- Haddad and La Salle 7

Software Acquisition Issues

Examples of costs incurred by a Contracting Organization:

  • milestone reviews
  • testing activities
  • quality assurance oversight
  • travel
  • user training

“hidden costs” RISKS

  • user and management

time and effort before and during acquisition

  • hardware & software

resources to manage the acquisition

  • cost of domain experts
slide-8
SLIDE 8

3rd Annual Conference - Acquisition of Software Intensive Systems -- January 2004 -- Haddad and La Salle 8

Research Background: Acquisition and Estimation Process Improvement Goal

  • Point out the need for improvements in software cost

estimation processes for a contracting organization

  • Point out the need to improve the acquisition processes by

planning the needed contracting organization resources and making them available when needed

  • Contribute to the refinement of the available software

estimation models by examining the contracting organization user and management costs i.e the hidden cost which is

  • rdinarily not factored into such models
  • Encourage a quantitative approach in collecting acquisition

costs within an organization so that databases of completed projects can be used to forecast costs for future projects.

slide-9
SLIDE 9

3rd Annual Conference - Acquisition of Software Intensive Systems -- January 2004 -- Haddad and La Salle 9

Research Background: The Big Questions

  • Do contracting organisations have formal

processes for the estimation of their resources involved in contracted software projects?

  • Are there costs incurred by such organisations

that are not accounted for in the project budget that can be considered hidden?

  • What is the magnitude of such a cost? Can it be

modelled?

  • Is this cost included in any economic analysis or

feasibility of the project?

slide-10
SLIDE 10

3rd Annual Conference - Acquisition of Software Intensive Systems -- January 2004 -- Haddad and La Salle 10

Research Background Approach: Using the SA-CMM Processes

  • SA-CMM, a product of Collaboration between Carnegie Mellon’s Software

Engineering Institute and the Department of Defense

  • SA-CMM is a capability maturity model for acquisition organizations that

acquire or procure software-intensive systems.

  • A framework that provides acquisition organizations with guidance on how to

gain control of their software acquisition processes

  • The framework describes the key elements of an effective software acquisition

process … and … an evolutionary improvement path for acquisition

  • rganizations from an ad hoc, immature process to a mature disciplined one.
  • The goal:

Improve the acquisition processes for software intensive systems

set senior management goals for improvement

enable prediction of potential acquisition process performance

slide-11
SLIDE 11

3rd Annual Conference - Acquisition of Software Intensive Systems -- January 2004 -- Haddad and La Salle 11

Transition to Support . Evaluation . Contract Tracking and Oversight . Project Management . Requirements Development and Mgt . Solicitation . Software Acquisition Planning Basic project management 2 Repeatable Competent people and heroics 1 Initial . Acquisition Innovation Management . Continuous Process Improvement Continuous process improvement 5 Optimizing

. Quantitative Acquisition Management

. Quantitative Process Management Quantitative management 4 Quantitative . Training Program . Acquisition Risk Management . Contract Performance Management . Project Performance Management . User Requirements . Process Definition and Maintenance Process standardization 3 Defined Key Process Areas Focus

Level

Research Background Approach: Using the SA-CMM Processes

The SA-CMM Framework

slide-12
SLIDE 12

3rd Annual Conference - Acquisition of Software Intensive Systems -- January 2004 -- Haddad and La Salle 12

Research Background

Highlights of Respondents/Projects:

  • Broad range of companies and

government agencies

  • 26 different projects studied
  • Contracts ranged from $30K to $50M
  • Respondents understood all aspects of

the contracted project

slide-13
SLIDE 13

3rd Annual Conference - Acquisition of Software Intensive Systems -- January 2004 -- Haddad and La Salle 13

Research Results

  • Faulty Estimation Processes -- majority of

contracting orgs.:

  • Do not estimate resources for oversight of contracts

(88%)

  • Do not have formal planning processes for scheduling

resources (65%)

  • Do not collect metrics on project resources (81%)
  • Do not include cost of contract oversight in total project

cost (88%)

  • Do not include costs of resources in economic analysis
  • r feasibility studies (75%)
slide-14
SLIDE 14

3rd Annual Conference - Acquisition of Software Intensive Systems -- January 2004 -- Haddad and La Salle 14

Research Results (continued)

  • Distribution of Hidden Costs
  • May exceed total project costs ( in man months)
  • The mean value of the hidden cost for the surveyed

projects was measured at 190% of the development cost.

  • There is a linear relationship between hidden costs

and project size:

M = 2.2 * KLOC + 52 (person months)

  • By phase, the greatest is user and manager

involvement in the systems analysis phase

slide-15
SLIDE 15

3rd Annual Conference - Acquisition of Software Intensive Systems -- January 2004 -- Haddad and La Salle 15

Distribution of the Hidden Cost by Phase and Labor Category

Training Implementation Testing Programming Design Analysis Acquisition

Mean

20 18 16 14 12 10 8 6 4

%

Other Consultants QA Users Management

Me an

60 50 40 30 20 10

%

Hidden Cost Percentage Distribution by Phase Hidden Cost Percentage Distribution by Labor Category

slide-16
SLIDE 16

3rd Annual Conference - Acquisition of Software Intensive Systems -- January 2004 -- Haddad and La Salle 16

Distribution of Hidden Cost (continued)

Distribution of User Resources

U s e r i n T r a i n i n g U s e r i n I m p l e m e n t a t i U s e r i n T e s t i n g U s e r i n P r

  • g

r a m m i n g U s e r i n D e s i g n U s e r i n A n a l y s i s U s e r i n S A

Mean

60 50 40 30 20 10

Distribution of Management Resources

PM in Training PM in Implementation PM in Testing PM in Programming PM in Design PM in Analysis PM in SA

Mean

12 10 8 6 4 2

slide-17
SLIDE 17

3rd Annual Conference - Acquisition of Software Intensive Systems -- January 2004 -- Haddad and La Salle 17

Factor Observation Observed % Impact on Cost Negative 91 Impact on schedule Negative 88 Impact on deliverable quality Negative 82 Impact on final product quality Negative 91 Impact on the Quality of Project Management Negative 91 Impact on contractor/customer relations Negative 93 Impact on user/customer personnel performance and morale Negative 79 Impact on personnel working conditions Negative 85 Impact on stress level Negative 82

Respondents’ Opinion on Impact of Hidden Cost

slide-18
SLIDE 18

3rd Annual Conference - Acquisition of Software Intensive Systems -- January 2004 -- Haddad and La Salle 18

Research Results (continued)

  • Estimation of hidden costs is rarely done
  • Collection of hidden cost metrics is rare
  • Hidden costs are incurred and are

considerable

  • Because they are hidden, they are not

managed

  • Hidden costs imply project risks
slide-19
SLIDE 19

3rd Annual Conference - Acquisition of Software Intensive Systems -- January 2004 -- Haddad and La Salle 19

Risk Categories

Primary Areas of Risks

  • Customer Internal Risk Sources:
  • Inaccurate estimates of effort (time, scope, $)
  • User availability and involvement
  • Specification of customer requirements
  • Risk Sources in the Customer/Contractor Interface
  • Mutually accepted ambiguous contract
  • Ill-defined interfaces
  • Antagonistic interfaces
  • Loosely defined checkpoints
  • Contractor Internal Risk Sources
  • Contractor Internal Risk Sources
slide-20
SLIDE 20

3rd Annual Conference - Acquisition of Software Intensive Systems -- January 2004 -- Haddad and La Salle 20

Success Factors for a Contracted Project

  • A formal, institutionalized, software acquisition project

management process model will require that the

  • rganization plan all aspects of the acquisition

Manage software requirements, Plan resources and availability Track project team and contractor team performance, Manage the project’s cost and schedule baselines, Evaluate the products and services Transition the software to its support organization.

  • Risk management must be integrated into all aspects of the

project; how to identify and manage risks.

The cost and risk impacts of not improving software acquisition processes are substantial.

Future Research: Use of Knowledge Management

Conclusions

slide-21
SLIDE 21

3rd Annual Conference - Acquisition of Software Intensive Systems -- January 2004 -- Haddad and La Salle 21

Some comments from Participants

“Failure to include the oversight cost in original estimates can result in having to forego

  • versight activity to the detriment of the project. It can also result in embarrassment

when the true cost of the project becomes apparent.” “Unbudgeted work by end users, managers and executives that get taken away from the main business become very large on enterprise scale projects.” “I may be a little cynical, but it seems to me that the software estimation methodology most important to use in complex integrated software/hardware systems is whatever the software project manager's management will believe.” “This work is very important. I would like to have a copy of the results when they are available to encourage more organizations to plan for all that is necessary to make a project successful and optimize business resources who have the critical knowledge the business needs to get into their systems.”

slide-22
SLIDE 22

3rd Annual Conference - Acquisition of Software Intensive Systems -- January 2004 -- Haddad and La Salle 22

“Improving Software Acquisition Processes: A Study of Real Project Costs”
