SLIDE 1
I IC CE E

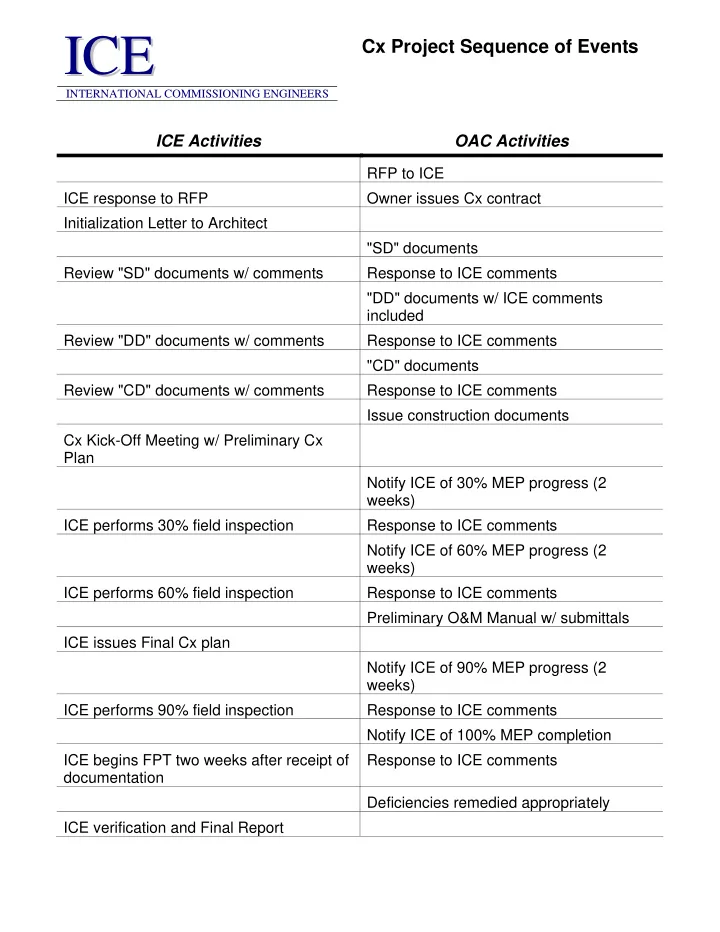

Cx Project Milestones
INTERNATIONAL COMMISSIONING ENGINEERS
- 1. Kick-Off Meeting – Should be no later than the progress meeting prior to the beginning of
MEP rough-in.
- ICE will provide a commissioning process overview for the contractors. The Preliminary
Commissioning Plan will be discussed and distributed.
- 2. 30% MEP Inspection - Installation of MEP systems is approximately 30% complete.
Ductwork is 50% installed with fire/smoke dampers and access doors installed in main
- trunks. DALT is in progress for major high pressure duct sections. No insulation should be
- installed. The CxA and TAB sub-contractor should have a set of approved submittals.
Electrical rough-in should be well underway. Sprinkler bulk mains should be installed.
- ICE will inspect for duct material thickness, MVDs meeting specs and installed
appropriately, square turn elbow turning vanes installed per SMACNA, transition fittings, specified seismic supports, all materials and installed systems are protected against dirt, debris and weather, conduit installed parallel and perpendicular to building lines, etc.
- 3. 60% MEP Inspection - Installation of MEP systems is approximately 60% complete. All
deficiencies from the 30% MEP Inspection have been remedied appropriately with written confirmation to the CxA. Major equipment is in place. Ductwork, piping and electrical rough-ins are 90% complete. Control contractor has presented sample BAS graphics for review. Start-up verification forms are in use to prepare start-up plan. Piping systems pressure tests are complete. Hydronic systems cleaning and flushing plan is in place.
- ICE will inspect for flexible-connectors to HVAC equipment meet spec., flexible ductwork
meets specified length, NEC and other code clearances are met, systems are clean and protected, main electrical cables are specified size with proper terminations, etc.
- 4. 90% MEP Inspection - Installation of MEP systems is approximately 100% complete. All
deficiencies from the 60% MEP Inspection have been remedied appropriately with written confirmation to the CxA. The Architect and Engineers have performed their final inspections with deficiency lists. All equipment start-up is complete with SUV forms signed and delivered to the CxA. Controls are in place and operational with point-to-point verification
- complete. TAB is ready to begin.
- ICE will inspect for equipment start-up and access, Controls completion, TAB readiness
which includes clean filters in all equipment.
- 5. Cx/FPT - Once ICE receives the preliminary TAB report, ICE will require a minimum of
two weeks to schedule FPT.
- ICE will review the TAB report and other documentation for completeness and possible
