I move Article One as shown in the warrant, with the Elementary - - PowerPoint PPT Presentation

i move article one as shown in the warrant with the
SMART_READER_LITE
LIVE PREVIEW

I move Article One as shown in the warrant, with the Elementary - - PowerPoint PPT Presentation

I move Article One as shown in the warrant, with the Elementary School cost changed to $31,458,774 and the Intermediate Elementary School cost changed to $18,448,615, retaining the identical total of $49,904,389 as shown in the warrant.


slide-1
SLIDE 1

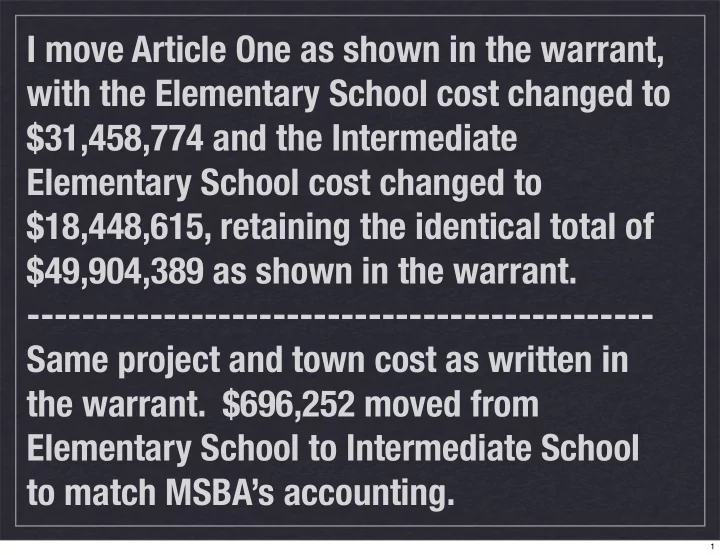

I move Article One as shown in the warrant, with the Elementary School cost changed to $31,458,774 and the Intermediate Elementary School cost changed to $18,448,615, retaining the identical total of $49,904,389 as shown in the warrant.

  • Same project and town cost as written in

the warrant. $696,252 moved from Elementary School to Intermediate School to match MSBA’s accounting.

1

slide-2
SLIDE 2

Special Town Meeting March 28, 2011 Article 1. New Elementary School Construction and Middle School Repair Project

2

slide-3
SLIDE 3

Feasibility Study

In 2008, Town Meeting approved $350,000 for the completion of a feasibility study for the renovation and addition to the Intermediate Elementary School. State pays 53.53% ($187,000) - Goes back to Stabilization Cost to Town: $163,000 Review needs, determine options Determine “Preferred Option” - Least expensive project which meets educational requirements. Primary concern: Cost to Douglas Taxpayers

3

slide-4
SLIDE 4

Grade Structure and Student Overcrowding

Nancy Lane, Superintendent of Schools

4

slide-5
SLIDE 5

Municipal Center Elementary School Intermediate School High School

PreK K 1 2 3 4 5 6 7 8 9 10 11 12 Town Police

5

slide-6
SLIDE 6

Elementary School

All classroom spaces full Special education classes held in room created from storage space Teacher and specialist offices in Library No room for expansion when additional sections of a grade are needed Bathroom capacity: Six stalls for girls, three for boys, nearly 400 students. Lines are frequent. Difficult at this age level. Cafeteria crowded at all three seatings. No space for additional tables

6

slide-7
SLIDE 7

Intermediate School

No available classroom spaces Lunch begins at 10:45 AM - five lunch sessions Small group tutorial spaces required for certain subjects (primarily math); none available Portable classrooms are past usable lifespan. Roofs leaking, very inefficient heating. Limited wireless capacity limiting technology use Improper grade structure Building is 25 years old, so major repairs are expected

7

slide-8
SLIDE 8

Renovation/Addition

Original Project Project cost: $65 Million Cost to Douglas: $30 Million Too expensive! Current classrooms too small (750SF vs 950SF) Not a problem to us, but it is to MSBA

8

slide-9
SLIDE 9

Renovation Repair

Address building needs Don’t address classroom sizes Much less expensive Would MSBA reimburse for this? YES, as long as we didn’t include an addition What about new classrooms?

9

slide-10
SLIDE 10

Addition New Building

Move the addition about 100 feet, call it a new building Which grades go in which building? Intermediate School was Middle/High School, has science labs, perfect 6-8 Middle School New Elementary School less expensive to build than New Middle School New Elementary School: 2-5 Intermediate Middle School: 6-8

10

slide-11
SLIDE 11

11

slide-12
SLIDE 12

Model School Program

Use an existing school as starting point for a new school Sounds simple, but it’s new Certainty in outcome; “bugs” worked out Potential of savings during design and construction 5% additional incentive points ($1.5M) Town must be invited by MSBA to participate MSBA has never invited a town for an Elementary School - UNTIL NOW Modeled on Fort Banks Elementary, Winthrop, MA

12

slide-13
SLIDE 13

Schematic Design

In November 2010, Town Meeting approved $495,000 for the completion of a schematic design for the construction of a new Elementary School and repair of the Intermediate Elementary School. State pays 53.53% ($265,000) - Goes back to Stabilization Cost to Town: $230,000 Identify specific Intermediate School repair items Determine new building layout, exact location Determine costs

13

slide-14
SLIDE 14

EXISTING SITE LAYOUT

ELEMENTARY SCHOOL, INTERMEDIATE ELEMENTARY SCHOOL, MODULARS

14

slide-15
SLIDE 15

NEW SITE LAYOUT

PORTABLES REMOVED, RELOCATE FIELDS, PARKING, ROADWAY IMPROVEMENTS, TRACK PREP

15

slide-16
SLIDE 16

MUSIC 1,278 PRACTICE 123 ART 1,131 178 MEDIA CENTER 3,690 UPPER LEVEL ENTRY WALKWAY ELECTRIC ROOM EMERG GENERATOR WATER PUMP ROOM GENERAL STORAGE ROOM 311 MECHANICAL ROOM CUSTODIAL WORKSHOP & STORAGE 645 RECEIVING 302 CUST OFFICE 163 DRY STORAGE FREEZER COOLER RAMP UP KITCHEN/ SERVICE 1,632 KIT OFFICE TRASH T JC 71 TOILETS 180 ELEV CAFETERIA 4,170 PLATFORM 1,014 STORAGE 244 TOILETS 320 DESK WRKRM HEAD END 286 OFFICE

ST 30

ART STRG NURSE 650 EXAM T STAFF T CONF 240 T.O. 71 PRIN OFFICE 242 WRKRM GUID STRG 52 ADMIN 377 STAFF LUNCH/ WORK ROOM 295 TITLE 1 OFFICE 190 ENTRY STAIR RAMP UP RAMP UP ENTRY STAIR DT EL

REC ST 52

ENTRY STAIR STAIRS UP GUID OFFICE 132 GUID OFFICE 132 SPARE OFFICE 132

NEW ELEMENTARY SCHOOL

FIRST FLOOR

16

slide-17
SLIDE 17

NEW ELEMENTARY SCHOOL

SECOND FLOOR (THIRD FLOOR SIMILAR)

17

slide-18
SLIDE 18

Intermediate Elementary School Conditions

Scott Yacino, Chair, School Committee

18

slide-19
SLIDE 19

INTERIOR WATER DAMAGE

SCIENCE LAB - CEILING AND FLOOR

19

slide-20
SLIDE 20

HVAC (HEATING/VENTILATION/AIR CONDITIONING)

SIGNIFICANT EXTERIOR CORROSION, HEATING UNIT AGING, EXTREMELY INEFFICIENT

20

slide-21
SLIDE 21

FRONT ENTRANCE

RUST DUE TO WATER FLOW TOWARD BUILDING

21

slide-22
SLIDE 22

The “Do Nothing” Project

Intermediate School immediate repair costs: $12M, no reimbursement Space needs: Add portables $300,000 each, $8.4M total for 28 No reimbursement Ten-year lifespan Requires code upgrades, cafeteria space Lose more field space

22

slide-23
SLIDE 23

LIBRARY - REMOVE WALLS TO STORAGE AREAS, TECH. ED. ROOM

23

slide-24
SLIDE 24

Reimbursement

Intermediate School Repair: 54.16% No incentive points on repair projects New Elementary School: 62.07% 54.16% Base Rate 5% Model School 2% Green School (LEED Silver) 0.91% Quality Maintenance Program

24

slide-25
SLIDE 25

Total Cost Douglas Cost Intermediate School Repair $16.8 M $7.9 M New Elementary School $28.7 M $11.2 M Subtotal $45.5 M $19.1 M Roadway, Code, Safety, Athletic Fields $4.4 M $4.4 M Total $49.9 M $23.5 M

Total Project Cost

Includes technology, furniture

25

slide-26
SLIDE 26

Cost Per Household

Approximately $538 per household per year Assumptions: $24.0 M bond 4% interest 20 years No housing growth $259,000 assessor house valuation (town average) Reimbursement is immediate (no tax spike)

26

slide-27
SLIDE 27

Other Town Debt

Early Childhood Center, FY2008 School Land Purchase: FY2010, FY2011 Elementary School Cafetorium: FY2011 Fire Station, FY2010, FY2013 Police Station, FY2013 Only others remaining: High School, Sewer Plant

27

slide-28
SLIDE 28

Why Now?

The best time to build is in a down economy Construction bids coming in 10-20% below budget Very low borrowing rates Waiting will require larger project for more students Waiting will cost more due to construction inflation

28

slide-29
SLIDE 29

Project Schedule

Design Development: April-October, 2011 Bids Awarded: December, 2011 New Elementary School Construction Begins: March, 2012 New Elementary School Opens: September, 2013 Intermediate Elementary School Repair Some repairs: Summer, 2012 Majority of repairs: July-December, 2013 Students moved to new Elementary School, one grade in portables Repairs complete: December, 2013, students move back in Fields, road work completed and portables removed: Spring, 2014

29

slide-30
SLIDE 30

Project Approval

Two-Thirds majority tonight Majority at Ballot Vote Tuesday, April 5, 8am-8pm Municipal Center

30

slide-31
SLIDE 31

Recommended By

School Building Committee School Committee Board of Selectmen Finance Committee

31
