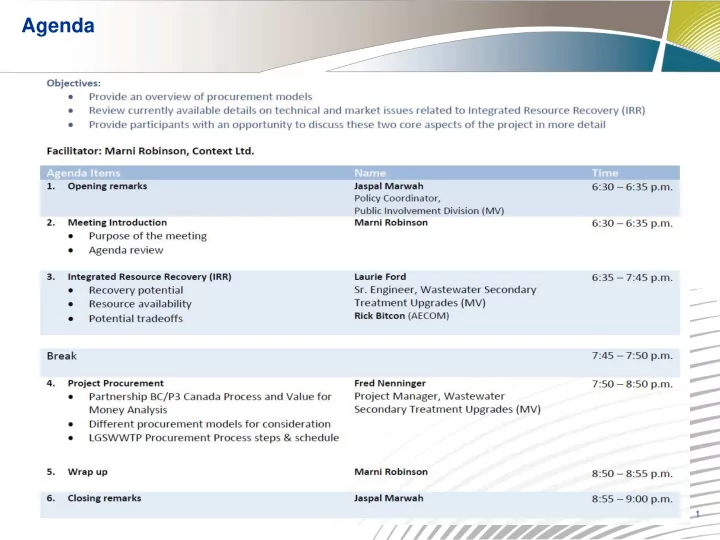

1
Agenda 1 Part 1 Integrated Resource Recovery Integrated Resource - - PowerPoint PPT Presentation
Agenda 1 Part 1 Integrated Resource Recovery Integrated Resource - - PowerPoint PPT Presentation
Agenda 1 Part 1 Integrated Resource Recovery Integrated Resource Recovery Potential Potential Inputs Products 3 4 Feedstock: Food Waste & Yard Waste Food Waste Increased energy generation potential Yard Waste Cellulosic material
Part 1 Integrated Resource Recovery
3
Integrated Resource Recovery Potential Inputs Potential Products
4
5
Feedstock: Food Waste & Yard Waste
Food Waste
Increased energy generation potential
Yard Waste
Cellulosic material doesn’t break down in digestion Limited quantity used for structure
- More solids generated for compost
- r other end use
6
Potential Off-Site Energy Centre
7
High Solids Digestion
7
8
High Solids Digestion (Dry)
8
9
Pictures from Harvest Power, Richmond BC
9
10 10
10
11 11
11
12 12
12
13 13
Low Solids Digestion (Wet)
13
14 14
BTA Pulper and Grit Removal System
14
15 15
Toronto Source Separated Organics Facility 15
16
Biogas Generation Potential
Fuel, electricity and heat potential
Wastewater solids: 270 GJ/d North Shore Food waste/Yard waste: Up to 200 GJ/d
17
Electricity and Heat from Biogas
Electricity and high grade heat potential
Wastewater solids: 108 GJ/d, 1.3 MW Food waste/yard waste: 80 GJ/d, 0.9 MW
Estimated plant electricity demand: ~180 GJ/d Estimated plant heat demand: ~180 GJ/d
18
Biomethane Potential
Remove carbon dioxide, H2O, H2S, siloxanes from biogas Sell as biomethane to natural gas grid Plant electricity, some plant heat purchased
Wastewater solids: 270 GJ/d North Shore Food waste/Yard waste: Up to 200 GJ/d
Total equivalent to natural gas heat for 2,140 homes
19
Low Grade Heat
Use electrical heat pumps to extract heat Wastewater effluent: 2,350 GH/d, 27 MW Existing District Energy System demand: 1-2 MW Potential demand: 3 to 27 MW 27MW would provide heat and hot water for 10,700 homes
Effluent Heat Potential
20
Reclaimed Water
Advanced treatment required for non-potable use Secondary conveyance system required Potential supply: 100 ML/d High industrial water user demand: 3-6 ML/d Estuary enhancement potential Future development potential
Reclaimed Water Potential
21
Nutrient Generation Potential
Liquid stream Biosolids
22
Nutrients from Liquid Stream
Nitrogen, Phosphorus Struvite crystals
- Magnesium ammonium phosphate
- Nuisance formation in piping, digester
- Extract in special reactors
- Sell as slow release fertilizer
Potential generation: up to 230 T/y P Demand: unlimited
23
Nutrients in Solids Stream
Biosolids land application
High nitrogen and phosphorus Other micronutrients
- Generation: ~3500 dry T/y
- Demand: limited
24
Energy from Solids Stream
Organic matter in biosolids has energy value Dried biosolids has ~ 2/3 energy value of low grade coal Evaporation of water requires energy input
Drying Thermal reduction
70-80% water
25
Energy from Biosolids
75% water 10% water 75% water Heat Water
Potential energy available: 500 GJ/d (before digestion) Net energy available after water evaporated: up to 25%
Questions?
Part 2 Introduction to Procurement Models
28
Introduction and Objectives
Background
- Lion’s Gate Secondary Wastewater Treatment Plant (LGWWTP)
- $400 m +
- Currently in Project Definition Phase
- Business plan anticipated (Fall 2013) and Procurement in 2014
- Wastewater treatment plants in Metro Vancouver have been traditionally undertaken
by traditional delivery models
- Metro Vancouver interested in exploring alternate procurement models
Objective
- To establish a base understanding of potential procurement models available to
deliver LGWWTP
29
Partnerships BC – Information
Why will Partnerships BC be involved?
- Any capital project valued > $50 million with Provincial Contribution
P3 business case to be undertaken
- Business case required for provincial funding
Mandate & Information
- Mission is to structure and implement partnership solutions for infrastructure
projects in the public’s interest
- Standalone provincial crown corporation
- 26 projects procured or under construction, 9 announced or under procurement
- Standardized business case processes and procurement document templates
Value for Money Assessment core part of Procurement Model Selection
30
Partnerships BC – Process
A business case needs to be developed to support the development and approval of the process for Provincial Funding. Business Case components include:
- Project Justification (Definition of future requirements)
- Procurement Delivery Options
- Procurement Model Analysis including Multi-Criteria Analysis
- Risk assessment & quantification
- Value for Money Assessment
Final procurement model selected must: 1) Best serve project requirements 2) Demonstrate Value for Money Value for Money assesses the value for risk transferred under each procurement model. Quantification of risk is fundamental to Partnerships BC process
31
Partnerships BC – Value for Money
Value for Money (“VFM”) Process Public Sector Comparator Financial Model (“DBB”) Risk Adjusted Annual Cash Flows to the Public Sector
Capital, operating, lifecycle
Shadow Bid Financial Model (“P3”) Risk Adjusted Annual Cash Flows to the Public Sector
(Including efficiencies) Capital, operating, lifecycle and financing
Short-Listed Procurement Models Risk Assessment Process Value for Money Assessment
32
PPP Canada – Information
PPP Canada involvement
- PPP Canada is Federal Crown Corporation to improve delivery of public
infrastructure by achieving better value, timelines and accountability through P3s
- Manages $1.2 billion P3 Canada Fund; 4 funding rounds to date
- Eligible applicants include: Province, Territory, Municipal or Regional Government,
First Nations, Not-for-Profit
- Eligible infrastructure categories include*: Water and Wastewater , Public Transit,
National Highway, Green Energy, Disaster Mitigation, Solid Waste Mgt
- Access to P3 Canada funding of potentially up to 25% of eligible costs of project if
delivered through P3.
- Business case with Value for Money assessment must be submitted as part of
funding process 20% of funding in P3 Canada Round Three for water & wastewater projects: 1) Sudbury Biosolids 2) Kananaskis Wastewater (Evan Thomas) 3) Capital Regional District – Biosolids Energy Centre
Part 2 Procurement Models
34
Procurement Models
Procurement models include: 1) Traditional Design-Bid-Build (“DBB”) 2) Construction Management at Risk (“CM@R”) 3) Design-Build (“DB”) ■ Progressive ■ Prescriptive ■ Performance ■ Design-Build-Finance (“DBF”) 4) Design-Build-Operate/Maintain (“DBO/M”) 5) Design-Build-Financial-Operate/Maintain (“DBFO/M”)*
Alternative Delivery (“AD”) Models
*Only those with a “Finance” component are generally given priority to P3 Canada Funding
35
Procurement Models
- CM
- DBB
- CM@
R
- Alliance
- DBO
- DBM
- Progressive DB
- Prescriptive DB
- Performance DB
- DBF
- DBFO
- DBFOM
Increasing Risk T ransfer and Private Sector Involvement Value for Money is achieved when the risks are allocated to the party best able to manage the risks
36
Traditional Delivery Model – DBB
Design-Bid-Build Model
- Separate Contracts for design, construction, and operations
- Fully financed by Metro Vancouver – progress payments made to each of the
contractors
Construction Contract Design Contract Metro Vancouver Operations Maintenance Revenue Collection Construction Design
Sub - contractors and suppliers
Separate contracts for design and construction
37
Traditional Delivery Model
Design-Bid-Build Model
Pros Cons
- Control and Oversight over entire
Project
- Public Sector retains all risks of project
- Accepted Model in which MV has
experience
- Separate procurement processes may take
longer
- Cost overruns and schedule risks due to
design flaws
- Contractor has no on-going responsibility
for operations or asset performance
- Schedule risk due to potential lack of
contractor financial incentive
38
Design-Build
- Single contract for design-build under a fixed price
- MV is responsible for operations after substantial completion
- Fully financed by MV – progress payments made to contractor
DB Contract Metro Vancouver Operations Maintenance Revenue Collection Construction Design DB Consortium
Sub - contractors and Suppliers
39
Design-Build
Pros Cons
- DB Contractor assumes design risk
- Schedule risk borne by MV
- Schedule can be accelerated –
construction can commence before design is complete
- Asset performance risk in operations
retained by MV
- Better certainty on price
- Price subject to competition
40
Design-Build-Operate/Maintain
- Single contract for design-build-operate/maintain
- Fully financed by MV
- Progress payments during construction fixed construction price
- Monthly performance-based operating payments fixed operating payments
DBO/ M Contract Maintenance Metro Vancouver DBO/ M Consortium Design Construction Operations Revenue Collection
Sub - contractors and suppliers
41
Design-Build-Operate/Maintain
Pros Cons
- DBO/M Contractor assumes design risk
- Schedule risk borne by MV
- Schedule can be accelerated
- Limited Asset performance guarantee
- Better certainty on price
- Contractor is held more responsible for
asset performance after substantial completion
- Price subject to competition
- Some trade-offs made between up-front
capital and on-going operations Prescriptive DB component more challenging to implement due to risk retention from components prescribed
42
Design-Build-Finance-Operate/Maintain
DBFO/ M Contract Metro Vancouver DBFO/ M Consortium Design Construction Maintenance Revenue Collection
Sub-contractors and Suppliers
Project Finance
- Single contract for design-build-finance-operate/maintain
- Private sector finances (in whole or in part) construction costs – “Skin in the Game”
- MV pays a portion at key milestones and “availability” payments during operations
43
Design-Build-Finance-Operate/Maintain
Pros Cons
- DBFO/M Contractor assumes design risk
- Less direct control by MV
- Schedule can be accelerated
- Private sector financing more expensive
- Better certainty on price
- Less able to prescribe requirements
- "Contractor is held more responsible for
asset performance after substantial completion (more “skin” in the game)
- Price subject to competition
- Optimal trade-offs made between up-front
capital and on-going operations
- Schedule risk borne by DBOM contractor
