Transportation Alternatives Solicitation Kick-off Workshop October - - PowerPoint PPT Presentation

transportation alternatives solicitation kick off workshop
SMART_READER_LITE
LIVE PREVIEW

Transportation Alternatives Solicitation Kick-off Workshop October - - PowerPoint PPT Presentation

Northeast Minnesota Transportation Alternatives Solicitation Kick-off Workshop October 11, 2019 Contents About the Transportation Alternatives (TA) Program How to Apply Transportation Alternatives Project Management Transportation


slide-1
SLIDE 1

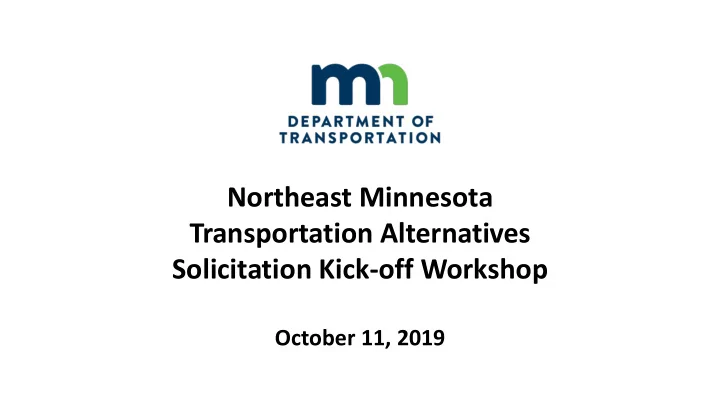

Northeast Minnesota Transportation Alternatives Solicitation Kick-off Workshop

October 11, 2019

slide-2
SLIDE 2

Contents

  • About the Transportation Alternatives (TA) Program
  • How to Apply
  • Transportation Alternatives Project Management
slide-3
SLIDE 3

Transportation Alternatives (TA) Program

What is the TA Program?

  • The TA Program is a competitive grant opportunity for local

communities and regional agencies to fund transportation projects.

  • Minnesota is soliciting projects for $6.2 million in available

grant funding across the state.

slide-4
SLIDE 4

Transportation Alternatives (TA) Program

Qualifying Projects

  • Active Transportation
  • Wayside Rests
  • Community Improvement
  • Environmental Mitigation
  • Safe Routes to School
  • Boulevard Development
slide-5
SLIDE 5

Example Project: Multi-use Trail

slide-6
SLIDE 6

Example Project: Bike Lane

slide-7
SLIDE 7

Example Project: Wayside Rest/Trailhead

slide-8
SLIDE 8

Example Project: SRTS Pedestrian Crossing Median

slide-9
SLIDE 9

Example Project: Sidewalks near Campus

slide-10
SLIDE 10

Example Project: Boulevard Development

slide-11
SLIDE 11

Transportation Alternatives (TA) Program

Non-Qualifying Activities

  • State or metropolitan planning organization administration
  • Promotional activities, except as permitted by SRTS
  • Routine maintenance and operations, except trail

maintenance under the Recreational Trails Program

  • General recreation and parks facilities
  • Engineering activities
  • Purchase of right-of-way
slide-12
SLIDE 12

Transportation Alternatives (TA) Program

Eligible Applicants

  • Local governments
  • Regional transportation authorities
  • Transit agencies
  • Natural resource or public land agencies
  • School districts, local education agencies, or schools (public or private)
  • Tribal governments (federally-recognized)
  • Nonprofit entities responsible for the administration of local

transportation safety programs

  • Any other local or regional governmental entities with responsibility for,
  • r oversight of, transportation or recreational trails
  • Note: To receive federal funds, an applicant must be a state aid city or

county or have a state aid city or county sponsor the project.

slide-13
SLIDE 13

Transportation Alternatives (TA) Program

Funds Available

  • $900,000 for Northeast Minnesota (Aitkin, Carlton, Cook,

Itasca, Koochiching, Lake, Pine, and St. Louis)

  • Applicants may request between $100K and $600K per project

Local Match Requirement

  • 80% federal, 20% state or local

Payment Information

  • Qualifying project expenses will be reimbursed after project

completion in 2024

slide-14
SLIDE 14

Transportation Alternatives (TA) Program

Federal Requirements

  • Davis-Bacon and Copeland Acts: Payment of pre-determined wage is

applicable to all federal-aid construction contracts exceeding $2,000 and to all related subcontracts.

  • ADA Requirements: All Transportation Alternatives projects must

comply with the federal and state handicapped accessibility mandates.

  • Anti-Discrimination Laws: Each sponsoring participant must comply

with applicable federal and state Anti-discrimination laws and be able to demonstrate compliance.

  • Project Supervision: All projects must be under the direct

supervision of a Minnesota Licensed Professional Engineer.

  • Additional Requirements and Specifications: Successful applicants

will be provided with additional information as needed by MnDOT.

slide-15
SLIDE 15

Transportation Alternatives (TA) Program

Questions so far?

slide-16
SLIDE 16

How to Apply

Application

  • General Information
  • Project Budget
  • ATP Project Evaluation
  • Sponsoring Agency Resolution
  • Resolution Agreeing to Maintain Facility
  • Application Checklist
  • Signatures
  • Appendix A: Scoring Criteria
slide-17
SLIDE 17

How to Apply

Scoring Elements

  • Project meets TA program goals [15 points possible, 30%]
  • Project has public support [10 points possible, 20%]
  • Project has high chance for deliverability [25 points

possible, 50%]

slide-18
SLIDE 18

How to Apply

Project Selection Process

  • Projects scored, ranked, and recommended by a 13-

member Task Force appointed by the Northeast Minnesota Area Transportation Partnership (NEMNATP)

  • Projects selected based on Task Force

recommendations by the NEMNATP

slide-19
SLIDE 19

How to Apply

Timeline

  • October 1, 2019 – Solicitation opens
  • October 31, 2019 – Letters of intent due
  • November 18, 2019 – Full applications available
  • January 3, 2020 – Full applications due
  • April 15, 2020 – Award notifications
slide-20
SLIDE 20

How to Apply

Questions about the application or how to apply?

slide-21
SLIDE 21

Contact

Russell Habermann rhabermann@ardc.org 218-529-7552 Solicitation Materials: www.nemnatp.org/ta

slide-22
SLIDE 22

TRANSPORTATION ALTERNATIVES PROJECT MANAGEMENT

CAUTION ROUGH ROAD AHEAD

slide-23
SLIDE 23
  • ------ OH MY GOD -------

MY PROJECT WAS SELECTED

Federal DCP Checklist – State Aid website Federal process requirements

  • Agreements
  • Project Memorandum
  • Right of Way Process

Submittal milestones

slide-24
SLIDE 24

About the funding source, Title 23

  • TA funds come from the federal fuel taxes
  • These are called Title 23 federal funds
  • Projects using these funds must follow all the

federal environmental, design, construction and inspection rules and laws as if this project were a major highway.

  • This is a REIMBURSABLE program – not a

grant!

slide-25
SLIDE 25

WHERE IS MY PROJECT MANAGER?

  • Every project needs a manager
  • Must perform minor miracles
  • Will not be paid with TA funds; TA funds

are for construction only

slide-26
SLIDE 26

STARTING THE PROCESS

  • PROJECT SCOPING
  • ENVIRONMENTAL DOCUMENTS,

PROJECT MEMORANDUM

  • PRELIMINARY PLANS, FINAL MEMO
  • FINAL PLANS, R/W, PROJECT LETTING
  • CONSTRUCTION AND PROJECT FINALS
slide-27
SLIDE 27

PROJECT SCOPING

  • MEET WITH DESIGNERS, PROJECT SPONSORS,

ADJACENT LAND OWNERS, AND ANY PERSON OR AGENCY THAT MAY BE AFFECTED BY YOUR PROJECT

  • HAMMER OUT PROJECT DETAILS, ALIGNMENTS,

COSTS, ETC.

slide-28
SLIDE 28

FEDERAL PROJECT MEMO, YOU HAVE GOT TO BE KIDDING?

  • Social, Economic and Environmental

Impacts

– 4(f), 6(f) land (Parks, Recreation Areas, etc) – National Historic Preservation Act – Endangered Species (Northern Long Eared Bat and tree removal) – Right of Way – Farmland Protection Policy Act – Air Quality

slide-29
SLIDE 29
  • Noise
  • Section 404 Clean Water Act (Corps of

Engineers Permits)

  • Floodplain issues
  • Wetland impacts
  • Water Pollution (MPCA storm water

permits)

  • Public waters (DNR permits)
  • Hazardous Waste Sites
  • Mitigation of Damages
slide-30
SLIDE 30
  • Controversial Issues
  • Aesthetic Values
  • Traffic during construction
  • State Environmental Review (MEQB)
  • Environmental Justice statement
  • Federal Action Determination Statement
slide-31
SLIDE 31

BUT WAIT, THERE’S MORE! PROJECT FINAL DESIGN

  • Design Standards
  • Plans and Specifications,

what’s eligible for federal participation?

  • Getting Right of Way –

typically can drive project timeline – needs to be done prior to authorization

  • Deadlines: December 1 –

for PM and April 1 for plans

slide-32
SLIDE 32
  • Plan Submittal
  • R/W certificate
  • Utility Certificate
  • Estimates
  • Bid Letting
  • Award
  • Construction

(Supervised by Professional Engineer or Certified Inspector)

slide-33
SLIDE 33

SHOW ME THE MONEY

  • Who is your Agency?
  • Agency Agreement/Responsibilities
  • Agency may want your share (the 20% match) up front
  • Agency writes the checks

SHARP CURVE AHEAD

slide-34
SLIDE 34

WHEN SHOULD I START?

  • You may already be behind schedule
  • Early contact with public, state and

federal agencies important

  • Right of way issues – condemnation

can skew timeline

  • The DCP checklist outlines major

steps in the process.

slide-35
SLIDE 35

HOW LONG DOES THIS TAKE?

  • Project Memorandum and Documents- 6

months

  • Plans and Specifications and Approvals -

6 months

  • Right of Way – condemnation up to 8

months

  • Certificates, Permits, Authorization,

Letting and Award - 3 months

  • Construction begins
slide-36
SLIDE 36

WILL THIS EVER END? Maybe

  • Final Project Inspection
  • Certification of Materials
  • Final Payment to Contractor
slide-37
SLIDE 37

But it’ll be worth it…..

slide-38
SLIDE 38

WHERE CAN I GET SOME HELP?

  • Your Agency Sponsor
  • John McDonald

– District State Aid Engineer – MnDOT – 1123 Mesaba Ave. – Duluth, MN 55811 – (218) 725-2705

  • Project Details, Design Standards, Project

Documentation, or just about anything

slide-39
SLIDE 39
  • State Aid website
  • State Aid Special Projects Coordinator,

Lynnette Roshell, 651-366-3822

slide-40
SLIDE 40

THANK YOU and GOOD LUCK!!!
