Sentinel Mine & Enterprise Project Analyst presentation October - - PowerPoint PPT Presentation

sentinel mine enterprise project
SMART_READER_LITE
LIVE PREVIEW

Sentinel Mine & Enterprise Project Analyst presentation October - - PowerPoint PPT Presentation

Sentinel Mine & Enterprise Project Analyst presentation October 2015 1 Trident Project location 2 Orientation project layout YOU ARE HERE 3 Sentinel Mine 4 Total Sentinel capex $2.1billion Total Sentinel capex = approx


slide-1
SLIDE 1

Analyst presentation – October 2015

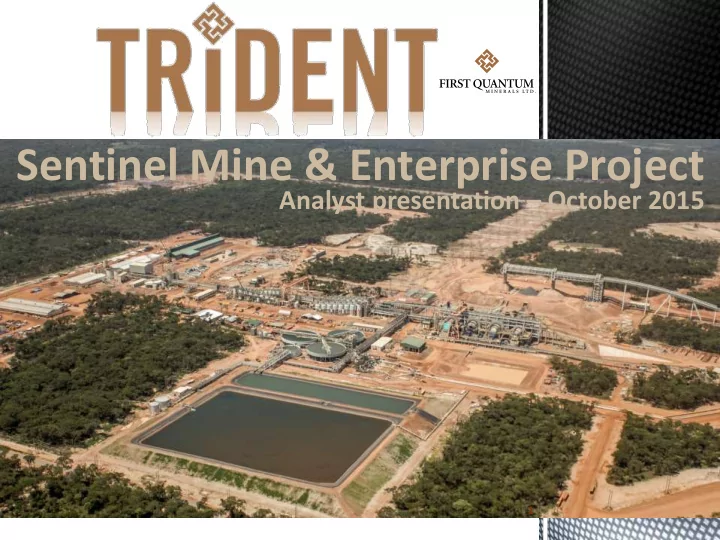

Sentinel Mine & Enterprise Project

1

slide-2
SLIDE 2

Trident Project location

2

slide-3
SLIDE 3

Orientation – project layout

3

YOU ARE HERE

slide-4
SLIDE 4

Sentinel Mine

4

slide-5
SLIDE 5

Project scope:

  • 55Mtpa target throughput;
  • 3 semi mobile in pit crushers;
  • 100MW SAG/Ball milling;
  • 265,000t of freight = 14,500 truckloads;
  • 2 rivers diverted;
  • Life of mine TSF;
  • 600km of ZESCO 330kV transmission lines;
  • 930 staff plus 630 resettlement houses;
  • New town, clinic, 3 schools & airport.

Total Sentinel capex – $2.1billion

Total Sentinel capex = approx $7,500/t

  • f annualised Cu production

5 PROJECT ACQUISITION – FEBRUARY 2010 FIRST ROUGH CONCENTRATE – DECEMBER 2014

slide-6
SLIDE 6

Sentinel Operations

6

slide-7
SLIDE 7

Resource statement published March 2012:

  • Total measured & indicated resource : 1,027Mt @ 0.51% Cu
  • Mineral reserve: 774 Mt @ 0.50% Cu
  • Strip ratio 2.2 : 1

Operations:

  • Up to 55mtpa to achieve economies of scale (overcome low grade);
  • 280,000 – 300,000t Cu production per annum.

Sentinel – mine planning

7

Cost efficient production depends on high volume throughput

slide-8
SLIDE 8

Status:

  • Train 1 = crushing, milling + flotation operating (above design throughput for periods);
  • Train 2 = milling + flotation operating;
  • Concentrate optimisation = Concentrate deslime operating;
  • Slow ramp up to date = Transitional ore metallurgy + power transmission limits.

Milestones:

  • Presidential opening = 28 Aug 2015;
  • Crusher 2 walked into southern boxcut = 2 Sep 2015;
  • Lusaka West transmission lines complete = 12 Sep 2015, awaiting energisation.

Production rampup:

  • Power transmission + crushing for full operations end-Oct 2015;
  • Recovery optimisation = SAG + Ball frontend deslime operations end-Nov 2015;
  • Commercial production by end of 2015.

Sentinel – production rampup

8

slide-9
SLIDE 9

1 2 3 4 5 200,000 400,000 600,000 800,000 1,000,000 1,200,000 1,400,000 1,600,000 Jun-12 Jun-13 Jun-14 Jun-15

Monthly manhours + Lost Time Incidents

9

37.8 million man-hours to date 11 total LTI’s to date

Total 2012 2013 2014 Jan-15 Feb-15 Mar-15 Apr-15 May-15 Jun-15 Jul-15 Aug-15 Manhours (million) 37.8 2.3 10.8 15.2 1.1 1.1 1.2 1.3 1.3 1.3 1.1 1.1 LTI Rate 0.058 0.087 0.061 0.049 0.048 0.046 0.057 0.055 0.064 0.062 0.060 0.058 Severity 4.09 5.04 1.51 1.03 0.99 0.96 4.76 4.58 4.51 4.34 4.21 4.09

Sentinel – safety performance

slide-10
SLIDE 10

SE Ramp NE Ramp Crusher 1a & 2a Crusher 3a Temp ramp Conveyor & Access Ramp Main Waste Ramp 5 Yr Pit Limit Current Mining Face

Mine: Staging

10

slide-11
SLIDE 11

SE Ramp NE Ramp Crusher 1a & 2a Crusher 3a Temp ramp Conveyor & Access Ramp Main Waste Ramp 5 Yr Pit Limit Current Mining Face

Mine: Staging

11

slide-12
SLIDE 12

SE Ramp NE Ramp Crusher 1a & 2a Crusher 3a Temp ramp Conveyor & Access Ramp Main Waste Ramp 5 Yr Pit Limit ‘15 Wet Weather Sumps

Mine: Staging

12

slide-13
SLIDE 13

SE Ramp NE Ramp Crusher 1a & 2a Crusher 3a Temp ramp Conveyor & Access Ramp Main Waste Ramp 5 Yr Pit Limit SE Boxcut Sump

Mining Horizon as at End 2016

Mine: Staging

13

slide-14
SLIDE 14

Progressing to 60 million BCM/annum

14 Mining – main fleet Units ThyssenKrupp 63-89 in pit crushers 3 Caterpillar MD6640 drills 7 CAT 7495HR rope shovels 3 Komatsu PC5500 face shovels 2 Komatsu PC5500 excavator 1 Komatsu 960E trucks (330 tonne) 15 Komatsu 860E trucks (250 tonne) 15 Komatsu HD1500 trucks (150 tonne) 10

  • 1,000,000

2,000,000 3,000,000 4,000,000 5,000,000 6,000,000 7,000,000 Jan-15 Mar-15 May-15 Jul-15 Sep-15 Nov-15 Jan-16 Mar-16 May-16 Jul-16 Sep-16 Nov-16 BCMS Mined

Mining Production Volumes

Act Ore BCM Act Waste BCM Fcst Ore BCM Fcst Waste BCM

Consistency improvements and production rampup:

  • Drill = Soft ground to date. Focus on training and consumable trials;
  • Blast = Fragmentation improved via blast design, product densities + initiation;
  • Load = Increased bench heights at deeper RLs. Moving to double side loading;
  • Haul = Operator recruitment resolved. Mine dispatch in place;
  • Overall = Productivity focus from planning, SIC, training, supervision + maintenance.
slide-15
SLIDE 15

Plant: periods above design throughput

15

Consistency improvements and production rampup:

  • Crushing = Conveying improvements, process debottlenecking + fragmentation.
  • Milling = More consistent power supply, commissioning punch list, upgraded wear

components + improved crushing.

  • Pebble + Secondary crush = now being commissioned.

1000 2000 3000 4000 5000 20000 40000 60000 80000 100000 1-Jan-15 14-Jan-15 27-Jan-15 9-Feb-15 22-Feb-15 7-Mar-15 20-Mar-15 2-Apr-15 15-Apr-15 28-Apr-15 11-May-15 24-May-15 6-Jun-15 19-Jun-15 2-Jul-15 15-Jul-15 28-Jul-15 10-Aug-15 23-Aug-15 5-Sep-15 18-Sep-15 tones / hour Tonnes

Crushing – Daily Volumes

Crushing dry t Crushing dry t/h 1000 2000 3000 4000 5000 20000 40000 60000 80000 100000 1-Jan-15 14-Jan-15 27-Jan-15 9-Feb-15 22-Feb-15 7-Mar-15 20-Mar-15 2-Apr-15 15-Apr-15 28-Apr-15 11-May-15 24-May-15 6-Jun-15 19-Jun-15 2-Jul-15 15-Jul-15 28-Jul-15 10-Aug-15 23-Aug-15 5-Sep-15 18-Sep-15 tones / hour Tonnes

Milling – Daily Volumes

Milling dry t Milling dry t/h

slide-16
SLIDE 16

Concentrate production + feed to smelter

16

20 40 60 80 100 0.0 1.0 2.0 3.0

Cu Rec - OSS

20 40 60 80 100 0.0 1.0 2.0 3.0

Cu Rec - OCC

20 40 60 80 100 0.0 1.0 2.0 3.0

Cu Rec - Primary

Consistency improvements and production rampup:

  • Automation = Smart system focus on floatcams, OSA, PSI, laboratory etc;
  • Concentrate = Backend deslime operating;
  • Recovery optimisation = SAG + Ball frontend deslime operations end-Nov 2015;
  • Overall = Productivity from training, supervision + maintenance.

Cu grade (%) Cu grade (%) Cu grade (%) 0.00 5.00 10.00 15.00 20.00 25.00 30.00 200 400 600 800 1000 1200 1400 1600 1800 1-Jan-15 14-Jan-15 27-Jan-15 9-Feb-15 22-Feb-15 7-Mar-15 20-Mar-15 2-Apr-15 15-Apr-15 28-Apr-15 11-May-15 24-May-15 6-Jun-15 19-Jun-15 2-Jul-15 15-Jul-15 28-Jul-15 10-Aug-15 23-Aug-15 5-Sep-15 18-Sep-15 tonnes / hour

Concentrate – Daily Volumes

Conc ton Conc grade Cu %

slide-17
SLIDE 17

Operations workforce

17

  • Focus now on productivity and efficiency.
  • Current site workforce of 5,698 will reduce with project demobilisation over

next 2 months.

STEADY-STATE WORKFORCE Total Operations staff currently onsite 1,247 In recruitment 541 Approved operations positions 1,788 Ongoing indirect and contractor personnel 1,276 TOTAL 3,064

1,247 184 408 827 1,667 1,365 CURRENT OPERATIONS FOUNDATION & TOWN FQMO (ROADS) OPERATIONS CONTRACTORS CONSTRUCTION PROJECT PROJECT CONTRACTORS Total currently onsite = 5,698

slide-18
SLIDE 18

$100+ million targeted savings across KMP, KML and FQMO Strategic contract reviews:

  • $40m targeted saving – 120 contracts ($800m) identified + renegotiation teams allocated.

Rapid sourcing:

  • $10m targeted savings – 20 vendors. Procurement of $100k to $2m per annum.

Warehousing and logistics:

  • $40m targeted savings – inventory management, freight and logistics.

Bottom up cost savings:

  • $10m targeted savings – usage, optimisation + waste elimination initiatives from the shop

floor. Consolidation of support services between sites:

  • Centres of excellence and back office functions.

First Quantum Zambia cost reductions

18

slide-19
SLIDE 19

Enterprise

19

slide-20
SLIDE 20

Maiden resource published December 2012:

  • Total measured indicated resource : 40.1Mt @ 1.07% Ni;
  • Mineral reserve: 32.7 Mt @ 1.10% Ni;
  • Potential to expand Resources at the Enterprise South West Zone

Operations:

  • Potential 38,000 – 60,000t Ni production per annum;
  • Construction approx 50% complete. Plant will commission on copper ore.

Enterprise Ni project - awaiting go ahead

20

Project go ahead for Enterprise is contingent on nickel price and concentrate export levy

slide-21
SLIDE 21

Power Project

21

slide-22
SLIDE 22
  • 160MW required for full operations
  • Softer ore reduces initial requirements
  • First Quantum has formally offered

support to ZESCO for augmenting supply

Power requirements for ramp-up

22 20 40 60 80 100 120 140 160 Oct-15 Nov-15 Dec-15 Jan-16 Feb-16 Mar-16

Average Power Requirement (MW)

slide-23
SLIDE 23

600km FQM/ZESCO 330kV powerlines Energising by end-October 2015

23

Lumwana – Kalumbila – Mumbwa Contractor Kalpataru Distance (km) 68 + 394 Towers 164 + 872 Mumbwa – Lusaka West Contractor KEC Distance (km) 134 Towers 298 Substations Kansanshi, Lumwana, Kalumbila ABB Lusaka West, Mumbwa NCC

slide-24
SLIDE 24
slide-25
SLIDE 25

Current situation:

  • Kafue (960MW) and Victoria Falls (100MW) turbines not affected;
  • Overuse of peaking turbines at Kariba (360MW peaking + 720MW baseload);
  • Delays to new generation projects (300MW Maamba coal + 120MW ITTZ).

Kariba drawdown, if turbines run at full rate:

  • Oct 2015 = ZESCO water allocation from Zambezi River Authority consumed;
  • Dec 2015 = 10% live capacity remaining;
  • Jan 2016 = seasonal recharge begins.

Management of supply + demand:

  • Makeup Power imports from Mozambique (200MW from Jul + 148MW from Sept);
  • ZESCO request for mines to use Makeup Power for 30% of load. Tariffs in discussion;
  • Subsequent announcements of Mopani + Baluba mine closures (200-250MW);
  • First Quantum has offered ZESCO support for Maamba + ITTZ grid connections.

Zambia power generation

25

slide-26
SLIDE 26

Town development

26

slide-27
SLIDE 27
  • 1. Home ownership is a cornerstone of economic empowerment:
  • Subsidised rent-to-own program – real economic empowerment starts at home:
  • Improves education;
  • Improves opportunities to start a business; and
  • Improves savings for retirement.
  • 2. The town will be a significant multiplier on job creation:
  • Sentinel will employ 3,064 direct and contractor personnel;
  • A multiplier of between 4-8 is possible for service industries in the town.
  • 3. Employee attraction and retention:
  • KML seeks a well-rested workforce who live locally and develop the area in

conjunction with the mine.

Why has FQM built a town?

27

Potential to move off balance sheet – strong interest from pension funds

slide-28
SLIDE 28

4-Bedroom House 3-Bedroom Housing Affordable Housing Layout 2-Bedroom House

Progress – housing

28

slide-29
SLIDE 29

Guesthouse Serviced Apartments Banking Services

Progress – commercial

Fuel Station

29

Kalumbila Industrial Park

slide-30
SLIDE 30

Progress – services

30

Children’s Playground and Sports Facilities Town Clinic Supermarket and Market Area Frontier Affordable School

slide-31
SLIDE 31

Community

31

slide-32
SLIDE 32
  • Education:
  • 5 GRZ schools refurbished in the Trident Project area;
  • Support with curriculum and textbooks.
  • Healthcare:
  • 5 GRZ rural health centres refurbished in the Trident Project area;
  • HIV awareness and VCT programs, plus malaria intervention.
  • Conservation farming:
  • Peak program expected over 2015/16 season of approx 1000 farmers.
  • Sawmill and furniture factory:
  • Providing skilled employment and producing school and other furniture.
  • Resettlement 99% complete.

Community development

32

2015 : community needs assessment for ongoing Trident Foundation CSR projects

slide-33
SLIDE 33

33

Healthcare Community Infrastructure Livelihoods Conservation Farming Wildlife Conservation Forest Conservation Education

The Trident Foundation
