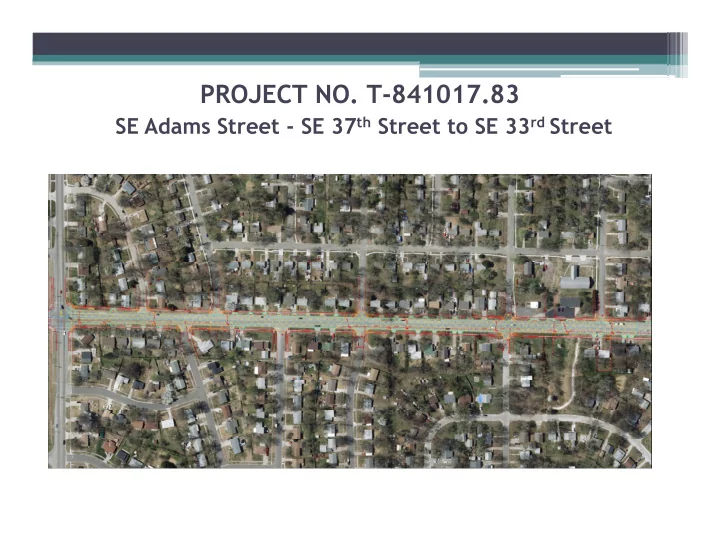

PROJECT NO. T-841017.83 SE Adams Street - SE 37 th Street to SE 33 rd - PowerPoint PPT Presentation

PROJECT NO. T-841017.83 SE Adams Street - SE 37 th Street to SE 33 rd Street Project Contacts City of Topeka Engineering Division Project Manager - Robert Bidwell, PE 368-3824 Community Information Manager - David Bevens 368-1642


  1. PROJECT NO. T-841017.83 SE Adams Street - SE 37 th Street to SE 33 rd Street

  2. Project Contacts City of Topeka – Engineering Division Project Manager - Robert Bidwell, PE – 368-3824 Community Information Manager - David Bevens – 368-1642 Consulting Engineer Finney & Turnipseed Transportation & Civil Engineering, L.L.C. Project Manager - Craig Mattox, PE, PLS – 235-2394 Project Engineer – Tim Reed, PE – 235-2394

  3. Project Scope of Work • Replace existing 8”+ concrete pavement and curb & gutter with new 10” Concrete Pavement and curb & gutter on an aggregate base including driveways (to the sidewalk) and sidewalk ramps at the intersections. • Replace deteriorated storm sewer inlets and inlet tops. • Replace existing corrugated metal storm sewer pipes with reinforced concrete pipe.

  4. Project Phasing • Road to be closed to thru traffic. Thru traffic will be carried on signed detour. • Properties abutting Adams between SE 37 st to SE 33 rd will be carried to side streets on existing pavement or one lane access roads to side streets. Once new pavement is in place, residents will park on the new pavement until the pavement and driveways in front of their properties is constructed.

  5. Project Detour Route

  6. Project Bus Detour Route Tentative • Regular route to 29 th & Adams (temporary bus stop) • West on 29 th to Freemont • South on Freemont to Golf Park • East on Golf Park to Colfax (Avondale-temporary bus stop) • East on Golf Park to Adams • North back onto normal route

  7. During Construction • Properties that abut Adams Street will have temporary mailboxes relocated to a central location as per the Post Master. Permanent mailboxes will be reinstalled after completion of the work. • Trash containers will be pick up weekly by the Contractor and taken to a location for disposal by the trash hauling companies. Make sure the cans are out when they are usually to be picked up. • If there is a problem or concern, seek out the Contractor’s superintendent or the project inspector first.

  8. Project Schedule The current schedule for the project is; • Late February 2019 – Let project • Late March 2019 – Start work • October 2019 – Project to be complete

  9. THANK YOU FOR COMING TODAY! QUESTIONS ?

Download Presentation
Download Policy: The content available on the website is offered to you 'AS IS' for your personal information and use only. It cannot be commercialized, licensed, or distributed on other websites without prior consent from the author. To download a presentation, simply click this link. If you encounter any difficulties during the download process, it's possible that the publisher has removed the file from their server.
