MOBILITY UPDATE N O RT H W E S T A U S T I N C O A L I T I O N F E B R U A RY 2 5 , 2 0 1 9 1 REGIONAL MOBILITY PROJECT UPDATES 2 ANDERSON MILL ROAD Final preliminary engineering report completed Sept. 2018 90% design by March


slide-1
SLIDE 1

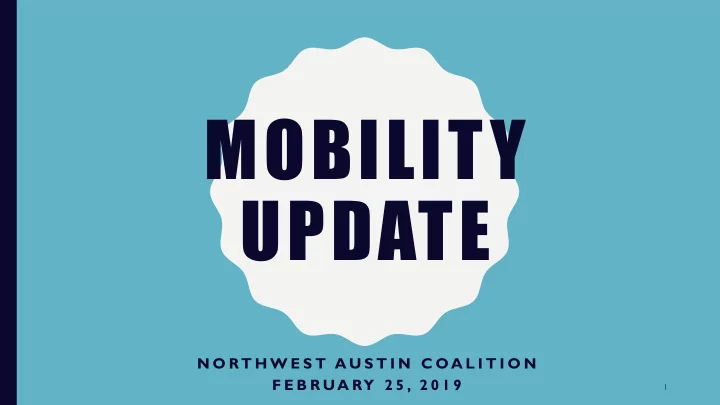

MOBILITY UPDATE

N O RT H W E S T A U S T I N C O A L I T I O N F E B R U A RY 2 5 , 2 0 1 9

1

slide-2
SLIDE 2

REGIONAL MOBILITY PROJECT UPDATES

2

slide-3
SLIDE 3

ANDERSON MILL ROAD

  • Final preliminary engineering

report completed Sept. 2018

  • 90% design by March 2019
  • Permitting process could last

just over a year

  • Bid process anticipated to

take 6 months

  • Earliest project could begin

construction would be summer 2020

3

slide-4
SLIDE 4

SPICEWOOD SPRINGS ROAD

  • Alternative C selected as the build

alternative – 2 vehicle lanes each direction – raised median and left-turn bays – shared use path on both sides – new stormwater facilities

  • Final preliminary engineering report

completed December 2018

  • Design phase of the project is now

underway

4

slide-5
SLIDE 5

RM 2222/RM 620 BYPASS

Project 1: RM 2222

(Bonaventure Dr to Ribelin Ranch Dr)

– Construction already underway – Anticipated completion: mid-2020 – Construction cost: $17.4 million Project 2: RM 620

(Steiner Ranch Blvd to RM 2222)

– Construction start: Fall 2019 – Anticipated completion: Winter 2020 – Construction cost: $10 million

5

slide-6
SLIDE 6

PARMER LANE

Proposed Improvements – 3 lanes in each direction – Improve intersections and turn lanes – Dedicated bicycle/pedestrian path Project Development Timeline – Preliminary Design: 2019 – Final Design/Engineering: 2020 – Utility Relocation: 2021 – Estimated Construction Start: 2022

6

slide-7
SLIDE 7

2016 MOBILITY BOND UPDATE

Regional Mobility: $101 million to address regional congestion and enhance safety Corridor Mobility: $482 million for corridor improvement projects Local Mobility: $137 million to local mobility projects, including:

– Sidewalks – Safe Routes to School – Urban Trails – Bikeways – Vision Zero – Sub-standard Streets

7

slide-8
SLIDE 8

MOBILITY PLANNING ACTIVATES

8

slide-9
SLIDE 9

AUSTIN STRATEGIC MOBILITY PLAN (ASMP)

Final ASMP draft released on Feb. 22nd ASMP to be adopted later this spring Important Dates – Council Mobility Committee:

  • Feb. 28th 1:00-3:00 pm

– Planning Commission:

  • March 12th 6:00 pm (Public Hearing)
  • March 26th 6:00 pm

– City Council

  • March 28th (Public Hearing)

9

slide-10
SLIDE 10

PROJECT CONNECT

  • CapMetro to adopt Public Engagement

Plan in Spring 2019

  • High Capacity Transit
  • Service Type

– Commuter Service – Local Service

  • Important Dates

– Joint Meeting of the City Council and Capital Metro Board: March 4th

10

slide-11
SLIDE 11

CAPITAL AREA METROPOLITAN PLANNING ORGANIZATION (CAMPO)

  • May 2018 adopted the 2019-2022 TIP

– Secured $13.7 million for Lakeline Blvd

  • Project Improvements:

– Add two additional travel lanes – Upgrade bicycle facilities and sidewalks

11

slide-12
SLIDE 12

RM 620 COLORADO RIVER TO US 183

  • RM 2222/RM 620 Bypass Project

– Project 1: RM 2222 - Construction already underway – Project 2: RM 620 - Construction start: Fall 2019

  • RM 620/Anderson Mill Intersection

– Study in progress

  • RM 620 - Anderson Mill Rd to US 183

– Discussions on going for this segment

12

slide-13
SLIDE 13

COMMUNITY PLACEMAKING TOOLKIT

Working with City Staff to develop a Community PlacemakingToolkit

13

slide-14
SLIDE 14

DISTRICT 6 NEWSLETTER

Get ongoing updates from the D6 office on community events and the latest from City Hall! Subscribe today by visiting: http://www.atxd6.org/contact/ subscribe/

14
