Heavy Haul Transportation Corridor Open House Ron Heustis, PE - - PowerPoint PPT Presentation

heavy haul transportation corridor open house
SMART_READER_LITE
LIVE PREVIEW

Heavy Haul Transportation Corridor Open House Ron Heustis, PE - - PowerPoint PPT Presentation

Heavy Haul Transportation Corridor Open House Ron Heustis, PE Project Manager, INDOT Project Team Indiana Department of Transportation Federal Highway Administration City of Jeffersonville Clark County Indiana Economic


slide-1
SLIDE 1

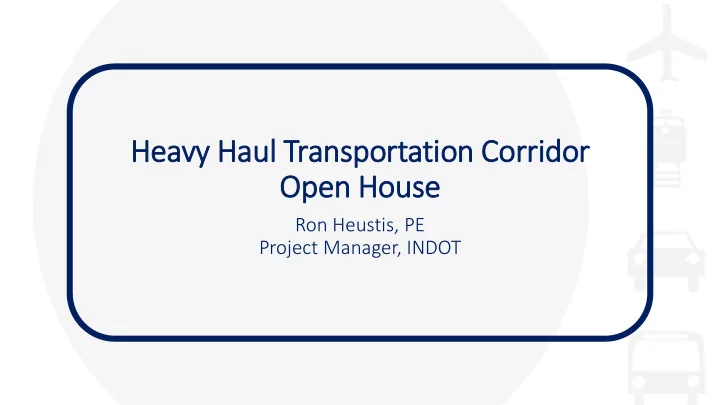

Heavy Haul Transportation Corridor Open House

Ron Heustis, PE Project Manager, INDOT

slide-2
SLIDE 2

Project Team

  • Indiana Department of Transportation
  • Federal Highway Administration
  • City of Jeffersonville
  • Clark County
  • Indiana Economic Development Corporation
  • Ports of Indiana
  • River Ridge Development Authority
  • United Consulting
  • American Structurepoint
slide-3
SLIDE 3

Meeting Agenda

  • Public Information Meeting
  • Alternatives for Consideration
  • Proposed Project Schedule
  • Alternatives Screening Matrix
  • Land Acquisition Process
  • Open House
slide-4
SLIDE 4

Alternatives Development

  • All alternatives are initially developed based on engineering considerations

specific to the proposed project (speed, vehicles, known site conditions)

  • Consideration given to constructability, including factors such as deviations from

standards, accessibility to site, traffic maintenance, unusual construction techniques required

  • Design Criteria
  • New 2-lane roadway or sufficient capacity for additional demand on existing alternatives
  • Designed to Heavy Haul standards (maximum vehicle weight of 134,000 lbs)
  • 35-mph speed limit
slide-5
SLIDE 5

Alternatives Development (cont.)

  • Existing infrastructure alternatives
  • Widen and reconstruct Port Road (Alternate Port Road)
  • Additional capacity required
  • Additional pavement structure required for Heavy Haul vehicles
  • Widen SR 265 over Lentzier Creek tributary for extension of acceleration lane
  • Utica Pike and Old Salem Road alternatives (Alternatives A1 and A2)
  • Widen and reconstruct Utica Pike and Old Salem Road
  • Additional capacity required
  • Additional pavement structure required for Heavy Haul vehicles
  • Address roadway grades that exceed allowable grade for Heavy Haul vehicles
slide-6
SLIDE 6

Alternatives Development (cont.)

  • New terrain alternatives
  • Alternates B, C, D, E, F, G, DE, HH
  • New 2-lane roadway
  • New bridge over Lentzier Creek
slide-7
SLIDE 7

Alternatives Development (cont.)

  • Alternatives A1, A2, and B
  • Based on connectivity, engineering considerations and environmental information

available to desktop review

  • Alternatives C, D, E, F, G
  • Changes made based on initial input from resource agencies and field investigations
  • Alternatives DE, HH
  • Further changes made based on additional input from resource agencies and additional

field investigations

slide-8
SLIDE 8
slide-9
SLIDE 9

Proposed Project Schedule

Project schedule may be adjusted due to environmental, land acquisition, or other circumstances

  • Envir

ironmental started in second quarter of 2014 and continues to first quarter

  • f 2018
  • Desig

sign started in first quarter of 2016 and continues to second quarter of 2019

  • Rig

ight-of

  • f-way acquisition starts in first quarter of 2018 and continues to second

quarter of 2019

  • Co

Constructio ion starts in third quarter of 2019 and continues into fourth quarter of 2020.

slide-10
SLIDE 10

Regional Projects Proposed Timeline

Regional Projects Proposed Timeline

Project Phase Budget 1st Qtr 2nd Qtr 3rd Qtr 4th Qtr 1st Qtr 2nd Qtr 3rd Qtr 4th Qtr 1st Qtr 2nd Qtr 3rd Qtr 4th Qtr 1st Qtr 2nd Qtr 3rd Qtr 4th Qtr Environmental Design Land Acquisition Construction Design complete Land Acquisition complete Construction complete Environmental Design Land Acquisition Design complete Land Acquisition complete Construction complete Design complete Land Acquisition Construction Ohio River Bridges East End Crossing $ 1.05B Old Salem Road $ 3.7M Transportation Corridor Segment A $ 18.6M Transportation Corridor Segment B $ 10.5M Transportation Corridor Segment C $ 1.3M 2020 2017 2018 2019

slide-11
SLIDE 11

Alternative Screening Matrix

  • Working to identify a preferred alternative
  • Considerations
  • Purpose and need
  • Environmental
  • Engineering
slide-12
SLIDE 12

Alternative Screening Matrix (cont.)

  • Purpose and Need
  • Does alternative provide connectivity between existing infrastructure and major traffic

generators?

  • Does the alternative address inadequate system connection south of the SR 265/Old

Salem Road interchange?

  • Will the infrastructure be designed to effectively handle Heavy Haul vehicles?
slide-13
SLIDE 13
  • Environmental considerations
  • Archaeological
  • Environmental justice
  • Farmland
  • Forest
  • Hazardous materials sites
  • Historic properties
  • Karst
  • Noise
  • New permanent right-of-way
  • Residential/business relocations
  • Section 4(f) property use
  • Streams
  • Surface water
  • Wetlands

Alternative Screening Matrix (cont.)

slide-14
SLIDE 14
  • Engineering considerations
  • Constructability
  • Estimated cost
  • Length
  • New construction
  • Structure length

Alternative Screening Matrix (cont.)

slide-15
SLIDE 15

Community Involvement Status

  • Public information meetings
  • Citizens Advisory Committee (CAC)
  • Group of individuals serving as representatives of their local community acting as liaisons

(neighborhood organizations, first responders, schools, etc.)

  • Play important advisory role in developing a project that might better “fit” into your

community

  • INDOT and FHWA maintain final authority and responsibility for decision making
  • CAC meeting to be scheduled within next 3 to 6 months
slide-16
SLIDE 16

Land Acquisition Process

  • How land is purchased by local agencies – explains the process
  • f buying property needed for highway improvements
  • Land acquisition process must follow the Uniform Act of 1970
  • Uniform Act of 1970
  • All federal, state, and local governments must comply
  • Requires just compensation
  • Acquisition process
  • Appraisals
  • Review appraisals
  • Negotiations (buying)
  • Amount of compensation cannot be less than fair market value
slide-17
SLIDE 17

Land Acquisition Process (cont.)

  • Partial acquisition
  • Agency will state amount to be paid of the part of the land to be acquired.
  • Separate amount will be stated for damages to the portion retained.
  • If remainder has little or no value, agency will consider purchasing remainder.
  • Agreement
  • When agreement is reached, owner will be asked to sign an option to buy, purchase

agreement, easement, or deed.

  • No agreement
  • Mediation
  • Condemnation
slide-18
SLIDE 18

Feel fr free to view visuals and project layout displayed around the room and ask project questions to the Transportation Corridor Team.
