Goals Progress Vision Success In 2003 concerned property owners - - PowerPoint PPT Presentation

goals
SMART_READER_LITE
LIVE PREVIEW

Goals Progress Vision Success In 2003 concerned property owners - - PowerPoint PPT Presentation

Transportation Landscape & Improvements 2005 LCI Study Recommendations Over $2M invested in Landscape & Street Scape Removal of Reversible Lanes Improvements Collector Roads & Progress Improved Corridor


slide-1
SLIDE 1

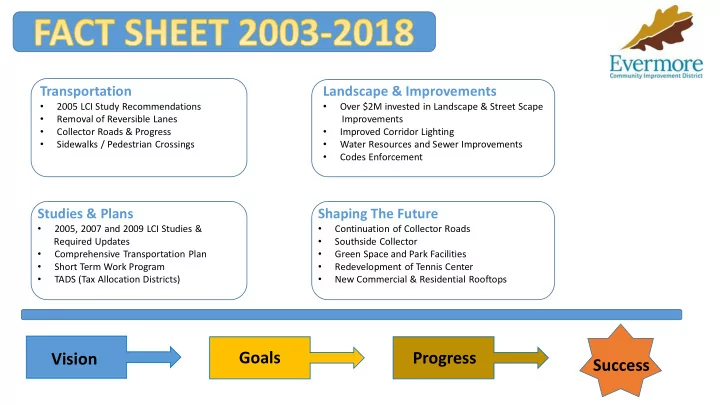

Transportation

  • 2005 LCI Study Recommendations
  • Removal of Reversible Lanes
  • Collector Roads & Progress
  • Sidewalks / Pedestrian Crossings

Studies & Plans

  • 2005, 2007 and 2009 LCI Studies &

Required Updates

  • Comprehensive Transportation Plan
  • Short Term Work Program
  • TADS (Tax Allocation Districts)

Landscape & Improvements

  • Over $2M invested in Landscape & Street Scape

Improvements

  • Improved Corridor Lighting
  • Water Resources and Sewer Improvements
  • Codes Enforcement

Shaping The Future

  • Continuation of Collector Roads
  • Southside Collector
  • Green Space and Park Facilities
  • Redevelopment of Tennis Center
  • New Commercial & Residential Rooftops

Vision Goals Progress Success

slide-2
SLIDE 2

Originally called the Highway 78 CID it’s founding Board of Directors included: Emory Morsberger u Larry Pearson u Forrest Adair u Kenny King u Art Mezzullo u Dean Robinson u Dwight Harrison uBill Gower In February 2007 the board voted to change the organization’s name to Evermore CID. In a nod to the history of the community a new logo and slogan were developed which incorporated the CID vision for the future with a remembrance of the past.

In 2003 concerned property owners formed the 1st CID in Gwinnett County.

slide-3
SLIDE 3

In 2007 GDOT removed the reversible lanes from Highway 78, replacing it with divided median. The CID worked closely with GDOT to achieve a higher aesthetic than traditional median highways, while preserving the ability for commuters to travel safely and access local area businesses. Decel lanes, sidewalks, pedestrian crossings, and landscaping added significant change to a traditional 7 lane highway.

BEFORE AFTER

Project Cost: $66,000,000 Sources: Gwinnett County, Federal & State

slide-4
SLIDE 4

Open to traffic in 2016, the roadway features a signalized intersection, new roadbed with curb/gutter and improved access to homes and businesses at the intersection. As Phase I of Evermore North Boulevard it’s the first of four phases which will provide approximately 4 miles of collector roadway parallel to Highway 78. The project was first identified in the 2005 LCI Study. The realignment focused on creating a true 900 intersection at Walton Court and Old Highway 78.

Project Cost: $1.7M

slide-5
SLIDE 5

Once complete (Fall 2018) the roadway will provide commuters with an alternate access route, which will become the Hewatt/Parkwood/Britt Collector. This project is a continuation of Walton Court which will extend over Highpoint Road and terminate at Britt Drive. This project will feature many of the same elements as Walton Court, with a notable exception

  • f a Roundabout at

Highpoint.

Project Cost: $3.7M

slide-6
SLIDE 6

aka: Hewatt / Parkwood / Britt

Project Cost: $17.2M

slide-7
SLIDE 7

This project provides full access to US 78 for those residents which utilized Cambridge Street. Further, the project reduced the number of conflict points along the US 78 corridor by eliminating the need for U-turn movements, which works to improve mobility and enhance safety. In order to promote pedestrian activity at this location, sidewalks, pedestrian crossings, pedestrian refuge islands and landscaped buffers were included in the design for this project. An exciting result of this project was the demolition

  • f a former RV dealer to make way for a

the second of it’s kind in Georgia.

Wal Mart Neighborhood Market

Project Cost: $1.5M

slide-8
SLIDE 8

During the removal of the reversible lane system along US 78, sidewalks within the project area were reduced from four to three feet in this location, creating a dangerous proximity for pedestrians to US 78 vehicular traffic. The Yellow River Bridge was constructed to provide a parallel pedestrian crossing at the Yellow River, creating a safe transportation alternative. Utilizing both Public and Private funds, the purpose of this project was to construct a public, central sewer system serving the properties between the Yellow River and Jessica Daron Court. Project Cost: $886,000 Project Cost: $598,000

slide-9
SLIDE 9

2005 2007 2011

slide-10
SLIDE 10

The node projects provide character enhancements, landscaping, and improved pedestrian access to 5 major intersections along the Corridor.

YELLOW RIVER

2

slide-11
SLIDE 11
slide-12
SLIDE 12

Intelligent Transportation Signalization Decorative Mast Arms and Illuminated Street Signage GRTA Xpress Bus Service Sidewalks throughout the CID Pedestrian islands throughout the CID

slide-13
SLIDE 13
slide-14
SLIDE 14

Tax Year Assessed Value Taxes Levied % Increase $ Increase 2004 $155,699,410 778,497 100% 778,497 2005 $163,484,380 817,422 5% 38,925 2006 $168,388,911 841,945 3% 24,523 2007 $186,261,000 931,305 11% 89,360 2008 $203,053,230 1,015,266 9% 83,961 2009 $205,734,596 1,028,673

  • 18%
  • 192,238

2010 $181,914,436 909,572 11% 86,634 2011 $171,075,040 855,375

  • 6%
  • 54,197

2012 $157,556,680 787,783

  • 8%
  • 67,592

2013 $168,549,250 842,746 7% 54,963 2014 $163,872,160 819,360

  • 3%
  • 23,386

2015 $165,878,280 829,391 1% 10,031 2016 $167,184,120 835,920 1% 6,529 2017 $169,621,716 848,108 1% 12,188

2004 – 2017 Millage Rates

 Collected approximately $12,141,363 in Property Taxes since 2004  Received approximately $8M in Federal Funding  Received approximately $403,000 in Grant Funding ($283,000-ARC; $80,000-Tennis Center LCI; $40,000-Walton Ct LCI)  Received approximately $2,164,000 in State Transportation Funding ($500,000-LMIG; $1,614,000 – SRTA; $50,000-GateWay)  Received approximately $5.1 million in SPLOST Funds (2005 & 2009)

slide-15
SLIDE 15

200,000 400,000 600,000 800,000 1,000,000 1,200,000 2004 2005 2006 2007 2008 2009 2010 2011 2012 2013 2014 2015 2016

slide-16
SLIDE 16

53%

Local Match to Subsidize and attract other funding

750+

New Home Starts

$35M

Capital Improvement Program

$2.7M

Total Amount Spent on Landscaping over 14 years

151,000

Population within the CID

$94K

Average Household income within the CID

slide-17
SLIDE 17
slide-18
SLIDE 18
slide-19
SLIDE 19
slide-20
SLIDE 20
slide-21
SLIDE 21
slide-22
SLIDE 22

‘03 ‘04 ‘05 ‘06 ‘07 ‘08 ‘09 ‘10 ‘11 ‘12 ‘13 ‘14 ‘15 ‘16 ‘17 ‘18

  • Creation of Highway 78 CID
  • 2005 LCI Study
  • Evermore North Blvd.
  • Sewer Improvements
  • Hewatt/Parkwood/Britt
  • Comprehensive Transportation Plan
slide-23
SLIDE 23

As we celebrate our 15 year anniversary, the CID continues to develop creative, innovative strategies aimed at improved transportation, access to commercial businesses and a quality of life for those who live, work, play, and shop along Highway 78.

What can be accomplished in another 15 years??
