SLIDE 1
Glenshire Truckee River Enhancement Project Truckee River Basin - - PowerPoint PPT Presentation
Glenshire Truckee River Enhancement Project Truckee River Basin - - PowerPoint PPT Presentation

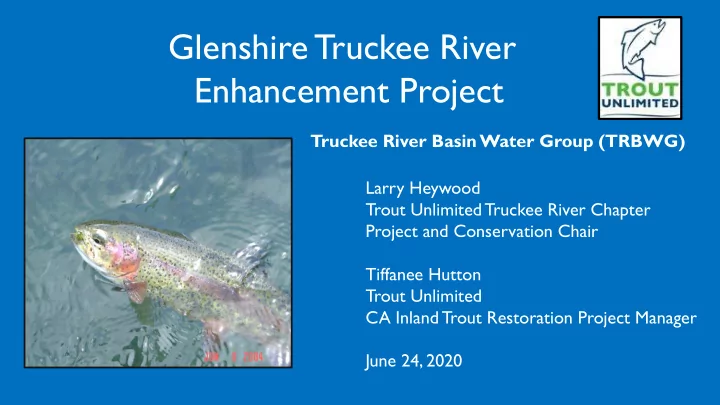

Glenshire Truckee River Enhancement Project Truckee River Basin Water Group (TRBWG) Larry Heywood Trout Unlimited Truckee River Chapter Project and Conservation Chair Tiffanee Hutton Trout Unlimited CA Inland Trout Restoration Project
SLIDE 2
SLIDE 3
Horners Corner
SLIDE 4
Project Area
Glenshire Truckee River Enhancement Project Location Map
Ice Ponds Glenshire Bridge
SLIDE 5
Sewer Line River Crossing Boulder Source Glenshire Rd
SLIDE 6
Toilet Bowl
SLIDE 7
Site Selection
- Lacks Structure and Fish Habitat
- Embedded Substrate
- Slow, Flay & Warm
- Limited Fish & Bug Population
- Limited Fishing
- Possibly the Result of Ice Making
- Sewer line Construction
SLIDE 8
Site Selection
- Property Ownership
- Cal Wildlife Area
- Construction Access
- Permitting Complexity
- Cost
SLIDE 9
Ice Harvesting at Polaris
SLIDE 10
Polaris
SLIDE 11
SLIDE 12
Project Design
SLIDE 13
Weir Details
SLIDE 14
Instream Construction
SLIDE 15
How to Fish a Weir
SLIDE 16
Sewer Line Boulder Source
SLIDE 17
T emporary Supply Route and River Access
SLIDE 18
Union Pacific Permission to Cross Tracks
SLIDE 19
State Wildlife Area Right of Entry
SLIDE 20
Categorical Exemption.
- 15333. Small Habitat Restoration Projects
Project is less than five acres in size and ensures the maintenance, restoration, enhancement, and protection
- f habitat for fish,
plants, and wildlife of the Truckee River. Project meets conditions a-d in section 15333 of the CEQA guidelines.
SLIDE 21
Monitoring
- Water Quality
- Construction Monitoring
- Fish Surveys
- Macro Invertebrate Surveys
- Habitat Typing Analysis
- Vegetation Surveys
- Photo Monitoring
SLIDE 22
Fish Snorkel Survey
Pre Construction Post Construction 2021 2022
Macro Invertebrate Survey
Pre Construction Post Construction 2022
SLIDE 23
Water Flows
Permit Requirement
200 CFS or less
Primary Inputs
Lake Tahoe Donner Creek
SLIDE 24
Projected Flows September Construction
We’re Requesting Low Floats During Construction
SLIDE 25
