GEORGINA ISLAND Roads Upgrade and Drainage Project Presentation to - - PowerPoint PPT Presentation

georgina island
SMART_READER_LITE
LIVE PREVIEW

GEORGINA ISLAND Roads Upgrade and Drainage Project Presentation to - - PowerPoint PPT Presentation

GEORGINA ISLAND Roads Upgrade and Drainage Project Presentation to The Community March 4, 2014 Introduction C.C. Tatham & Associates Ltd. (CCTA) retained by Georgina Island First Nation (GIFN) to provide professional engineering


slide-1
SLIDE 1

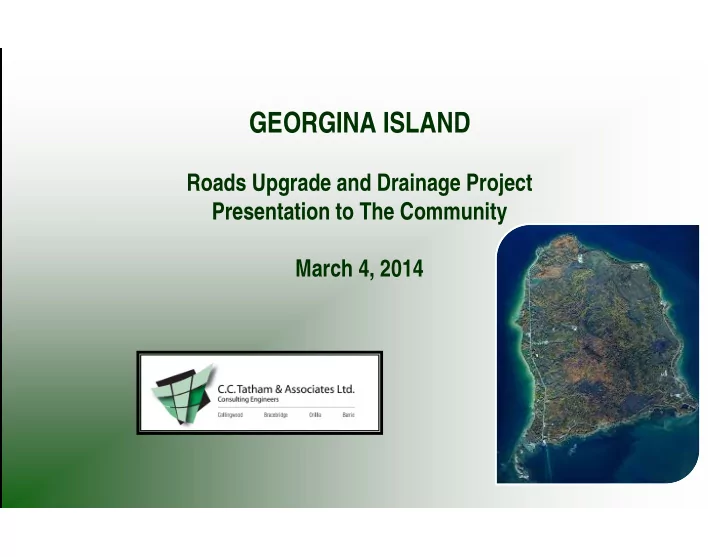

GEORGINA ISLAND

Roads Upgrade and Drainage Project Presentation to The Community March 4, 2014

slide-2
SLIDE 2

2

Introduction

C.C. Tatham & Associates Ltd. (CCTA) retained by Georgina Island First Nation (GIFN) to provide professional engineering services for upgrading of approximately 10 km of roads;

Introduction

Project includes:

Assessment of existing roadway conditions;

Chief Joseph Snake Road, Loon Road, Bear Road and Root Road;

LVM Inc. providing geotechnical advice.

 Sidewalk recommendations;  Cost estimates;  Drainage improvements;  Life cycle analysis;  Recommendations for cost effective reconstruction options;

slide-3
SLIDE 3

3

Drainage Overview

Regrading and culvert replacement to provide uniform unobstructed ditches will improve surface drainage;

Chief Joseph Snake Road, Bear Road and Root Road

Drainage Review

Drainage outlets are blocked or missing, restricting flow;

Existing ditching is poorly defined, shallow and overgrown;

Drainage concerns between Chief Joseph Snake Road, Turtle Road and the lake related to low topography and maintenance needs;

Outlet improvement at campground on Bear Road.

slide-4
SLIDE 4

4

Road Overview

slide-5
SLIDE 5

5

Road Overview

Ditching exists only on southwest side, poorly defined and overgrown;

Loon Road

Install a French drain on northeast side to collect road surface runoff, discharging to southwest ditch;

Regrade southwest ditch to a uniform positive grade.

slide-6
SLIDE 6

6

Geotechnical Evaluation

Thorough evaluation of current roadway conditions:

LVM Investigation

Roadway distresses;

Granular base/subbase/surface treatment depths;

Road structure materials.

Distresses related to:

Relatively flat road profiles;

Proximity to wetlands;

Undefined outlets and high lake levels relative to road ditches and road bases;

Existing road structure is shallow, substandard granular material;

Concluded existing pavements are well beyond their functional service lives and major rehabilitation is required.

slide-7
SLIDE 7

7

Rehabilitation Options

 Place 100 mm granular material over existing pavement (utilizing material

quarried on site if available);

Rehabilitation Method - Foamed Asphalt Stabilization

 Pulverize granular material and existing road structure to depth of 225

mm;

 Stabilize pavement surface with expanded (foamed) asphalt to depth of

150 mm;

 Double layer surface treatment;  Regrade all ditches and replace driveway

and road cross culverts.

slide-8
SLIDE 8

8

Rehabilitation Options

 Full depth excavation;

Other Rehabilitation Options and Lifecycle Analysis

 Pulverize asphalt;  Mechanical reinforcement.  Considers initial capital cost plus 20 years of maintenance;  Full depth reconstruction has highest capital cost and 2nd highest

maintenance cost with crack sealing and repaving in year 15;

 Pulverizing has lowest capital cost and highest maintenance cost with

annual spray patching and surface treatment in years 8 and 16;

 Foamed asphalt stabilization has 2nd lowest capital cost and lowest

maintenance cost with surface treatment in years 10 and 20;

 Foamed asphalt stabilization is the most cost effective.

slide-9
SLIDE 9

9

Cost Estimates

 Foamed Asphalt Stabilization $ 5,560,000;

Construction Cost Estimates

 Includes 10% contingency;  Includes all drainage improvements within roadway;  Assumes imported granular material, may be reduced by use of on-site

quarries;

 Does not include sidewalk costs;  Does not include outlet cleaning/improvements.

slide-10
SLIDE 10

10

Sidewalk

Sidewalk

 1.5 m widening of south bound lane of road;  Low traffic volumes and speeds minimize safety concerns;  Delineation of the walkway by line painting;  Winter maintenance completed by existing snow removal equipment;  Does not alter the established drainage patterns;  Does not require work beyond the right-of-way;  Estimated construction cost approximately $392,000.

slide-11
SLIDE 11

11

Sidewalk

slide-12
SLIDE 12

12

Summary

 Foamed asphalt stabilization with double surface treatment;

Summary

 Most cost effective rehabilitative method to provide adequate structural

capacity and meet functional service life expectations;

 Rehabilitates existing road structure and minimizes placement of new

granulars, thereby reducing costs;

 Double surface treatment for hard surfacing is a cost effective alternative

to hot mix asphalt and provides more flexibility during movement of the subgrade due to frost actions and spring thaw;

 Existing granular quarry material may be suitable for this rehabilitation

method and result in further cost savings.

slide-13
SLIDE 13

13

Next Steps

 GIFN confirm preferred solution and construction schedule (2014/2015);

Next Steps

 Liaison with agencies (MNR, DFO, LSRCA);  Survey drainage outlets;  Assess quality and quantity of island quarry material;  Prepare final design and tender documents;  Circulate to invited contractors for tendering;  Contract award and construction.

slide-14
SLIDE 14

14

Contact Information

Ted Kruska, C.E.T., Project Manager C.C. Tatham & Associates Ltd. t: (705)325-1753 x 225 f: 705)325-7420 e: tkruska@cctatham.com Tim Collingwood, B.A.Sc., P.Eng., Director, Manager – Orillia Branch C.C. Tatham & Associates Ltd. t: (705)325-1753 x 224 f: (705)325-7420 e: tcollingwood@cctatham.com

 Have all of your questions been addressed?

Before You Leave: For Further Information:
